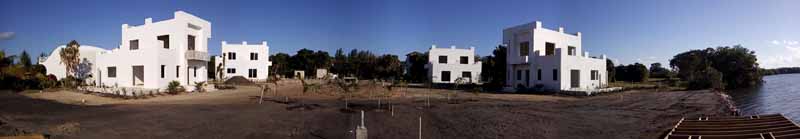

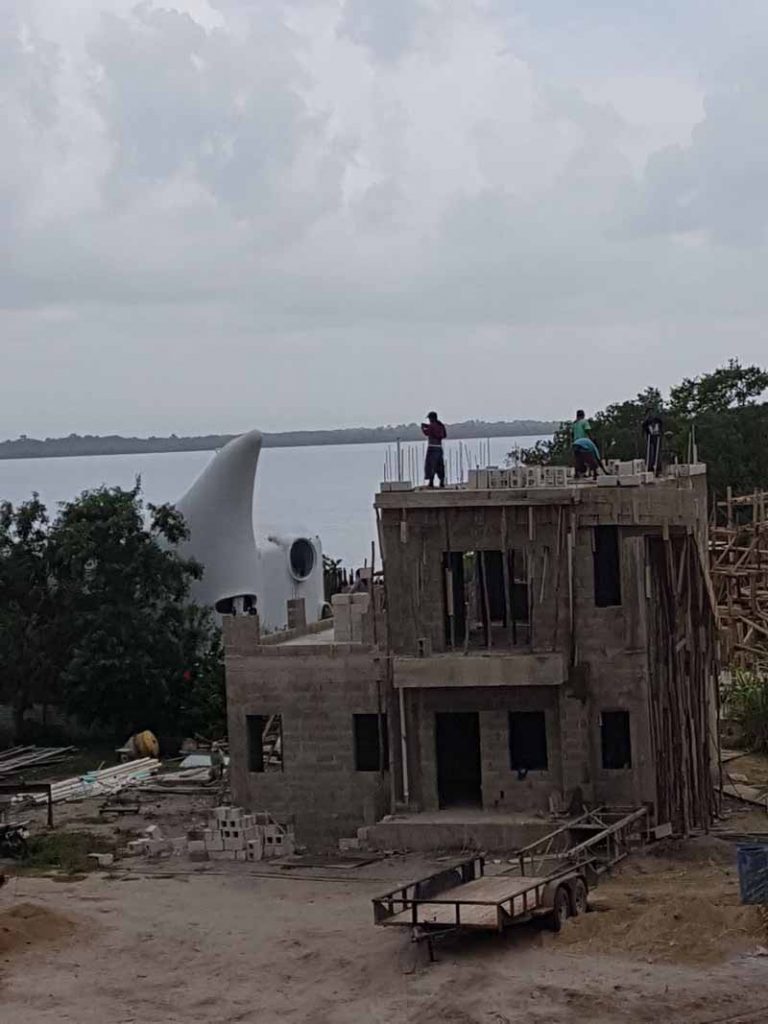

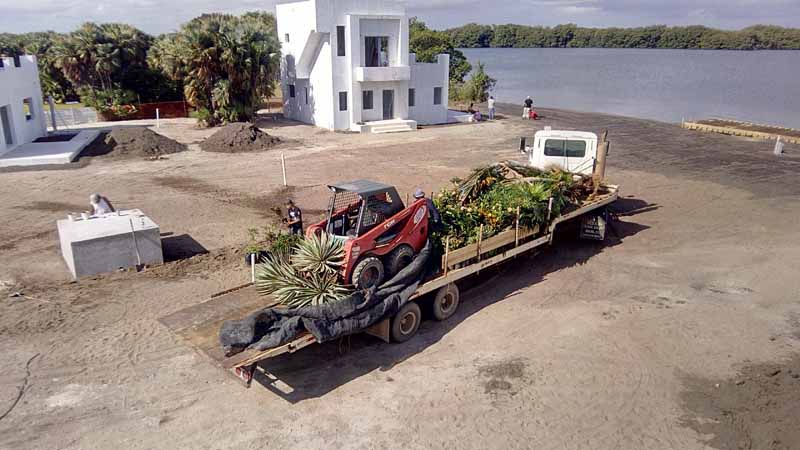

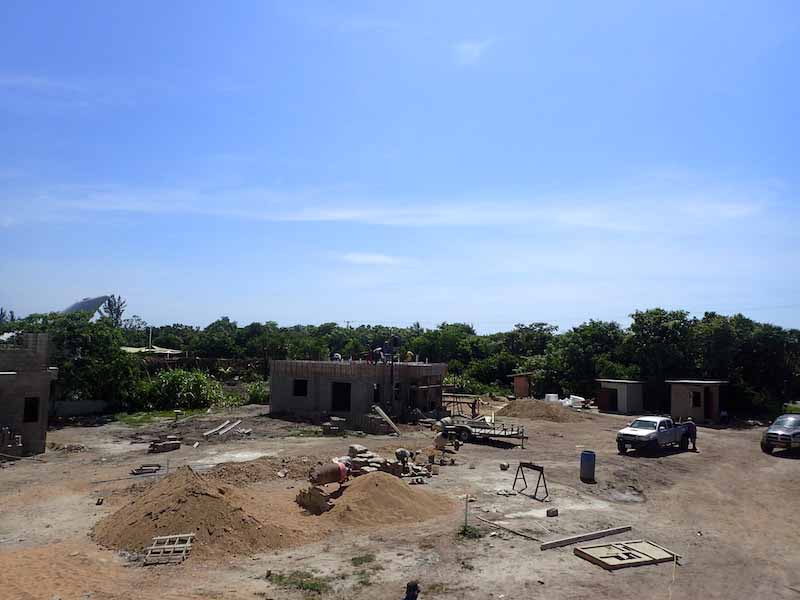

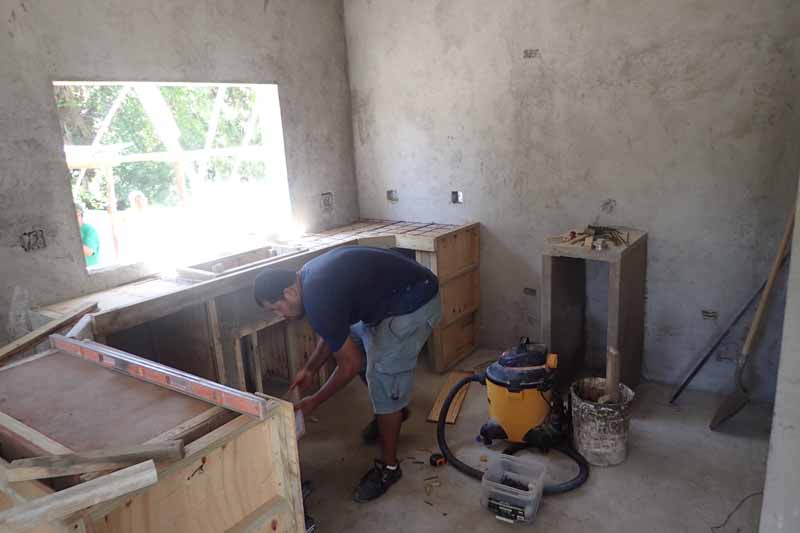

The timeline below will be updated throughout the project with newer items added to the top of the page. You can click a photo to view a larger image of it. I have not taken the time to caption each of these images but if you have a question please do not hesitate to write.

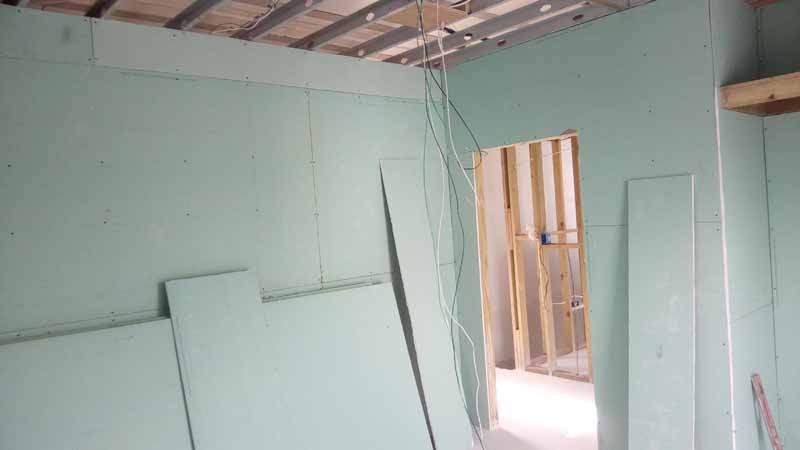

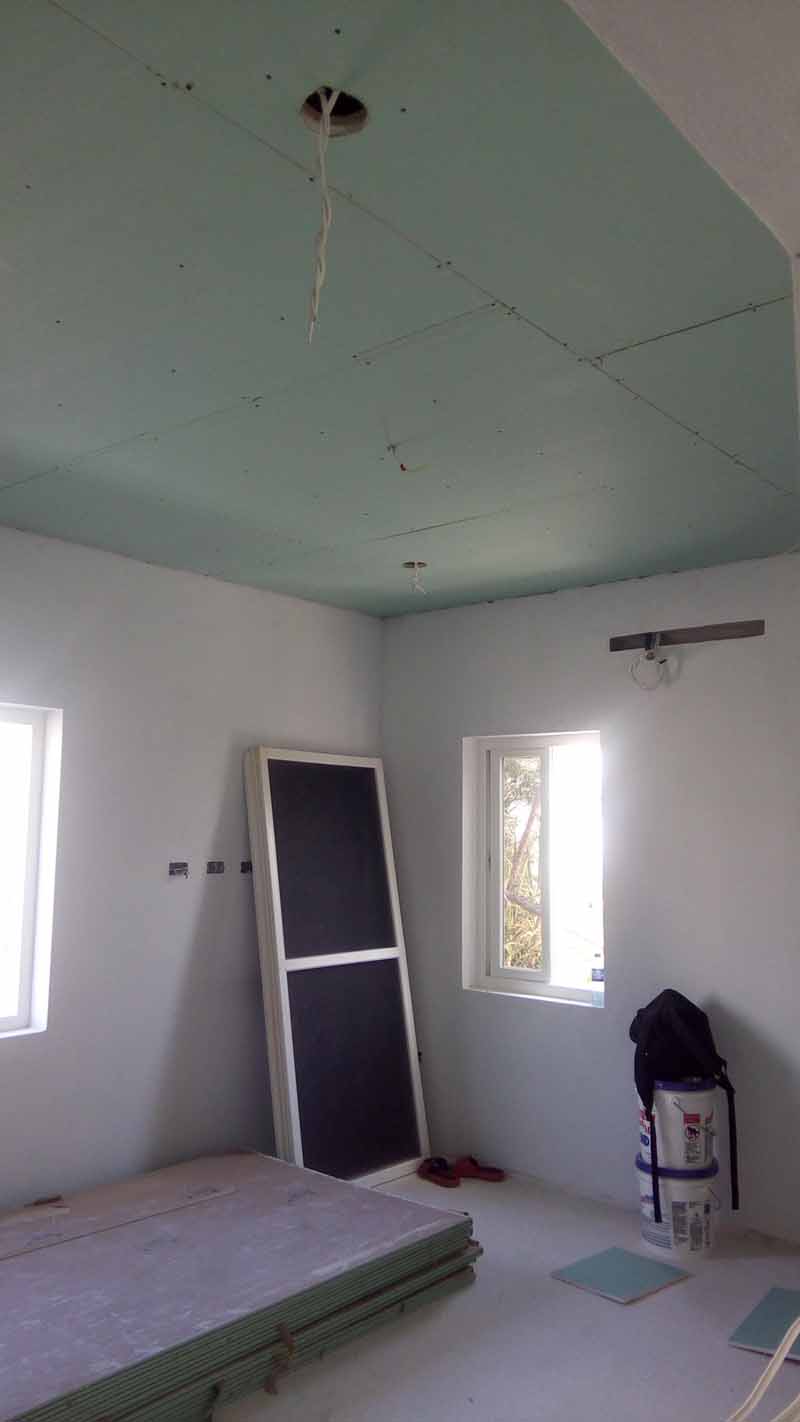

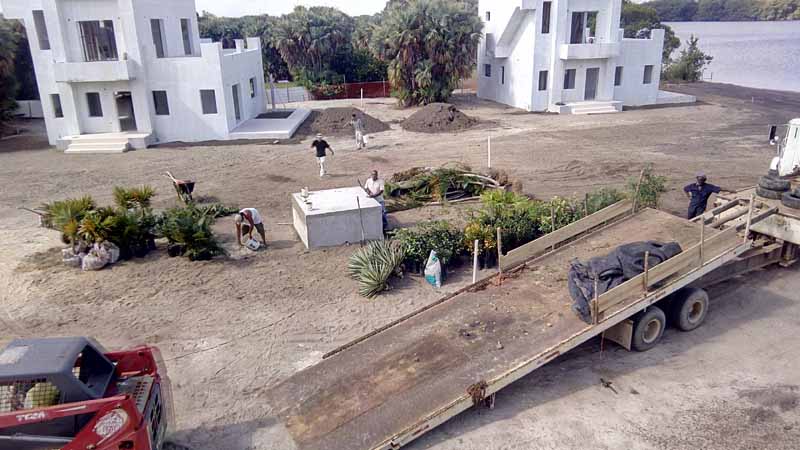

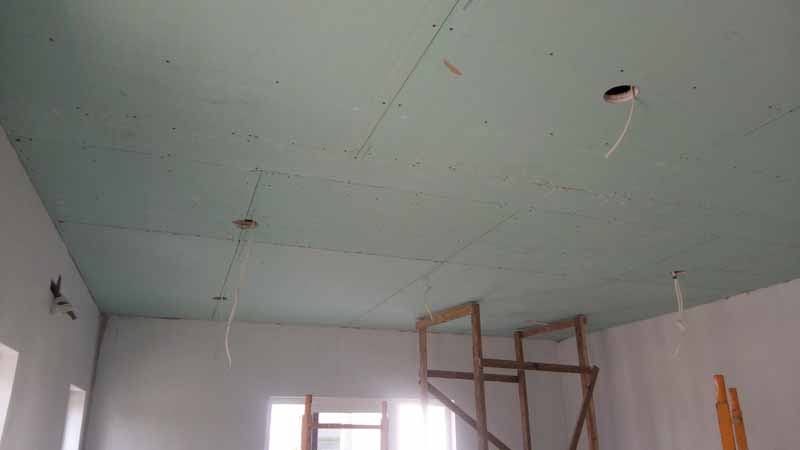

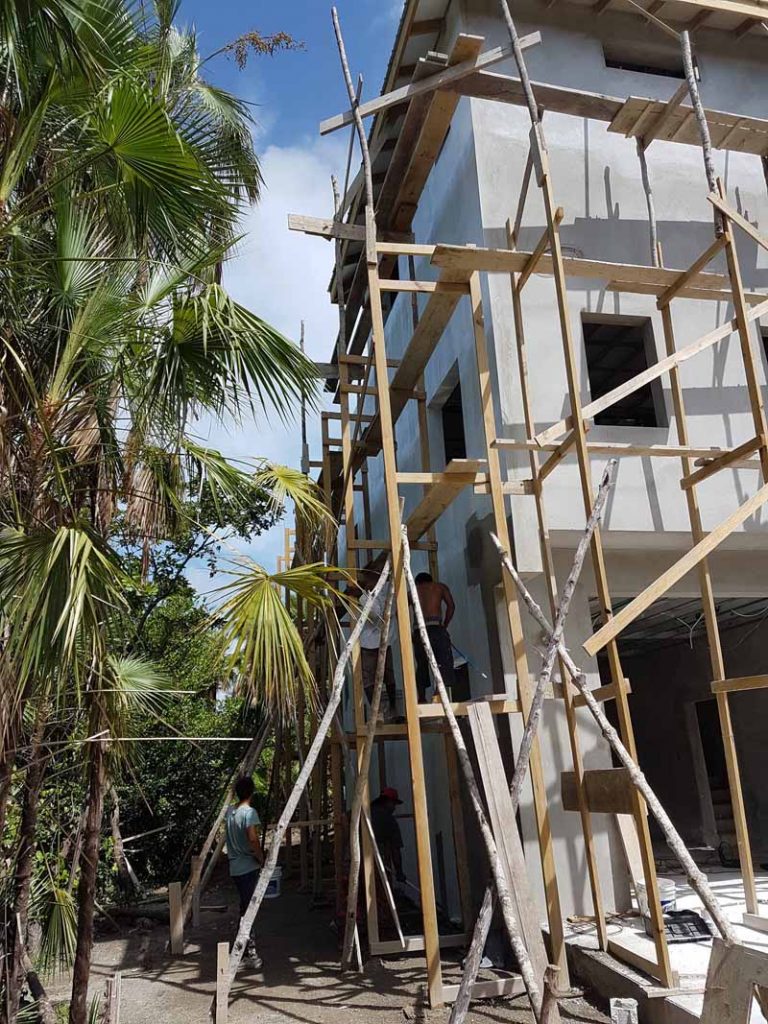

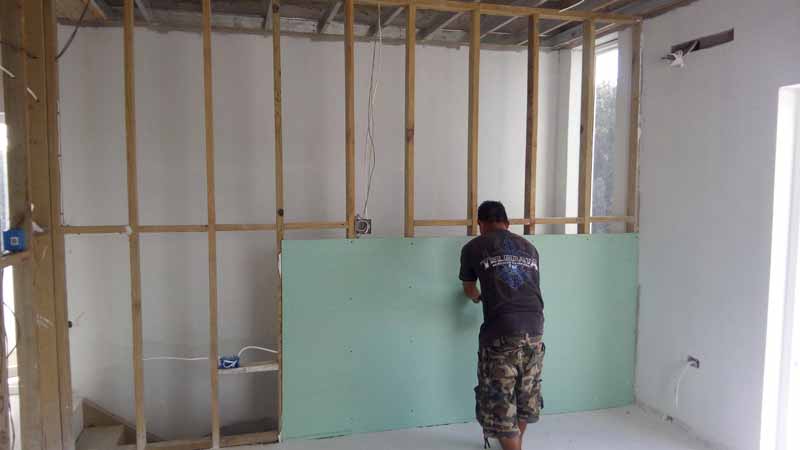

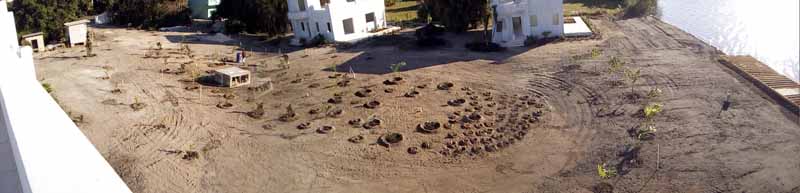

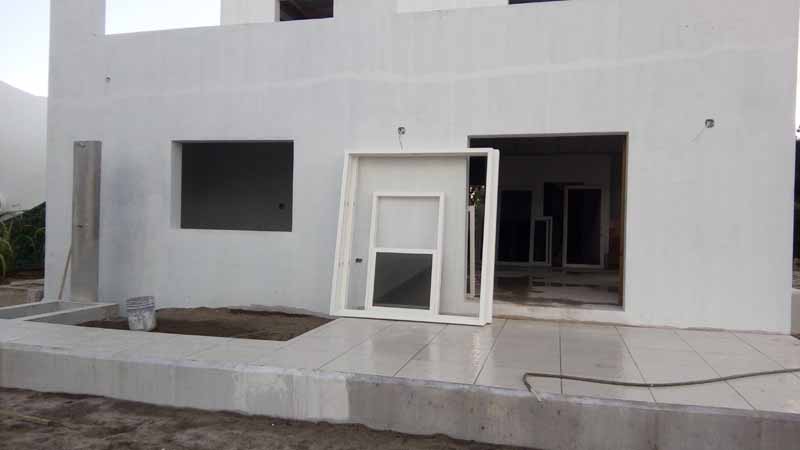

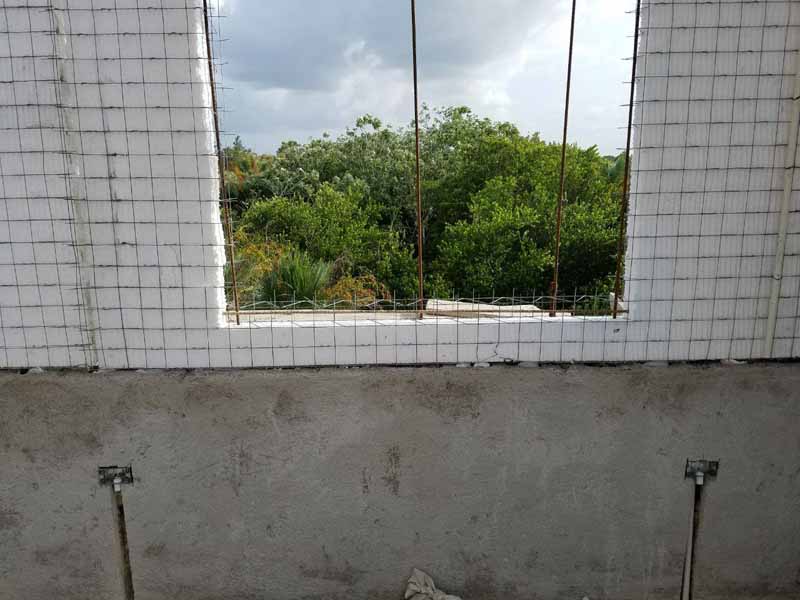

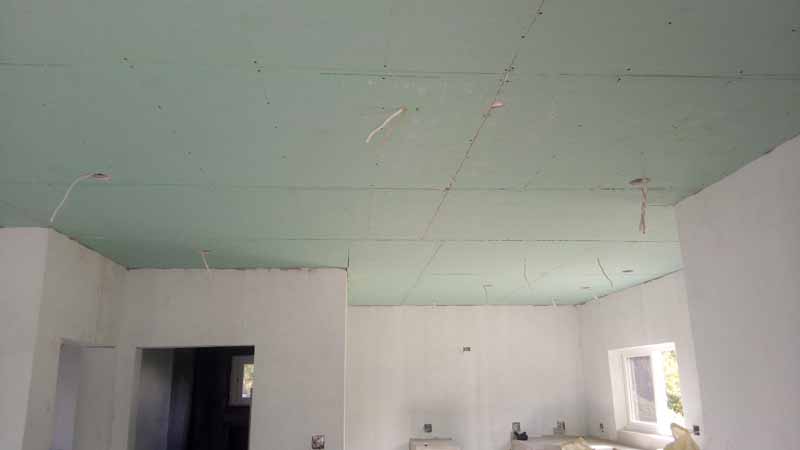

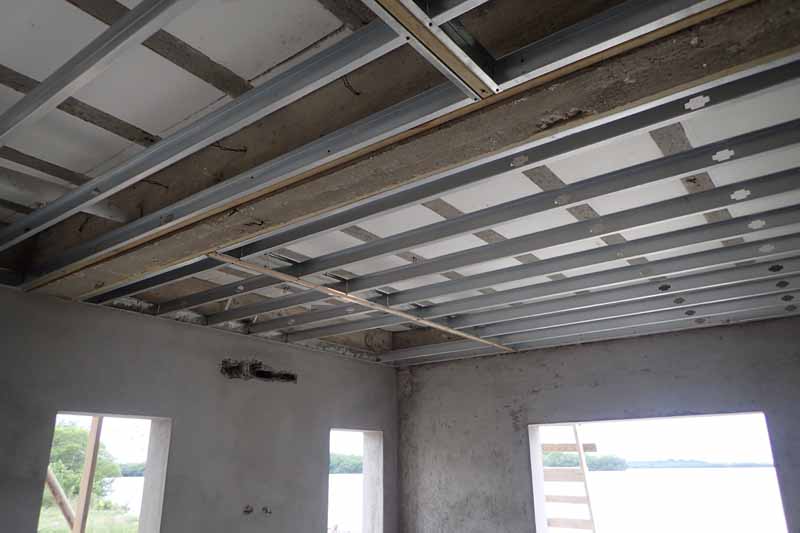

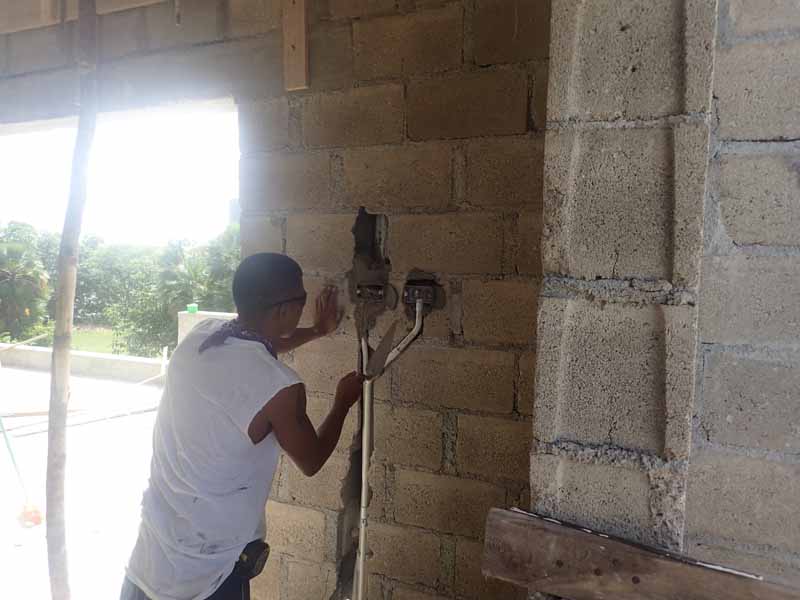

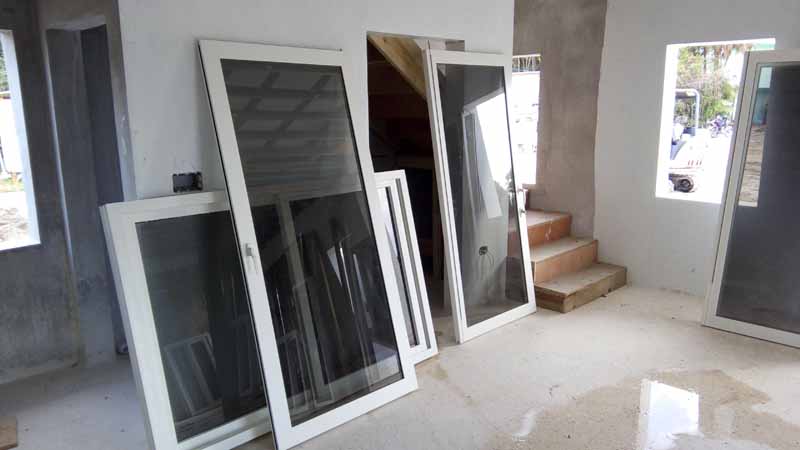

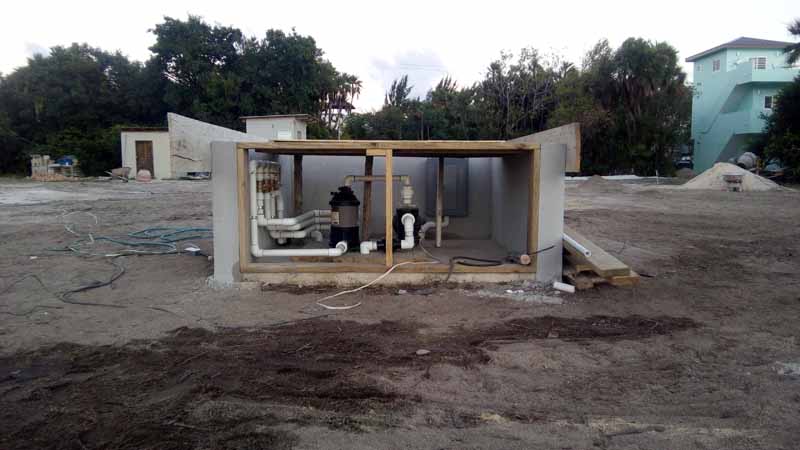

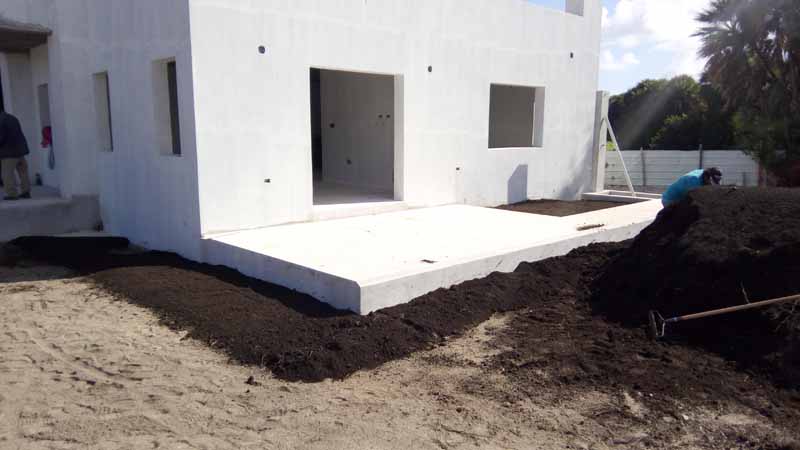

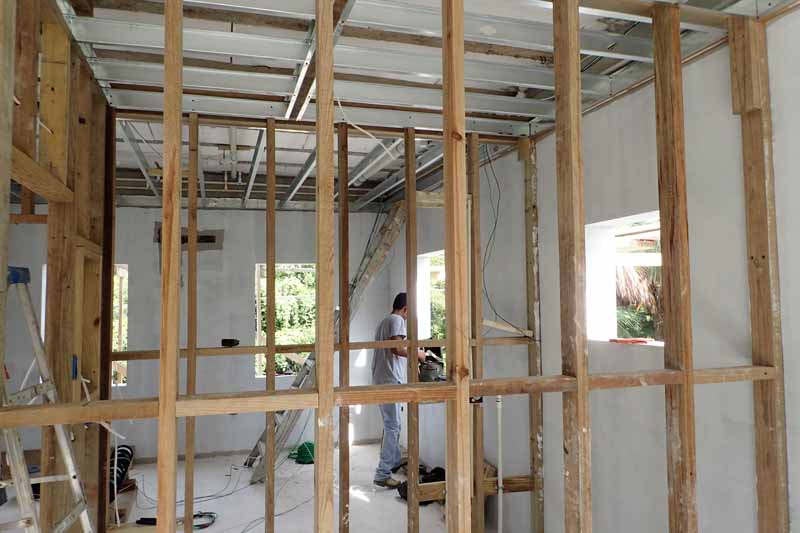

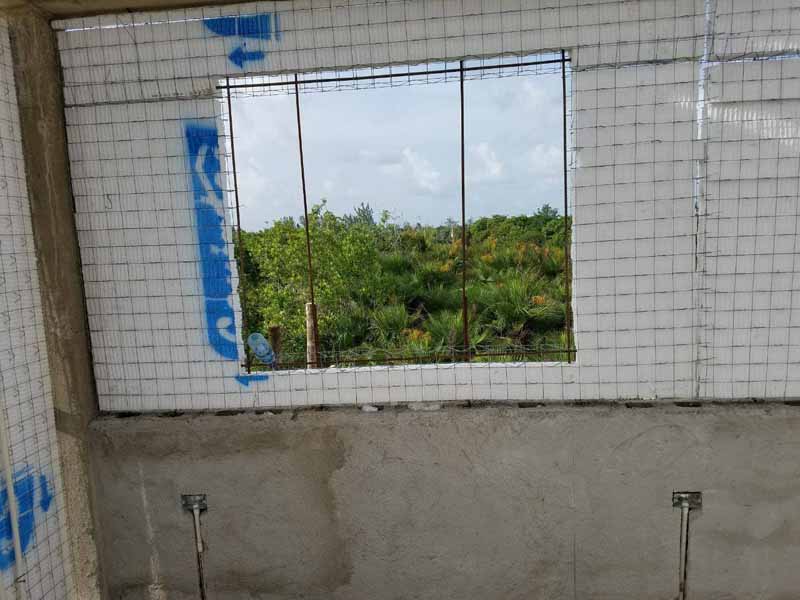

  1. Mar. 2018Landscaping installation, House 3 – closed in windows, complete electrical, pressure test and green board (drywall) going up.

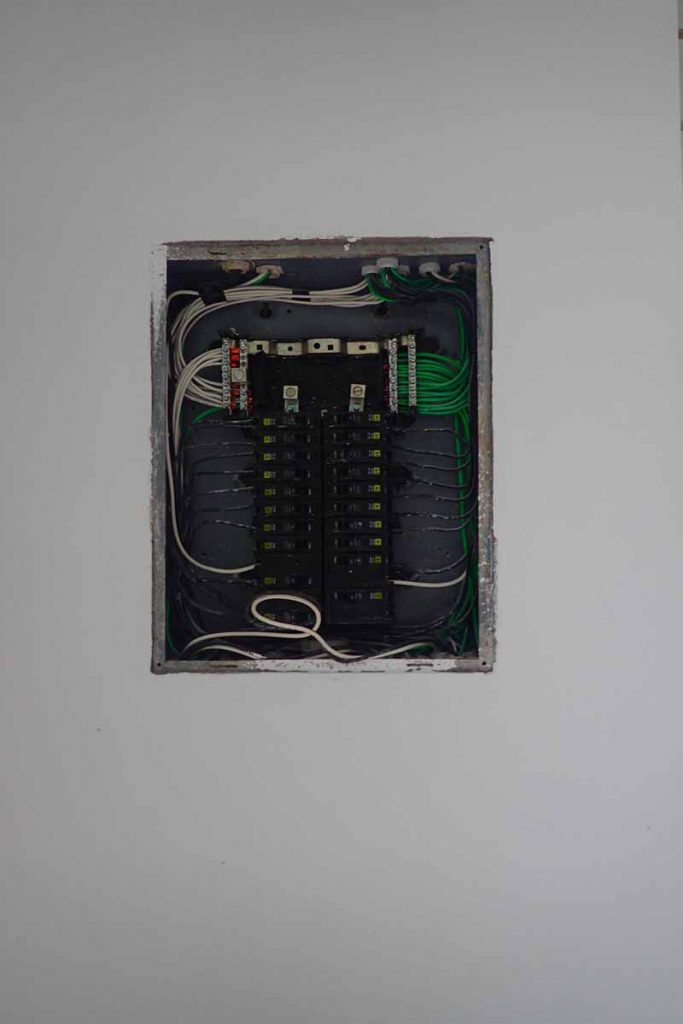

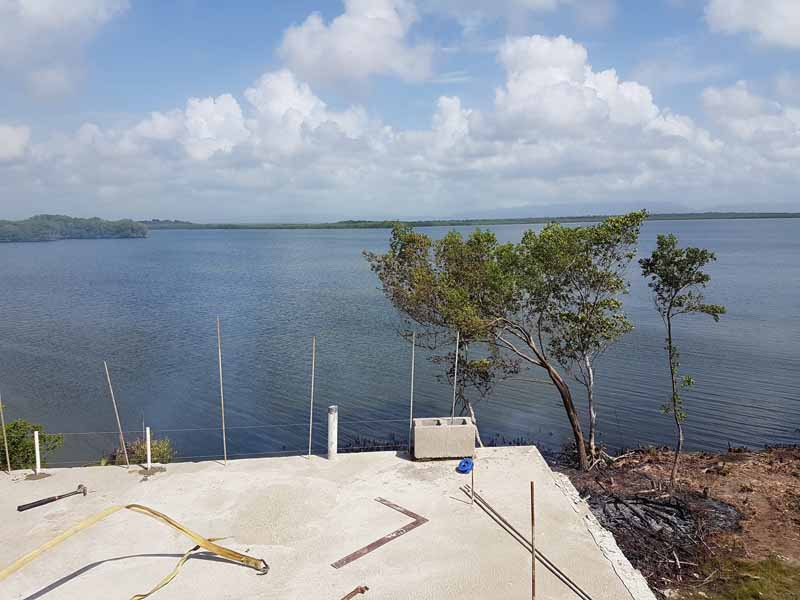

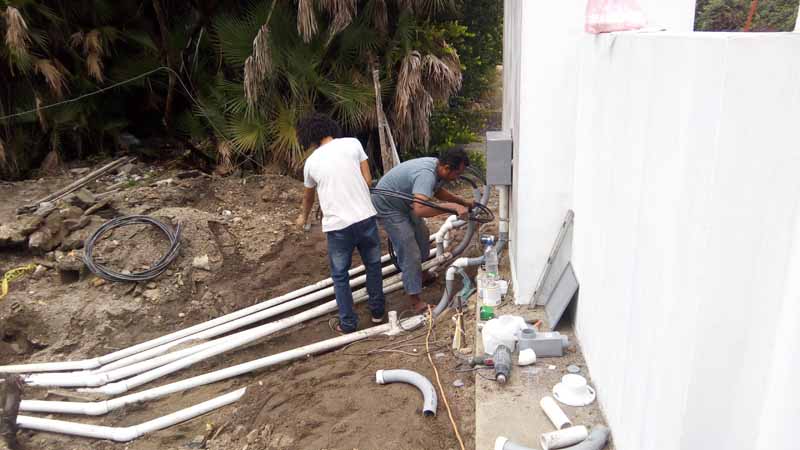

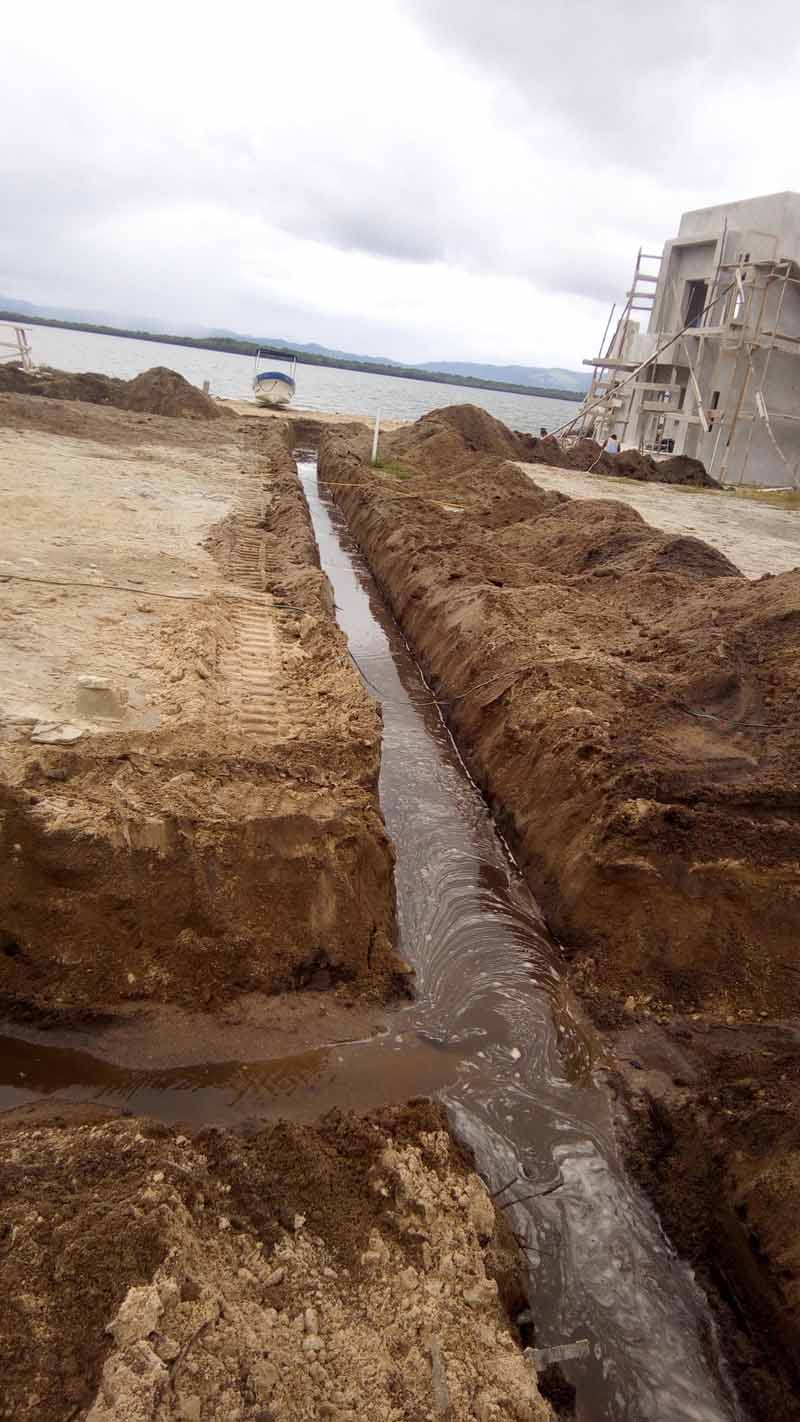

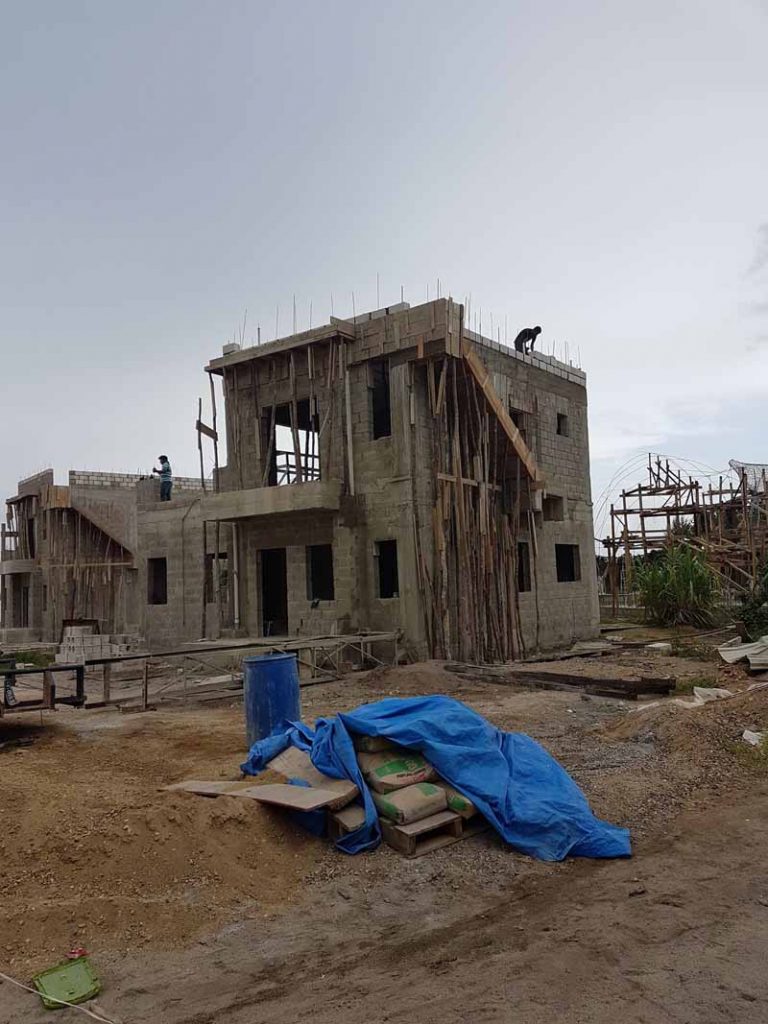

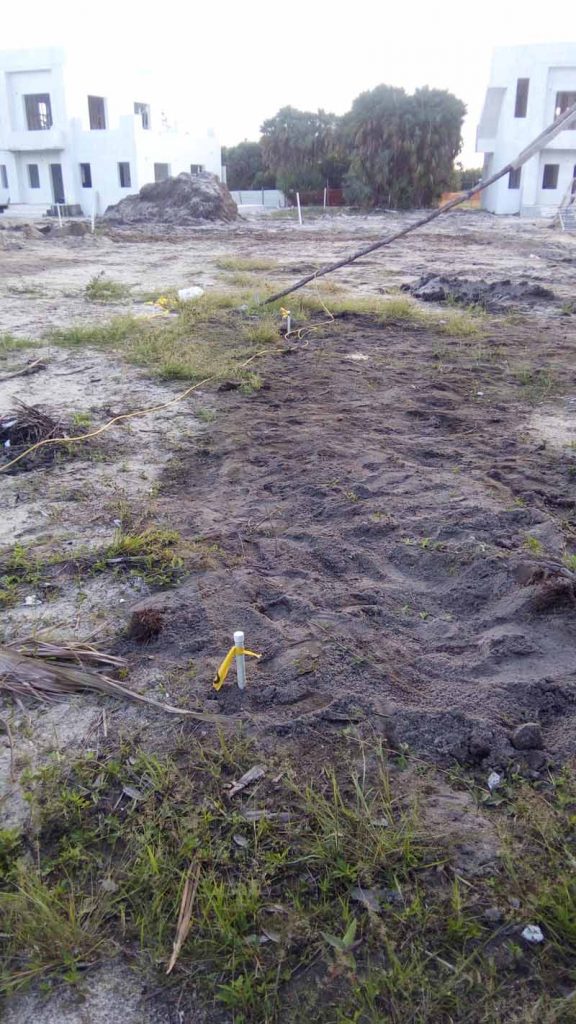

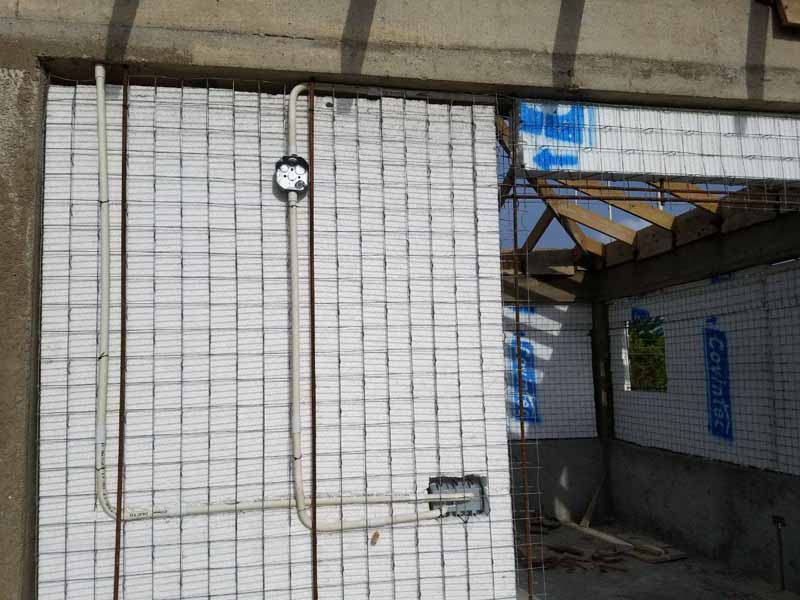

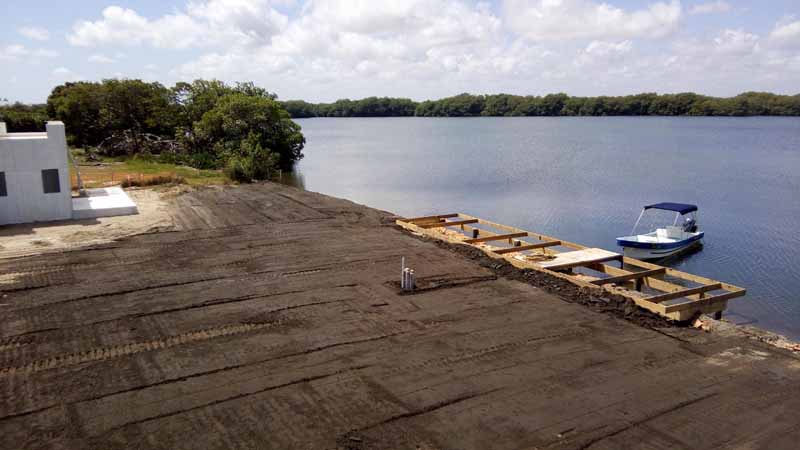

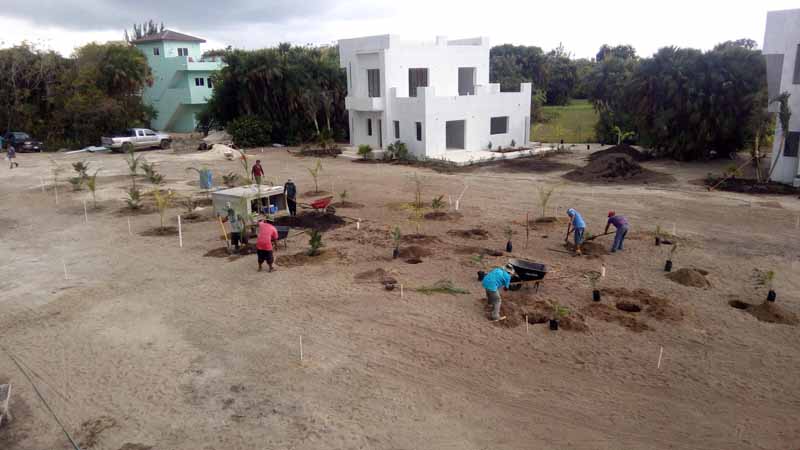

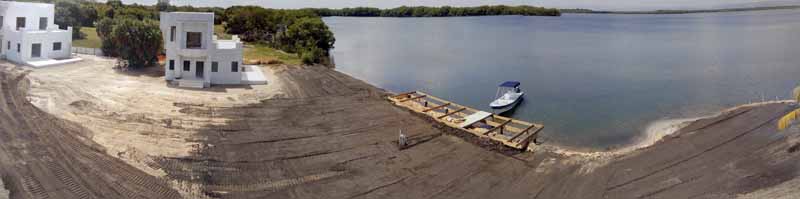

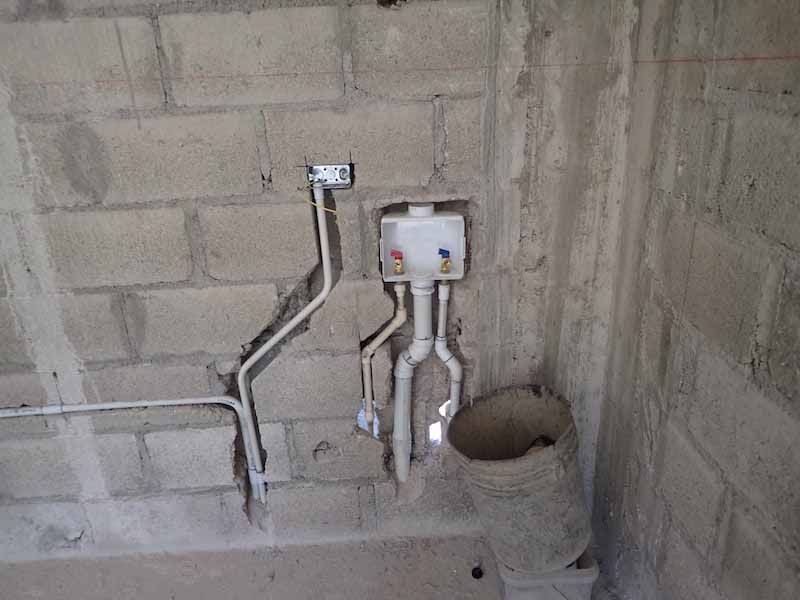

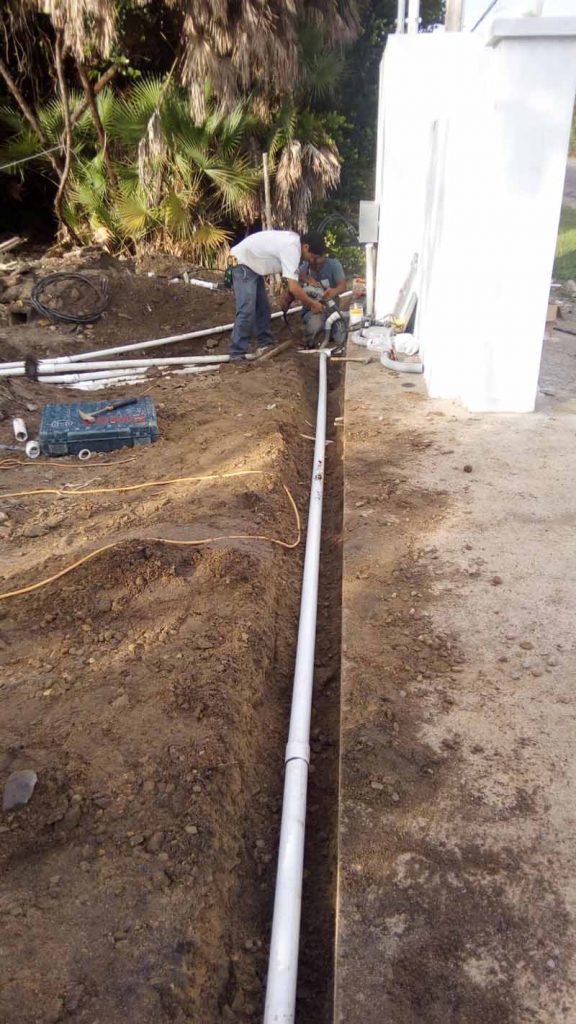

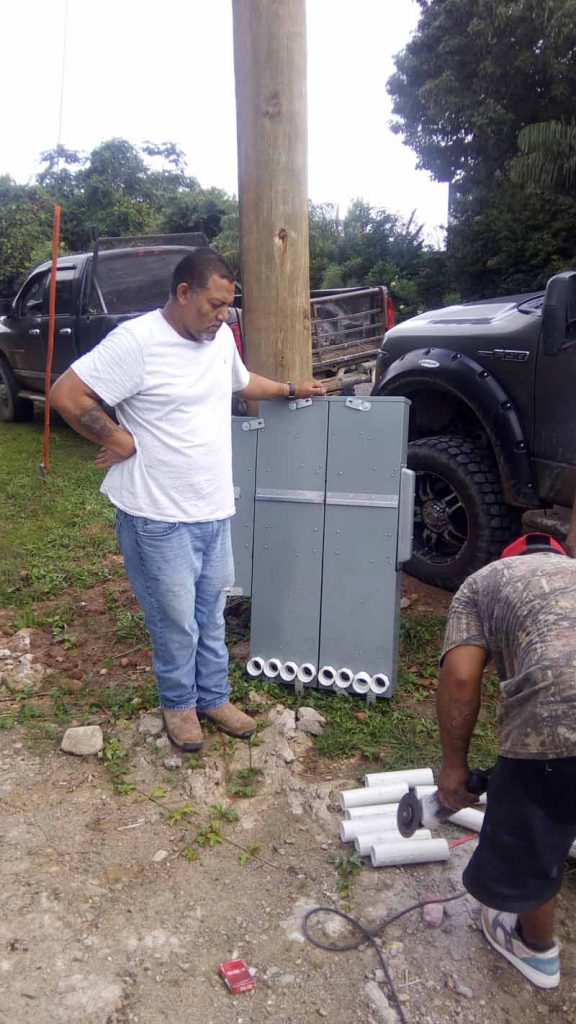

  2. Feb. 2018Final irrigation system details, landscaping preparation, seawall completion & House 3 windows.
  3. Jan. 2018Surgery, Electrical to Meters, Nightstands done, Irrigation System going in, Permanent Electrical to Manager’s Unit.

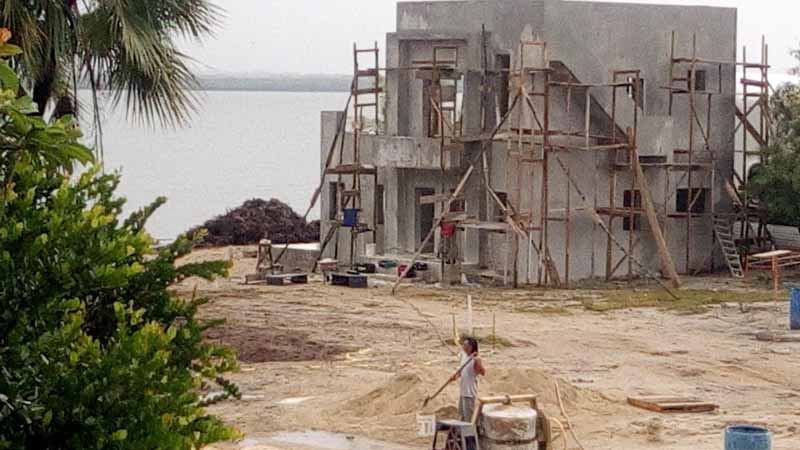

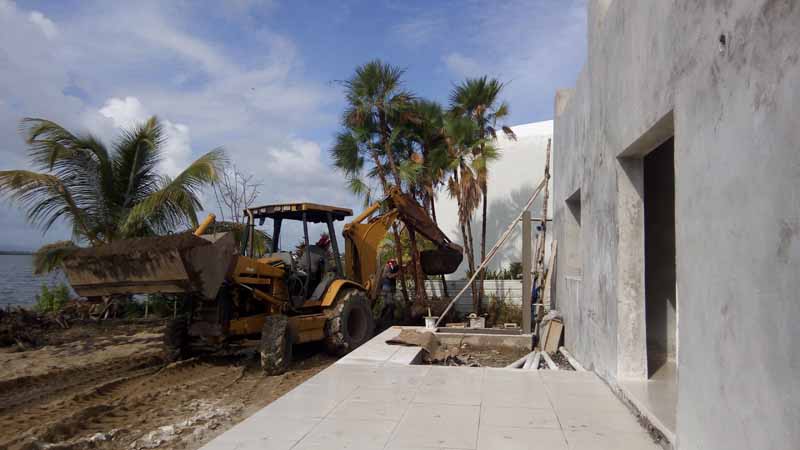

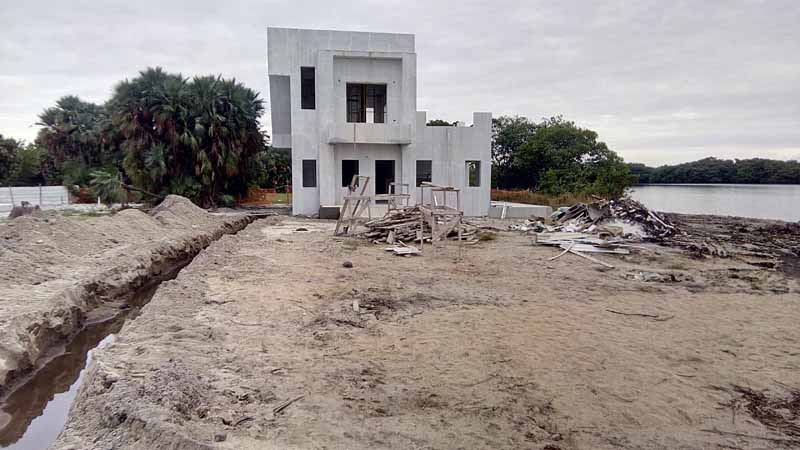

  4. Dec. 2017Final Floor Pours, Trenching for Electric & Water, Irrigation Well, Adding Palmetto, Tile Work, Electric Cables & Water pipes in.

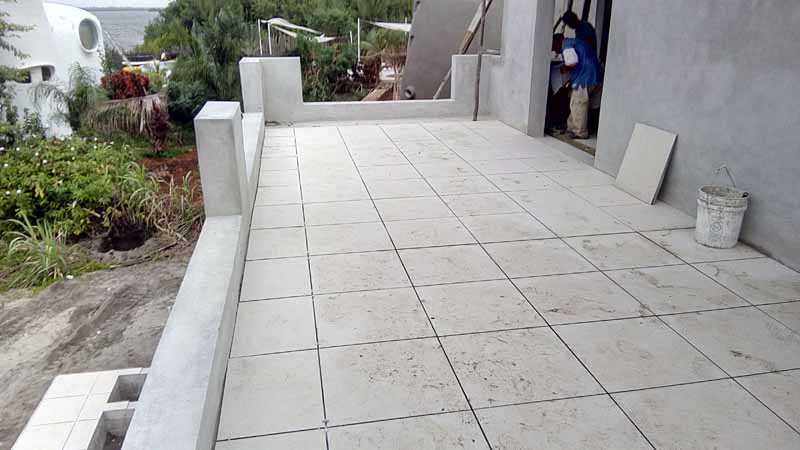

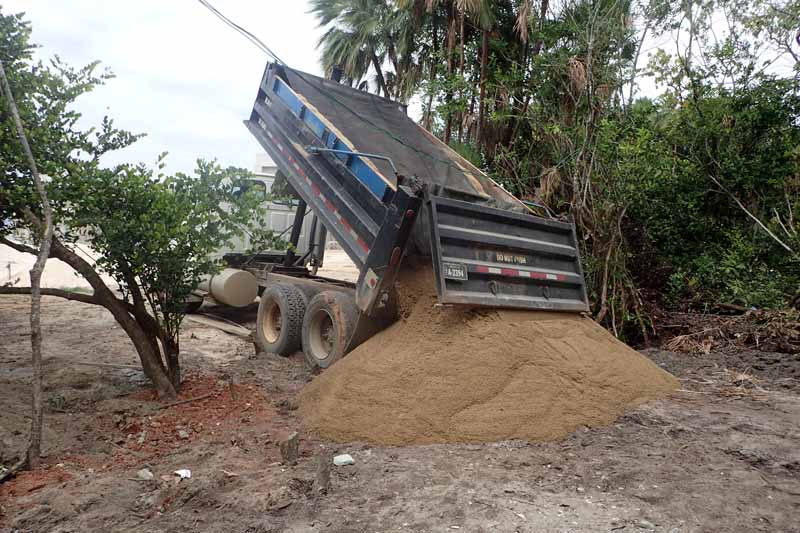

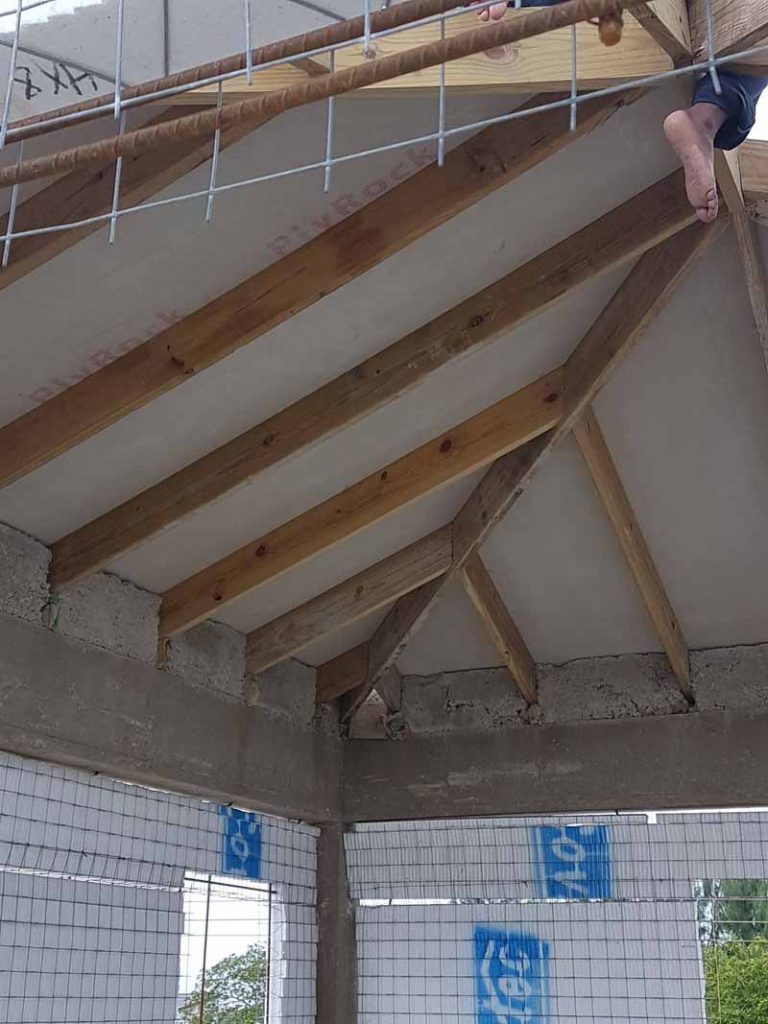

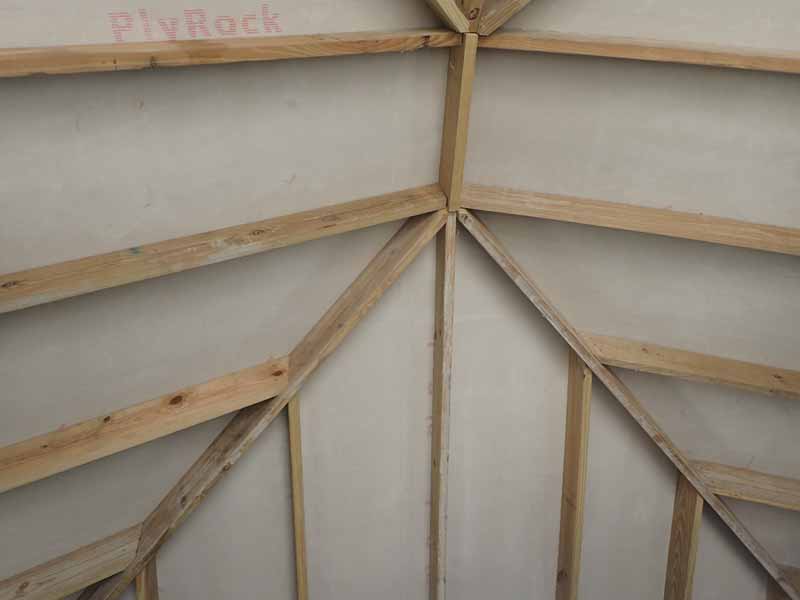

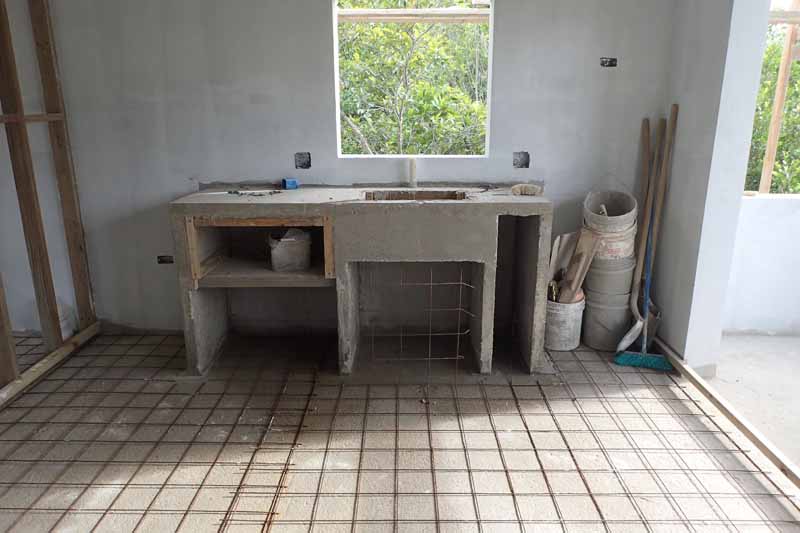

  5. Nov. 2017Tile, Always sand, Manager’s Kitchen / Closets / Furniture Example (bed), Floor pours, White Concrete, Creating Fill, Buffing Floors, Framing Ceilings and Plastering.

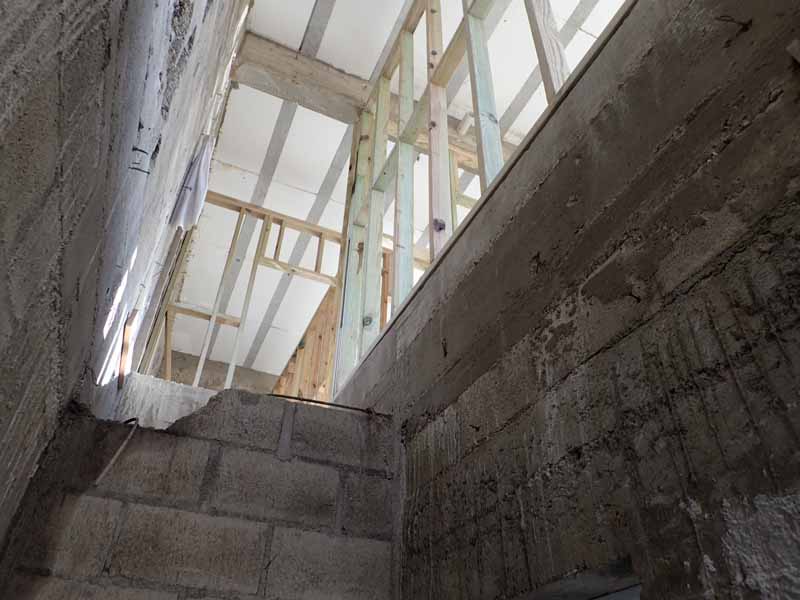

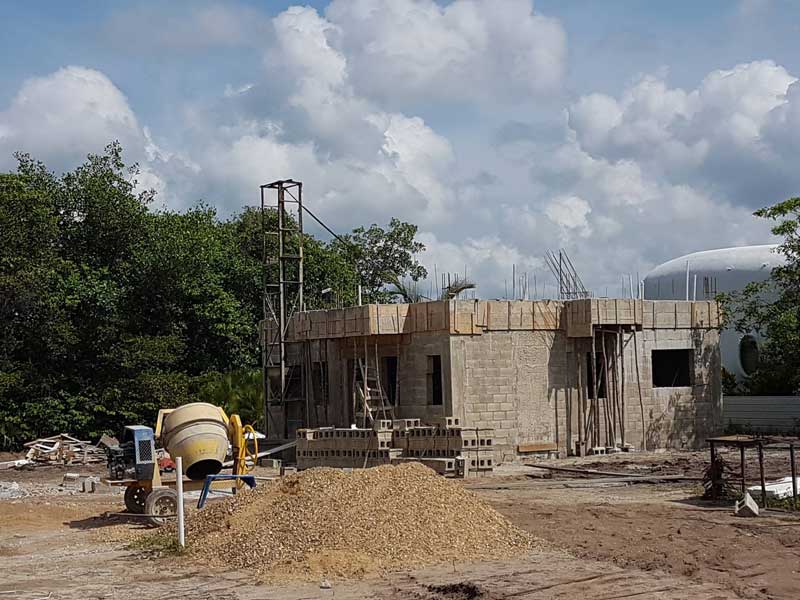

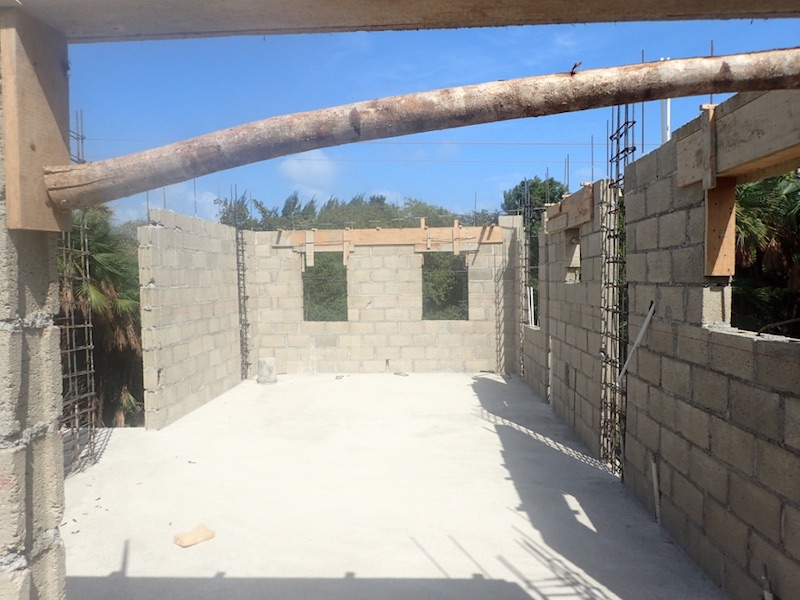

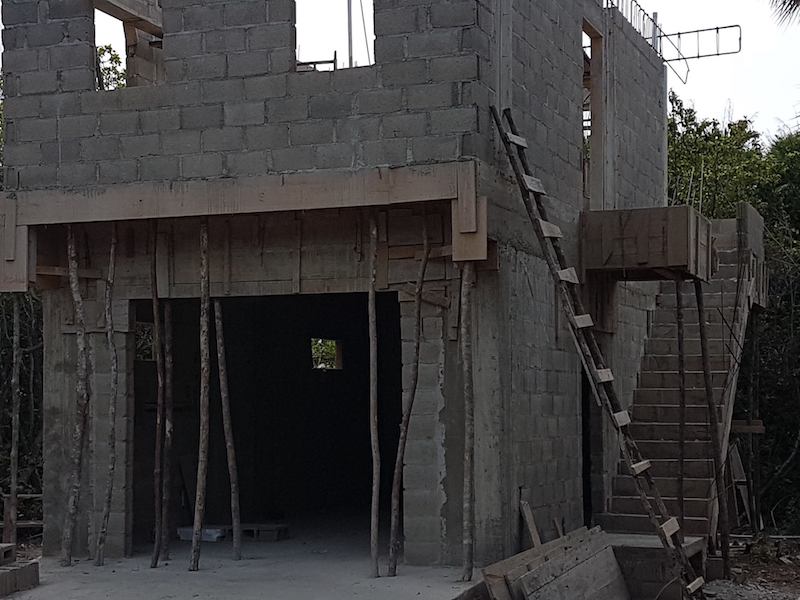

  6. Oct. 2017Manager’s Unit finishing up, Sand & more sand, Tile & Plaster work.

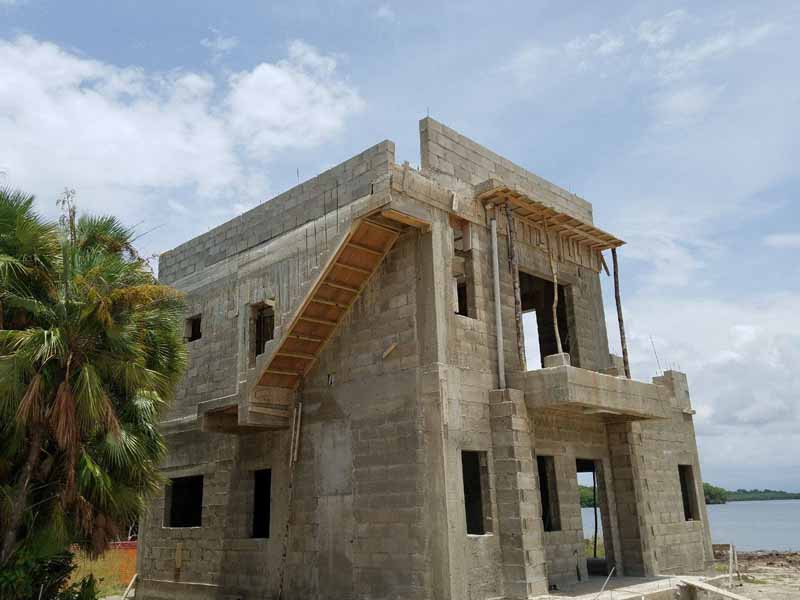

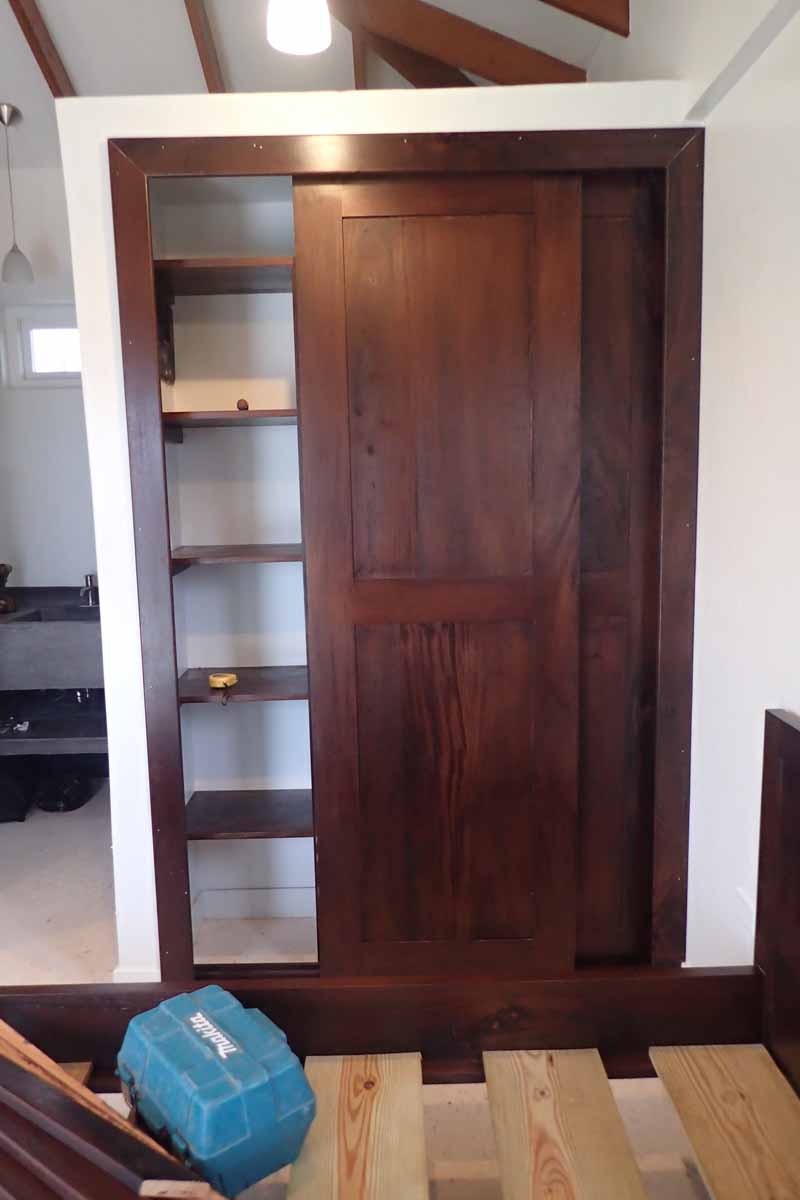

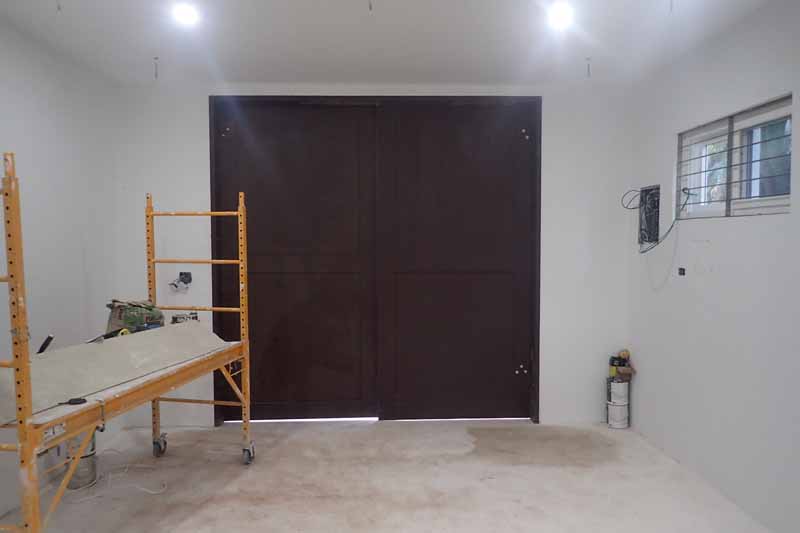

  7. 10/3/2017Doors Installed – Manager’s Unit, Garage Doors, Exterior Tile Grouted, Baseboards, Gate Painted, House 3 plastering.

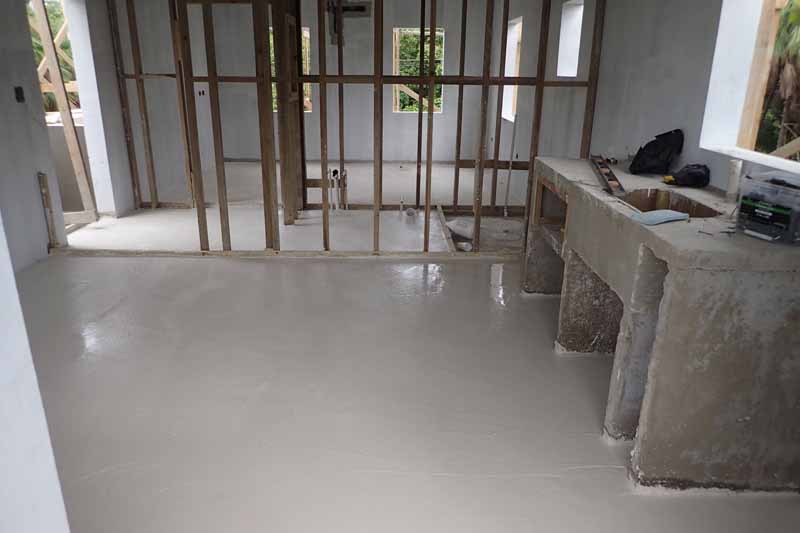

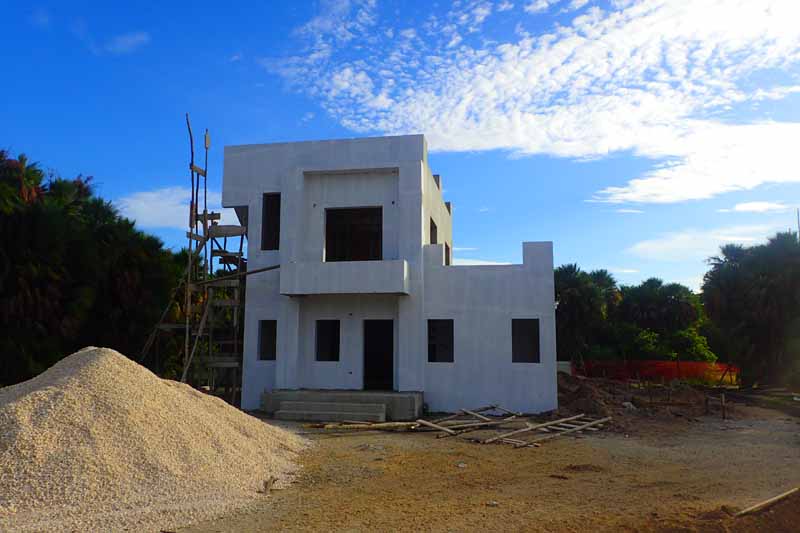

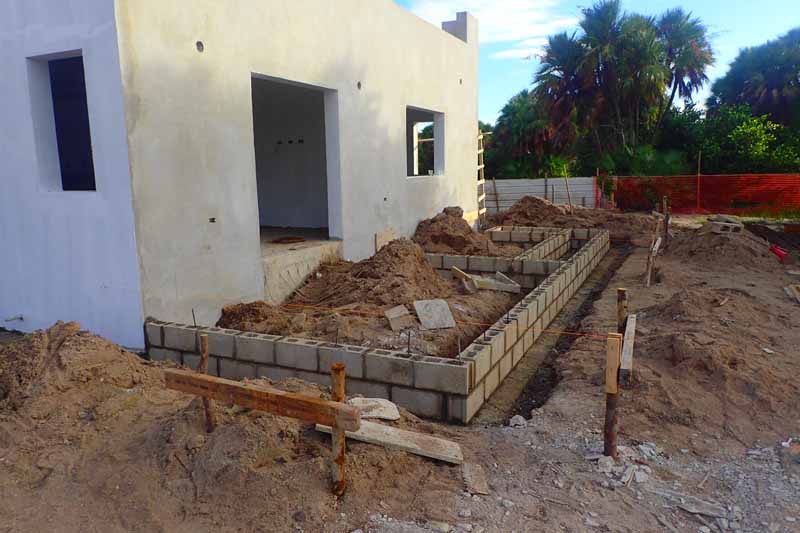

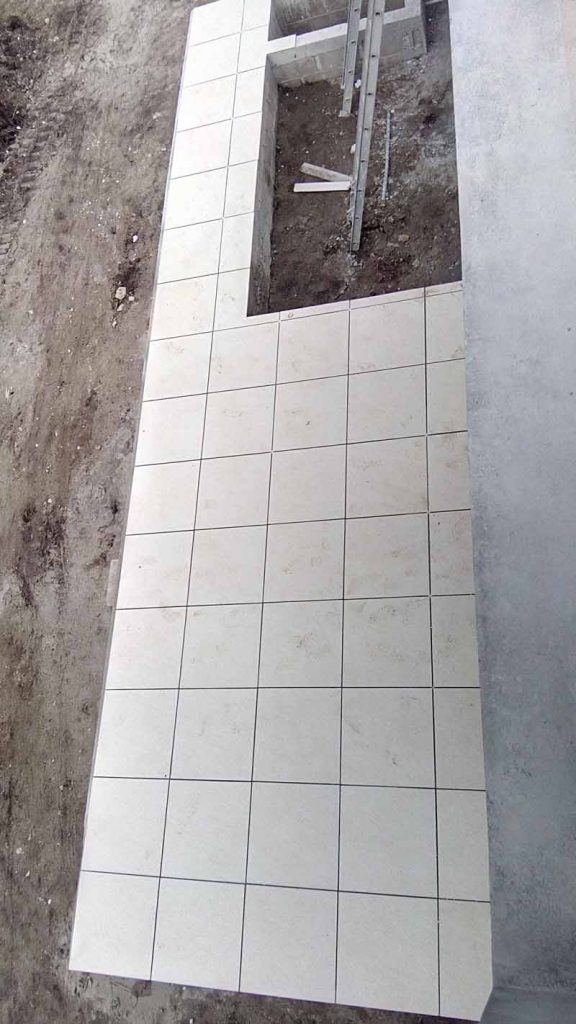

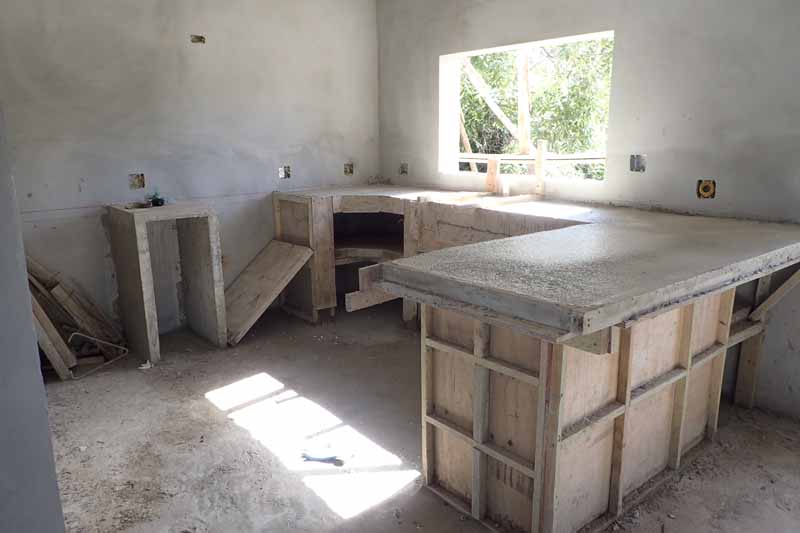

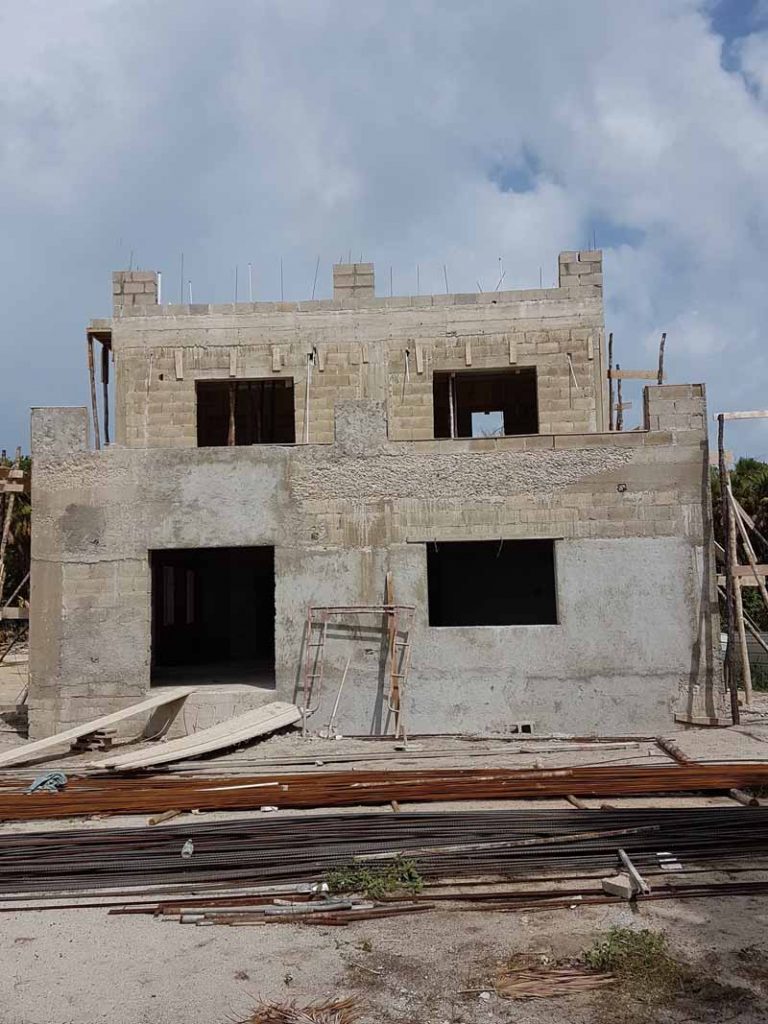

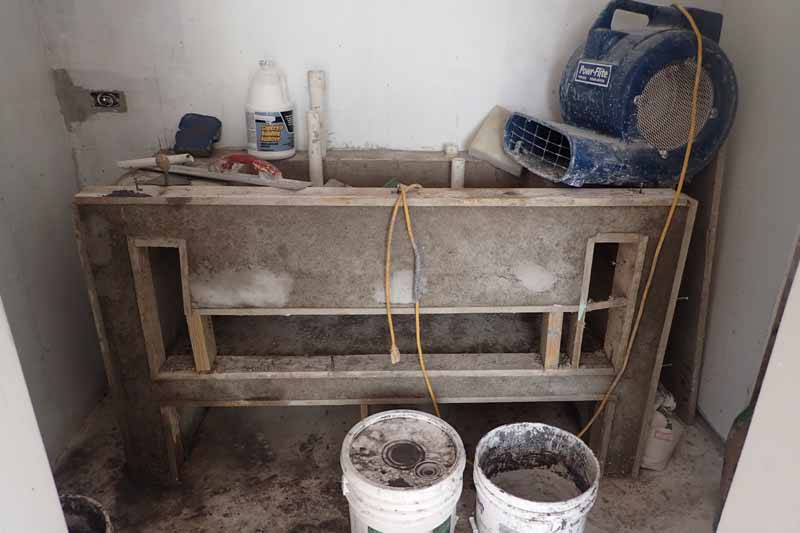

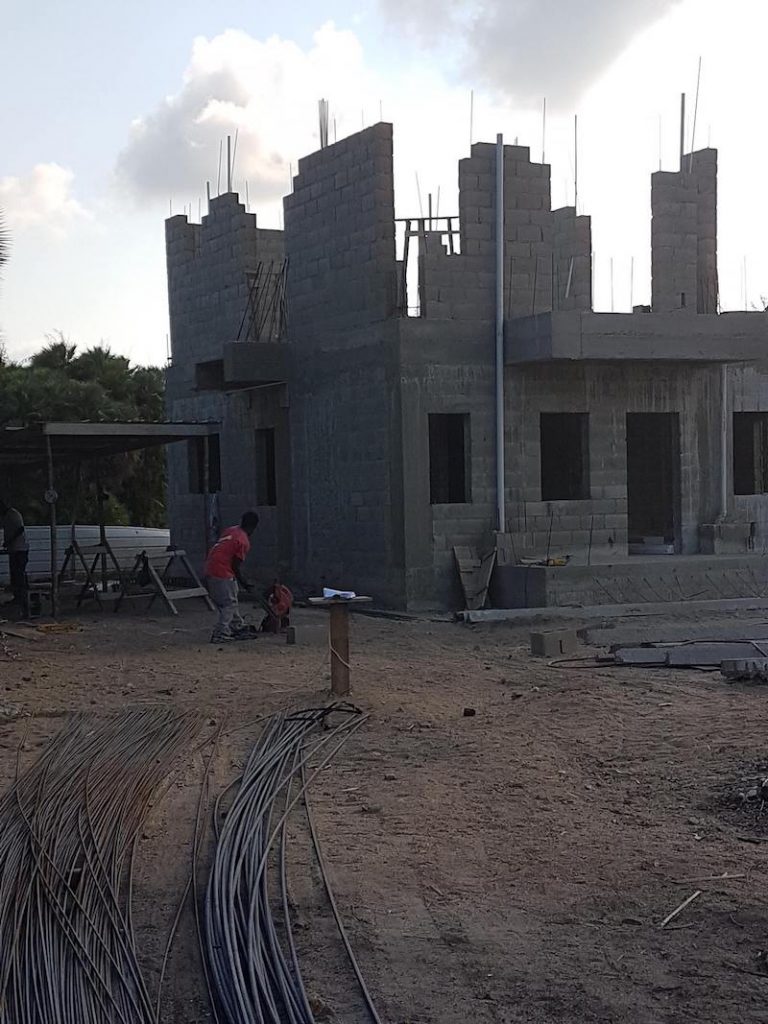

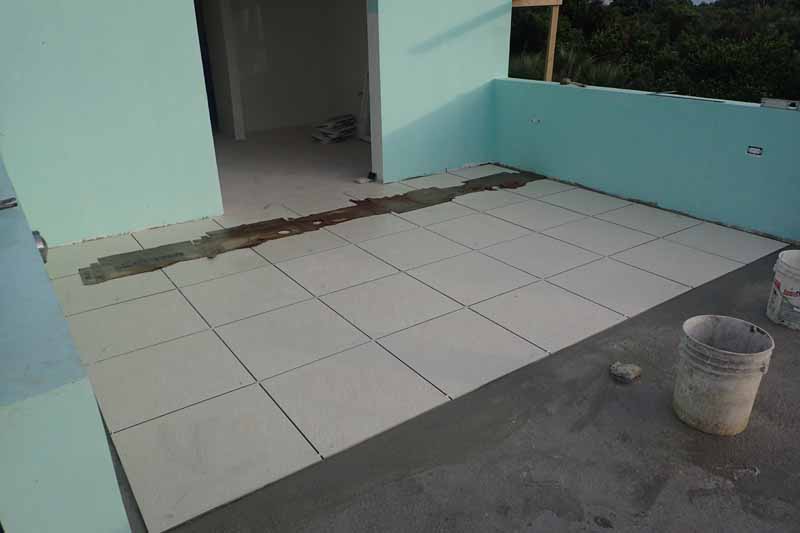

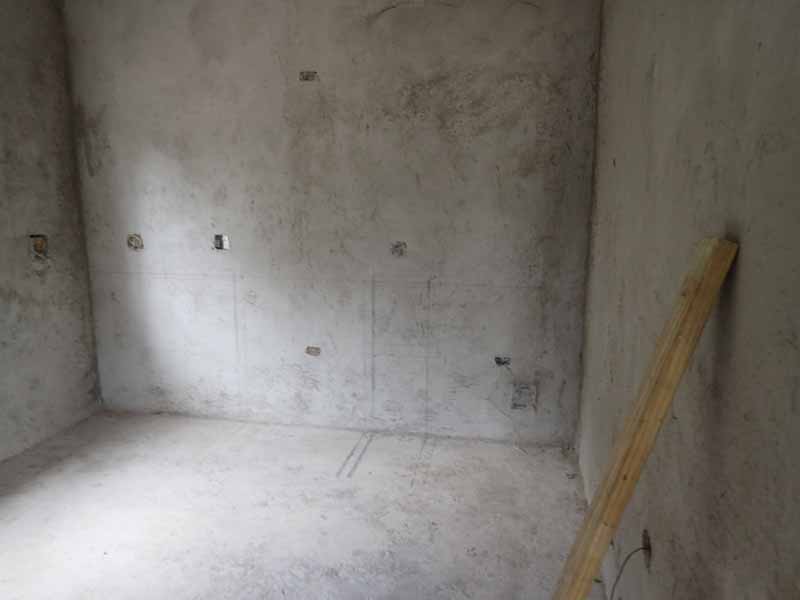

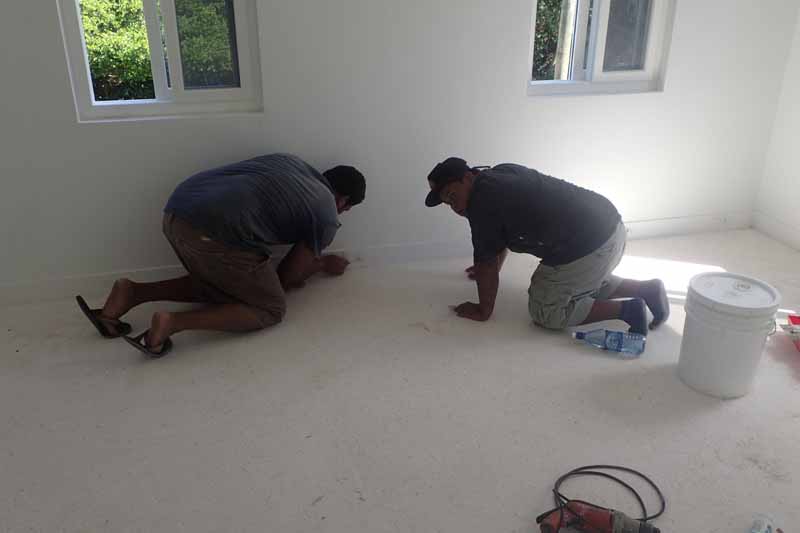

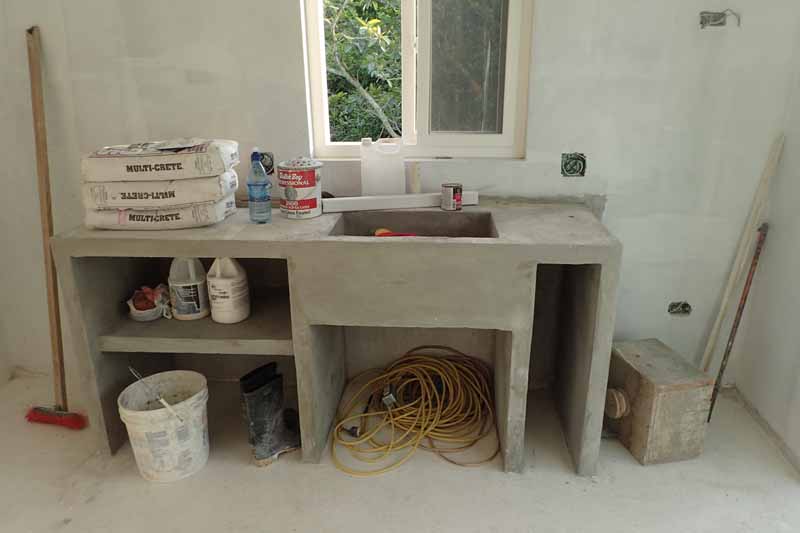

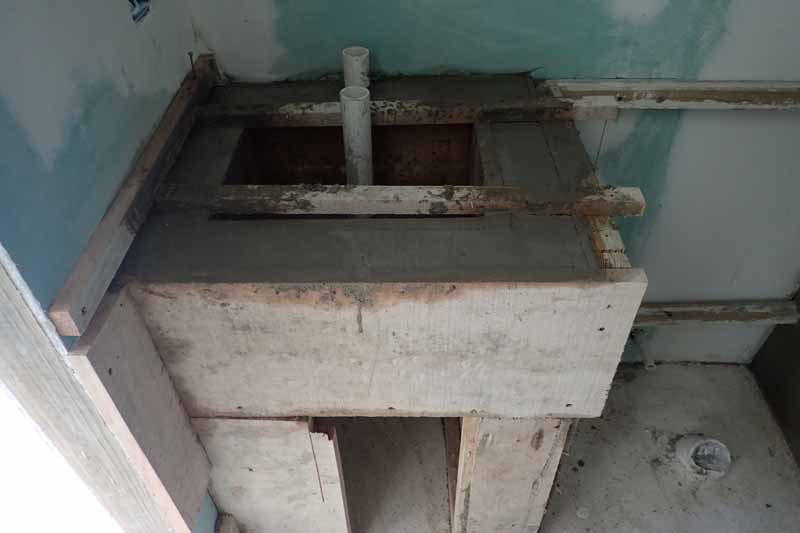

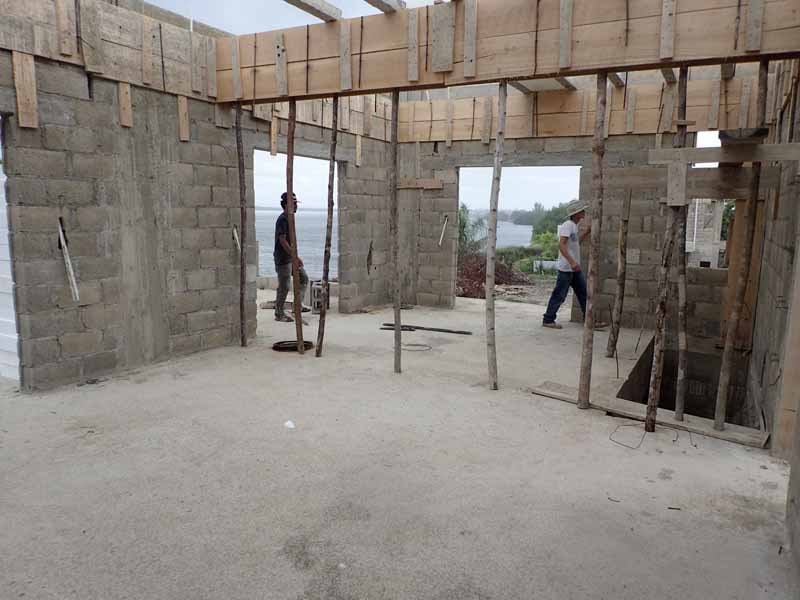

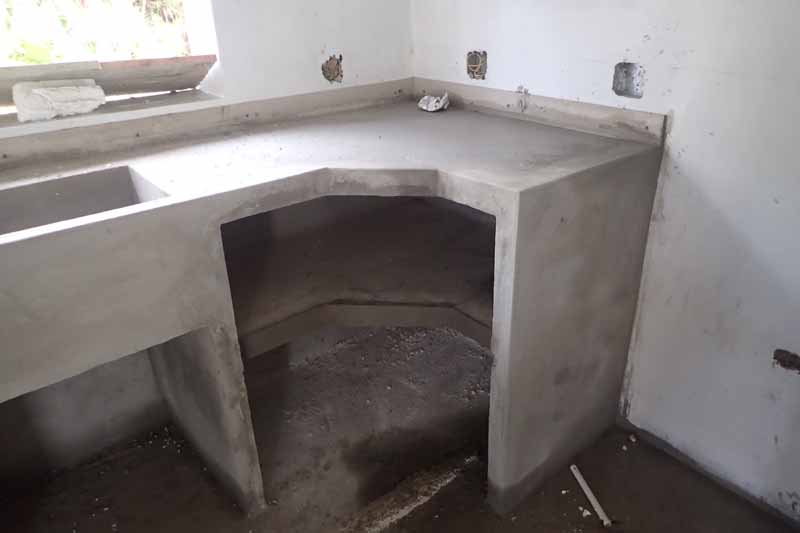

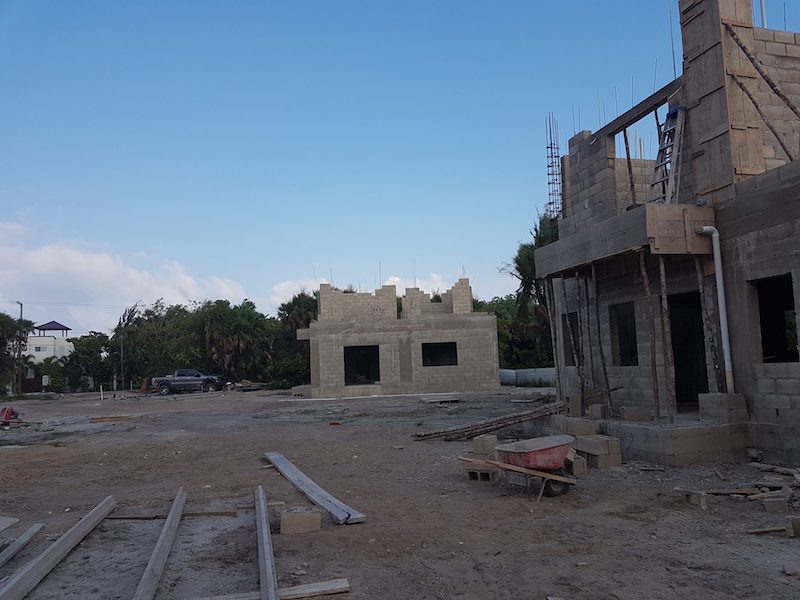

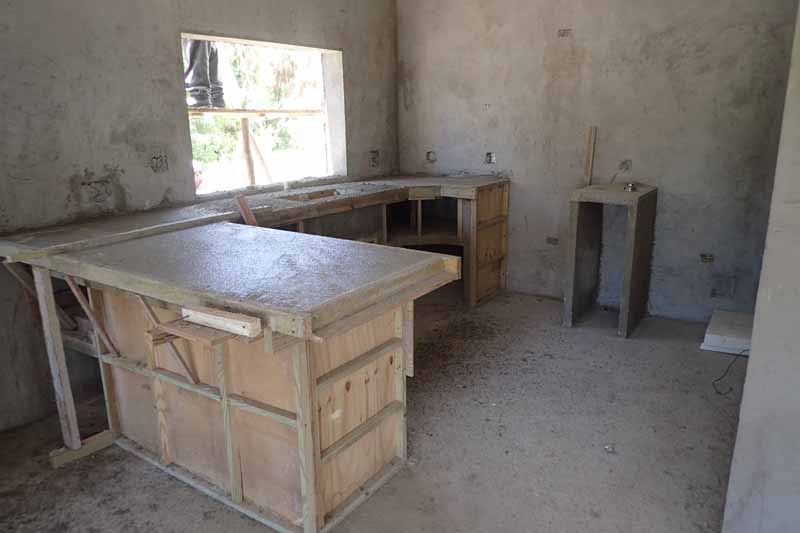

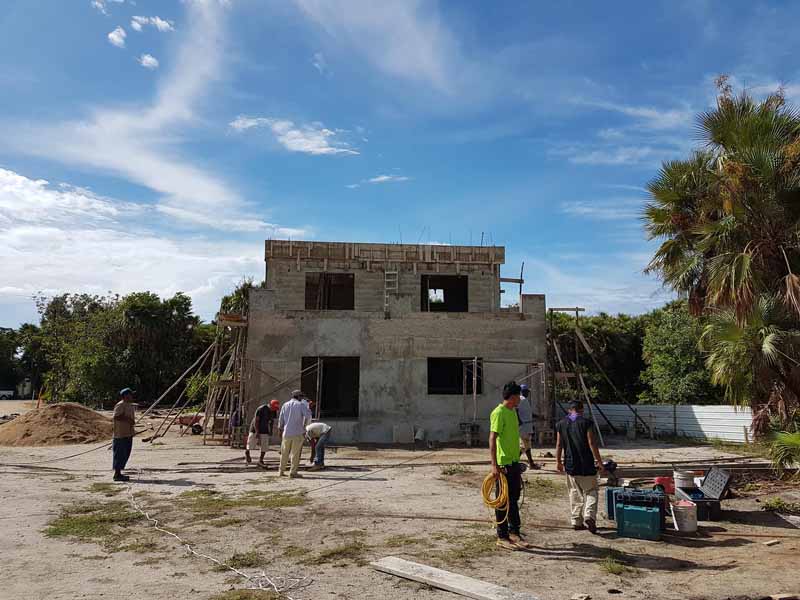

  8. 09/30/2017Kitchen Counters & Exterior Tile.

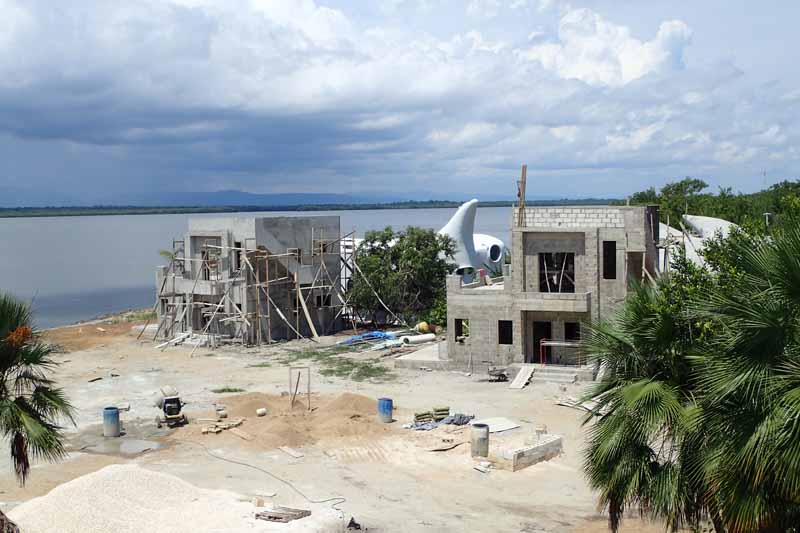

  9. 09/28/2017House 4 Plastered, Framing House 3, Electrical & Tile.
  10. 09/22/2017Vanity, Kitchen Counters & Gate.

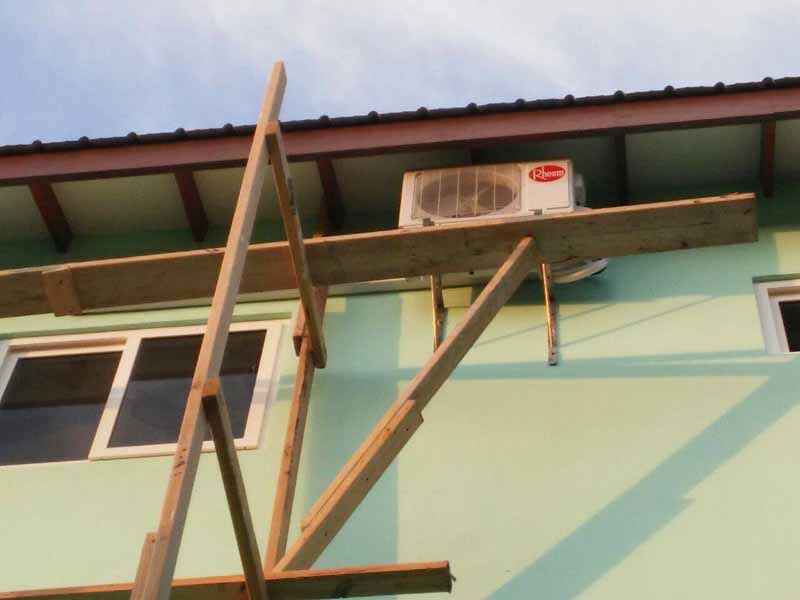

  11. 09/14/2017A few finish details, vanity, counters & patio.
  12. 09/12/2017AC Units & Outdoor Shower.

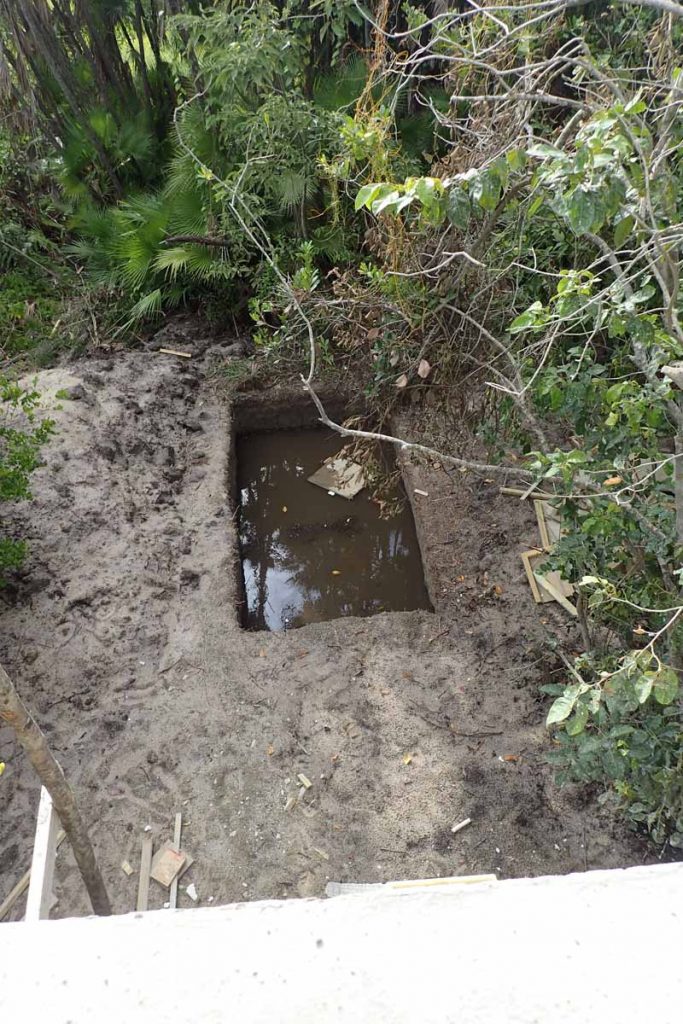

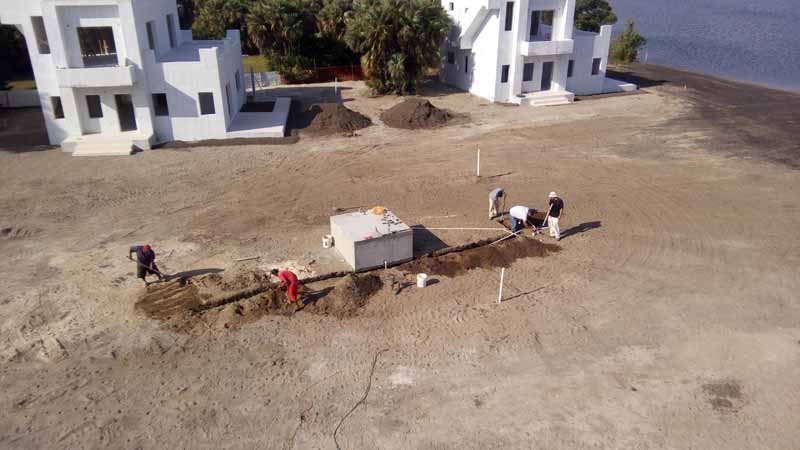

  13. 09/08/2017Vanities & Floor Pour.

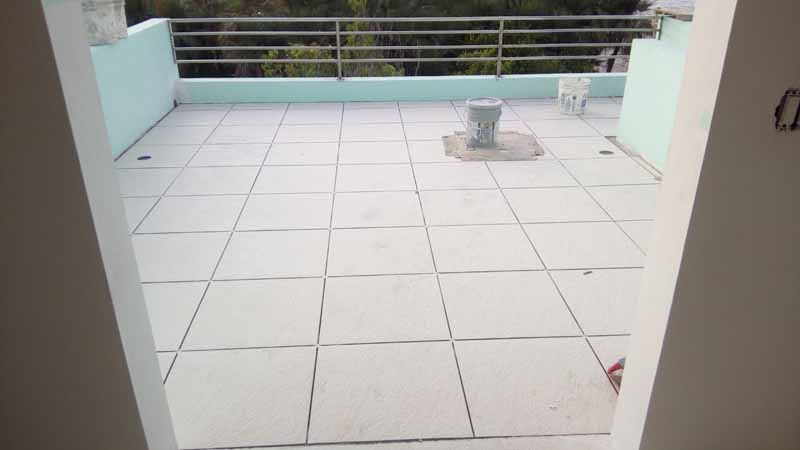

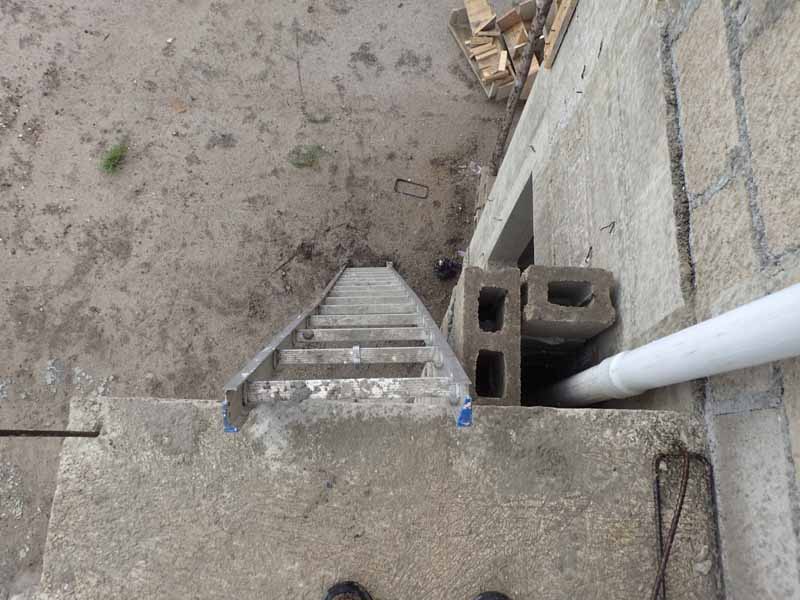

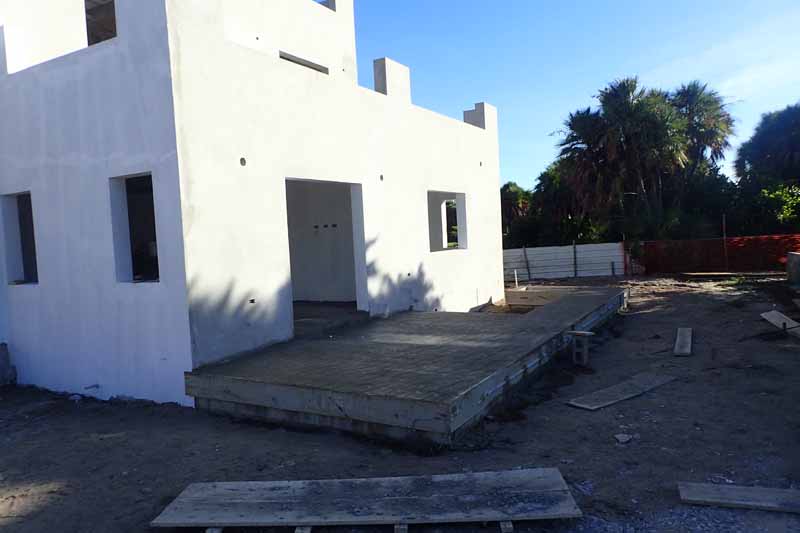

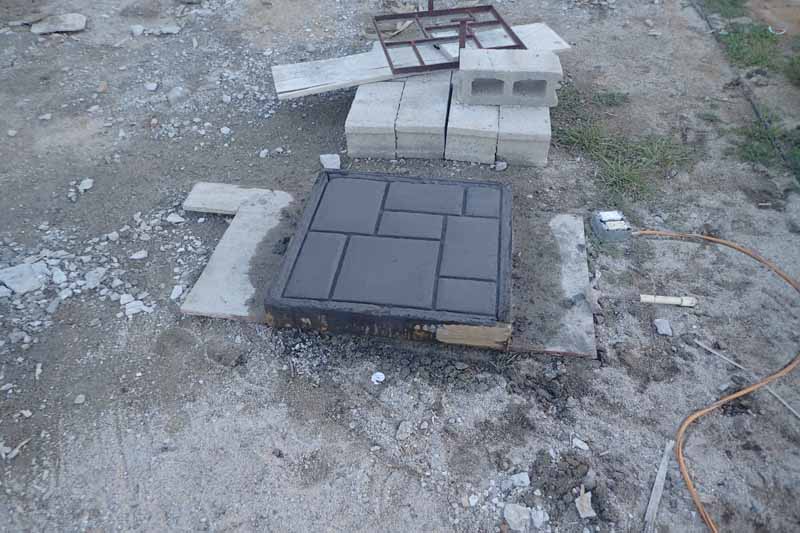

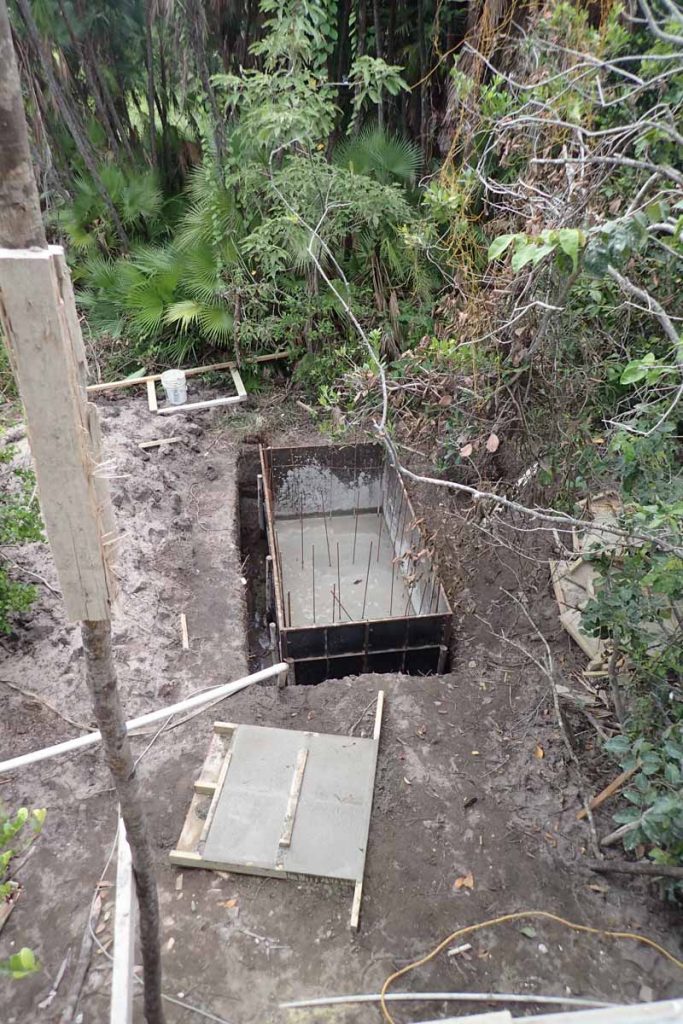

  14. 09/06/2017Patios, Septic(s) and House 4 Plastering.

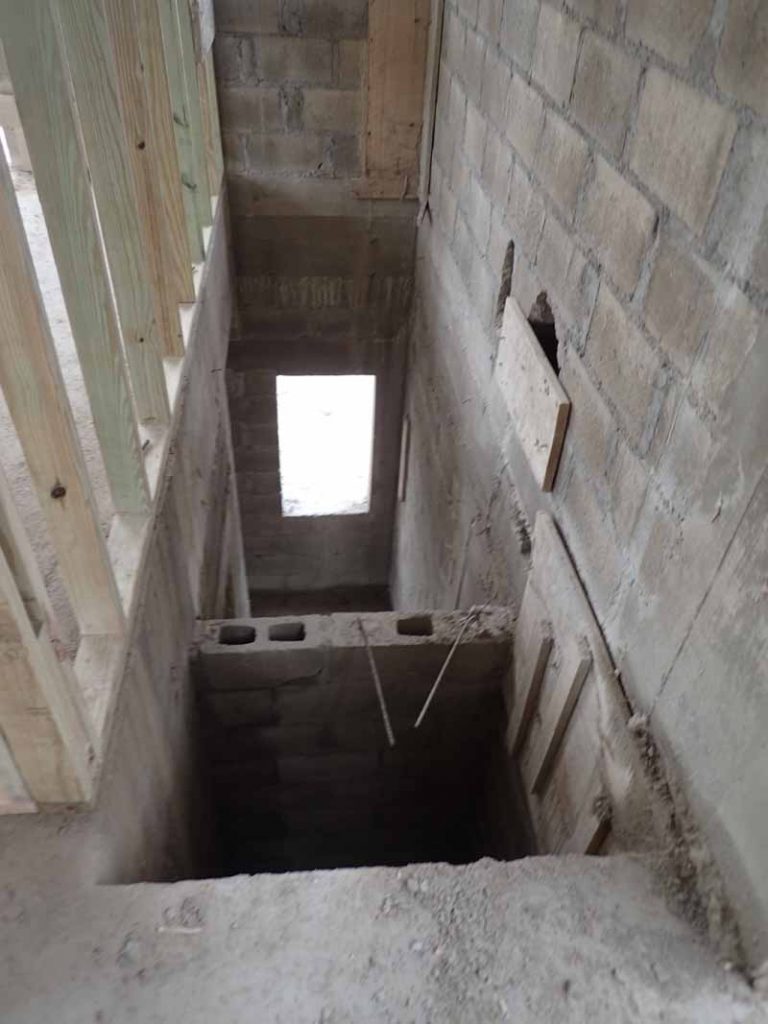

  15. 09/04/2017Patios, Test Patio Finish and Manager’s Unit Stairs.
  16. 09/01/2017House 2 Prime & Patio Foundations.

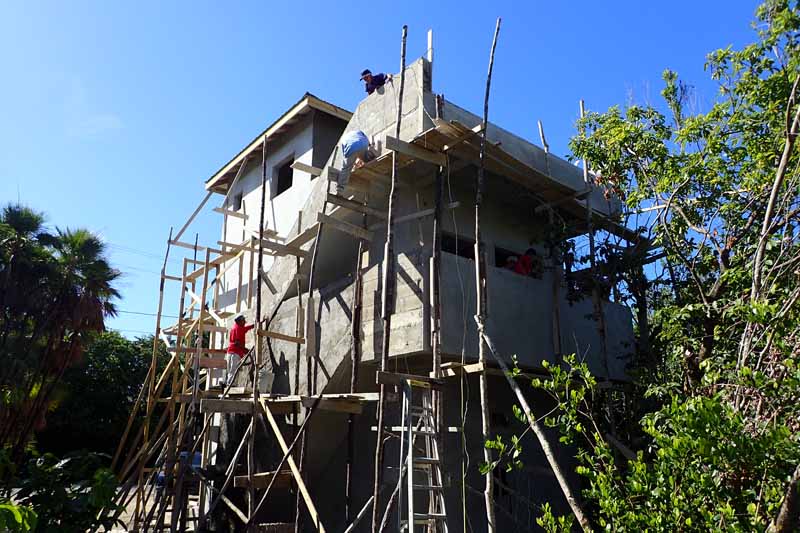

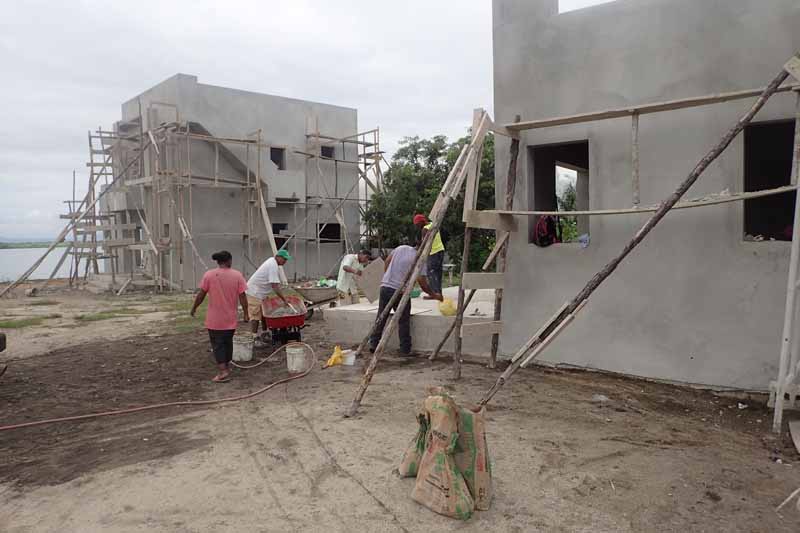

  17. 08/31/2017Manager’s Unit Coming Together, Patios on Houses going in.

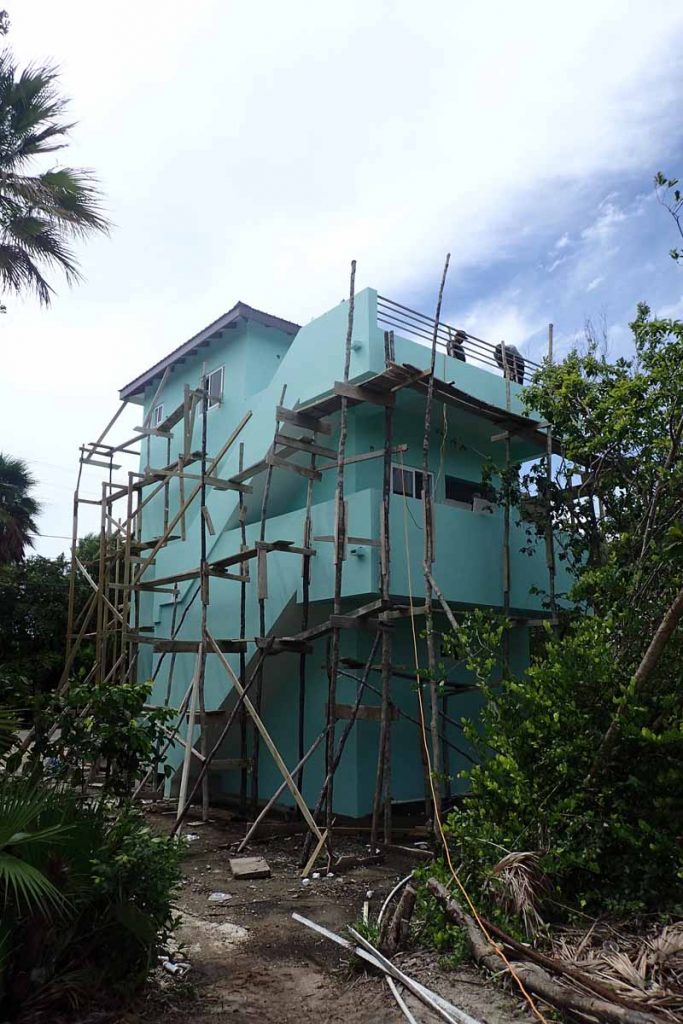

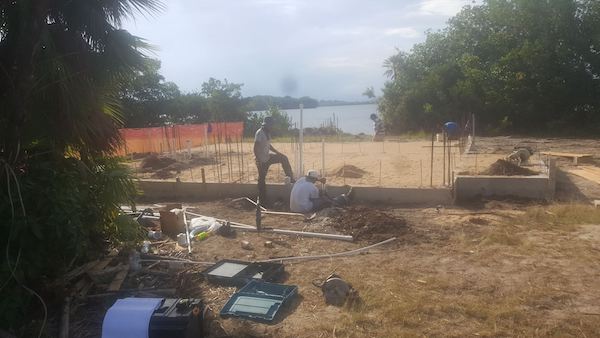

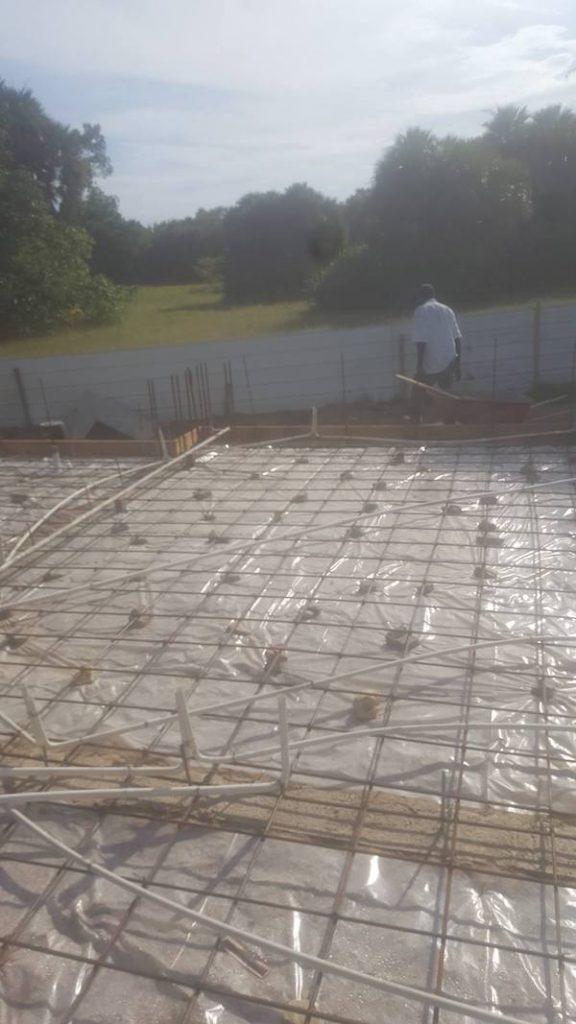

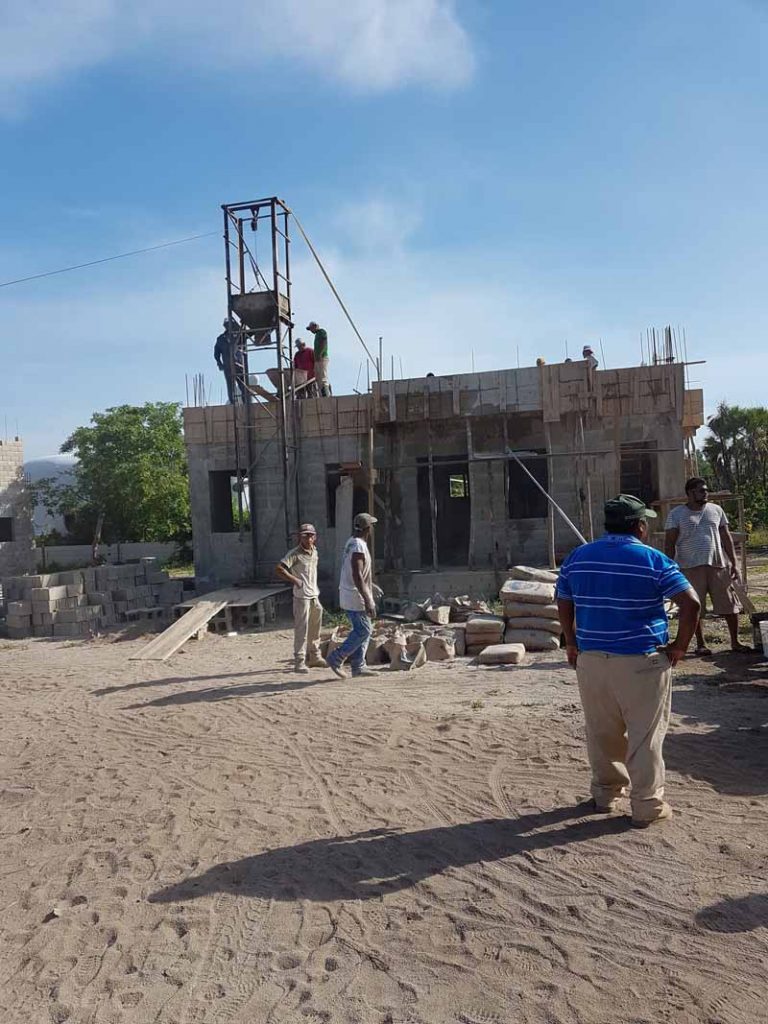

  18. 08/25/17House 2 plastering done & Birth of a septic tank.

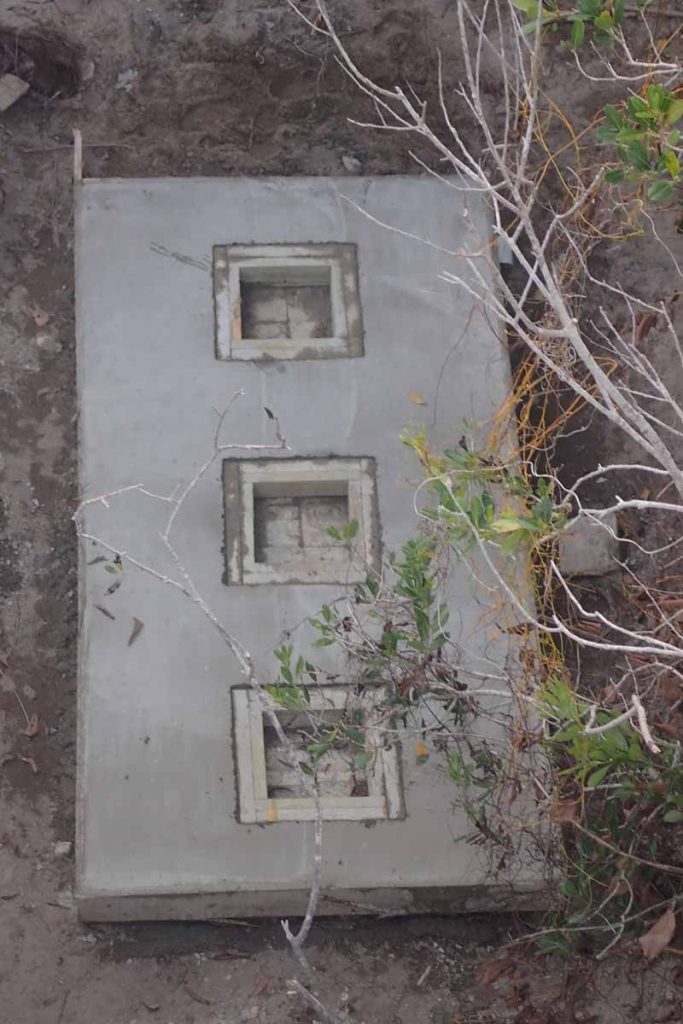

  19. 08/17/2017Landscape Design Plan.
  20. 08/15/2017Windows MU, Septics.

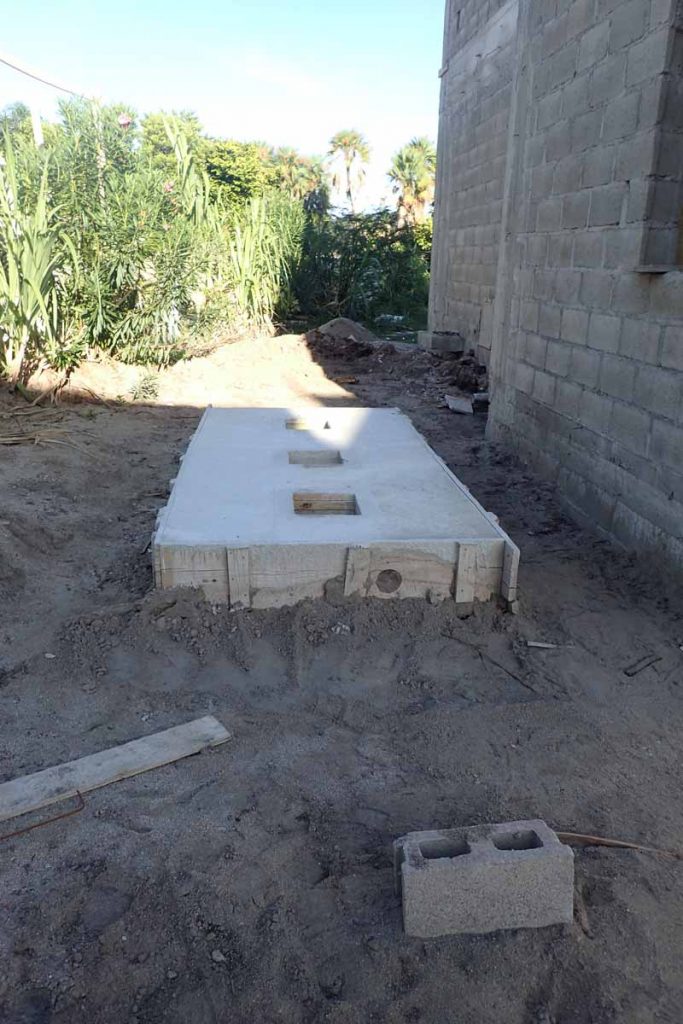

  21. 08/09/2017Manager’s Unit Septic & Electrical.

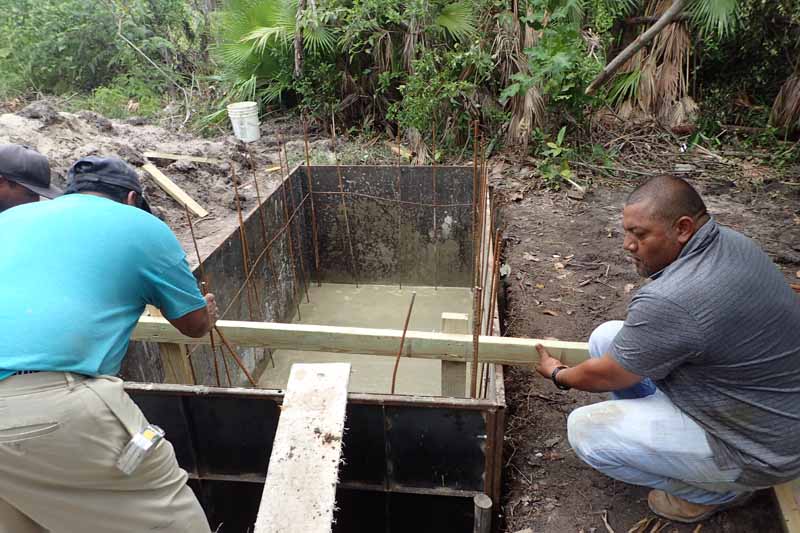

  22. 08/07/2017Manager’s Unit 1st Floor & First Septic Base.

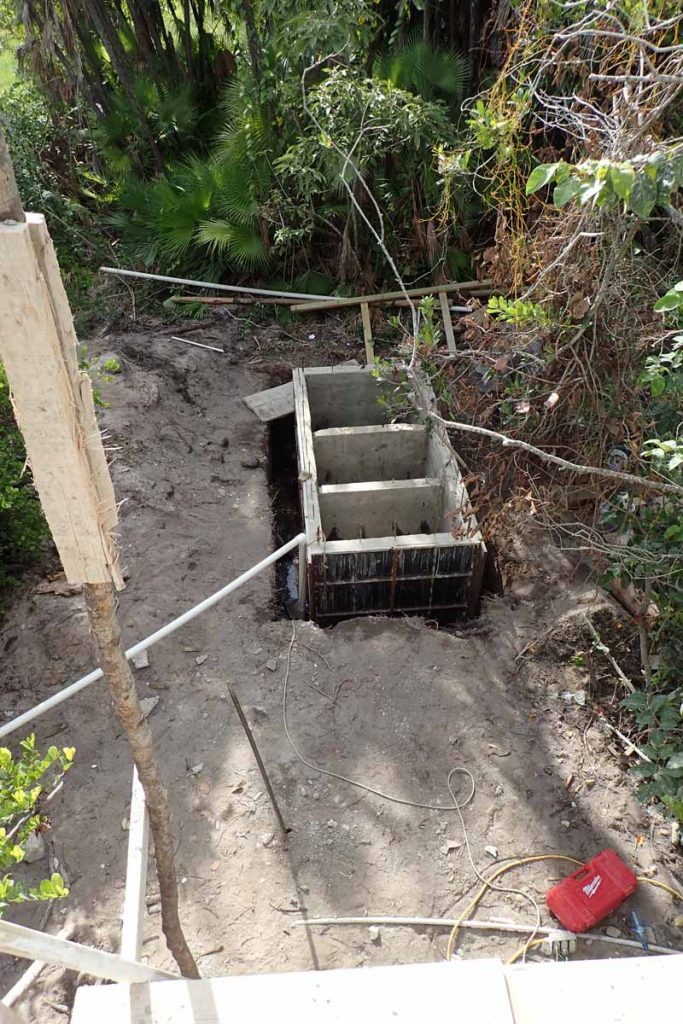

  23. 08/06/2017Manager’s Unit Kitchen, Septic, Priming, etc.

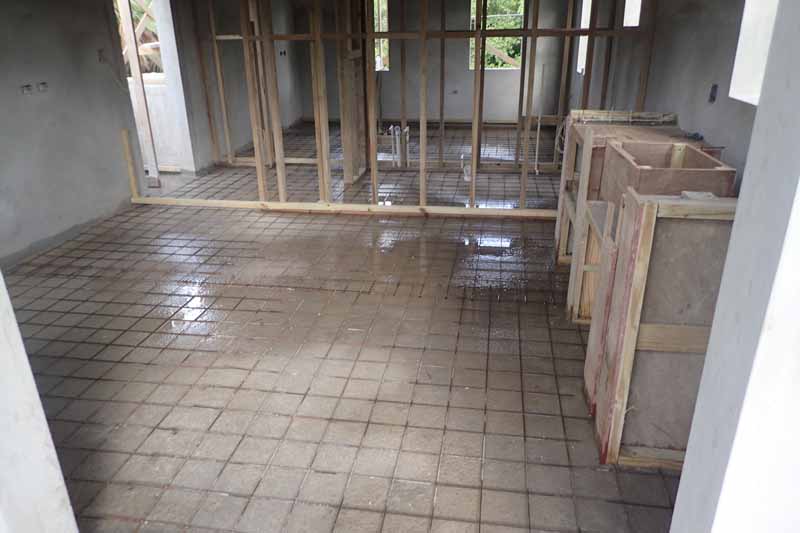

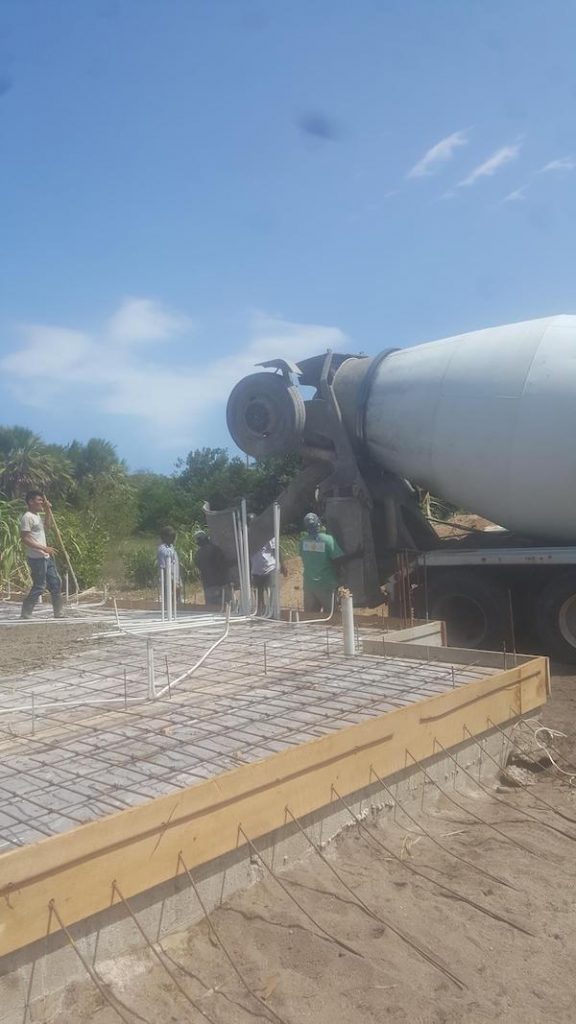

  24. 08/03/2017Framing, Septic Mold & Kitchen 2.

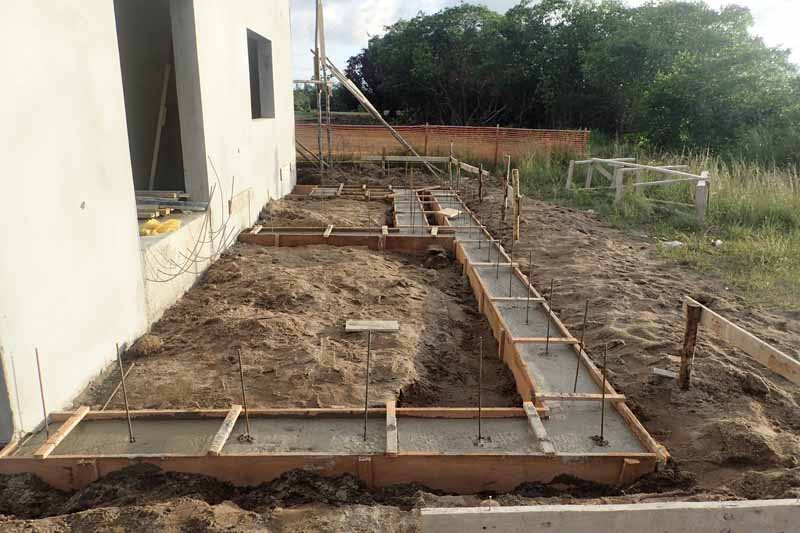

  25. 08/02/2017House 2 Kitchen Pour (not end-product), Manager’s Unit Floor Prep & Concrete work.

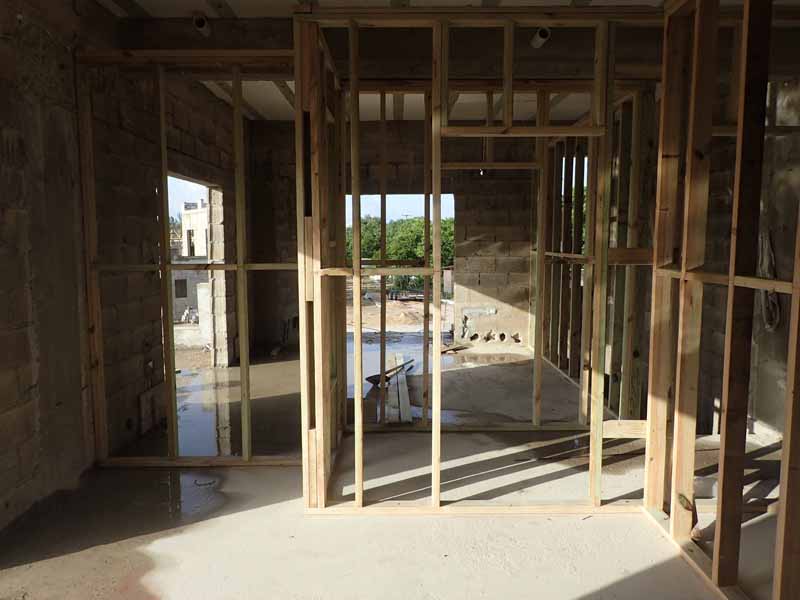

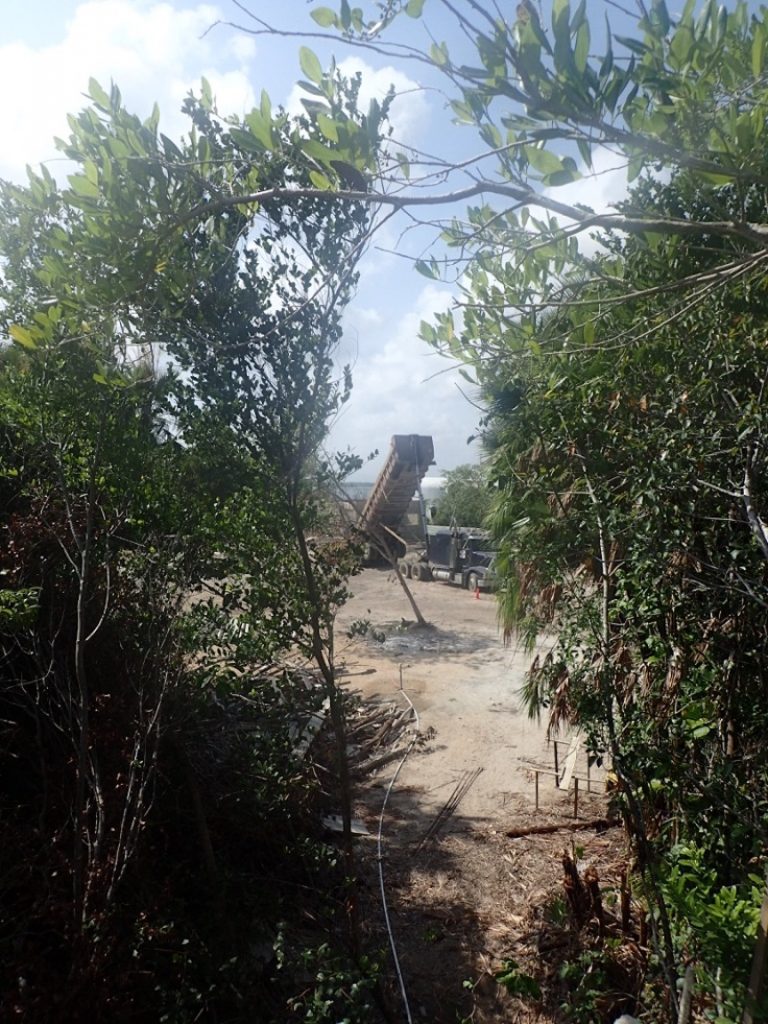

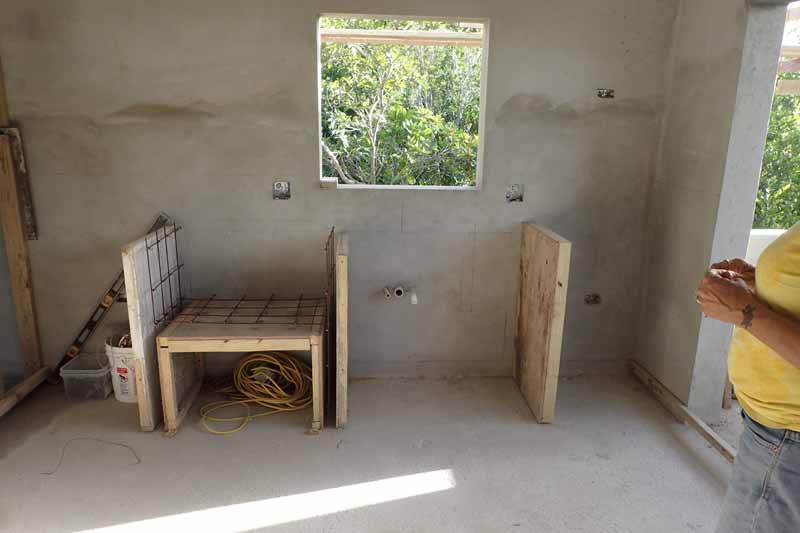

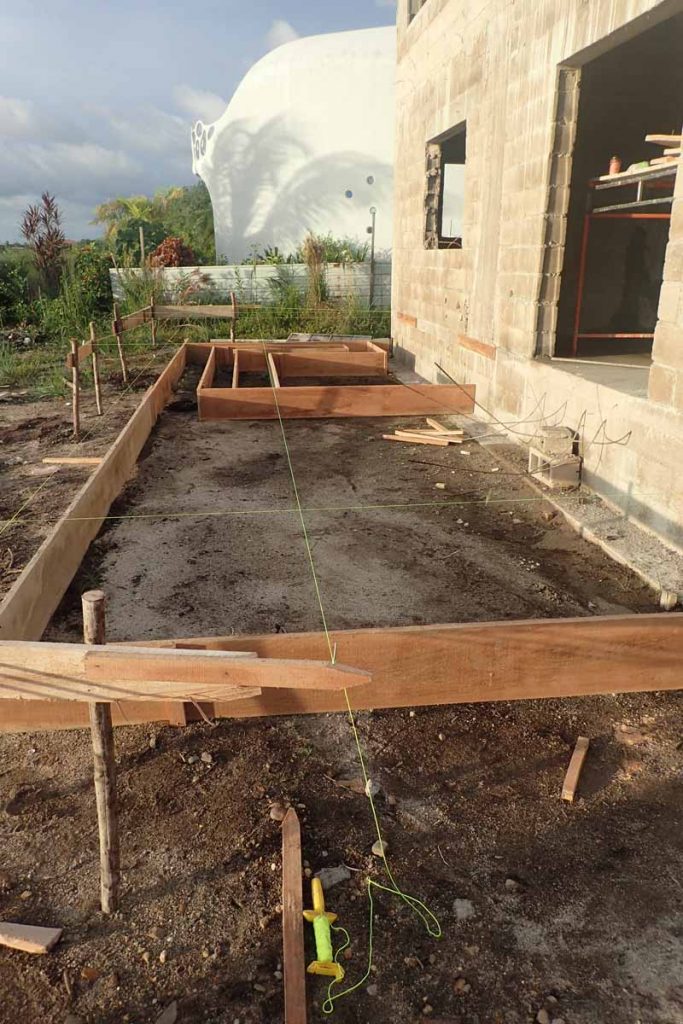

  26. 08/01/2017More Kitchen Forms & Test Floor Patch.
  27. 07/31/2017Concrete, Kitchen Forms & Plumbing.
  28. 07/29/2017Kitchen Forms & Framing.

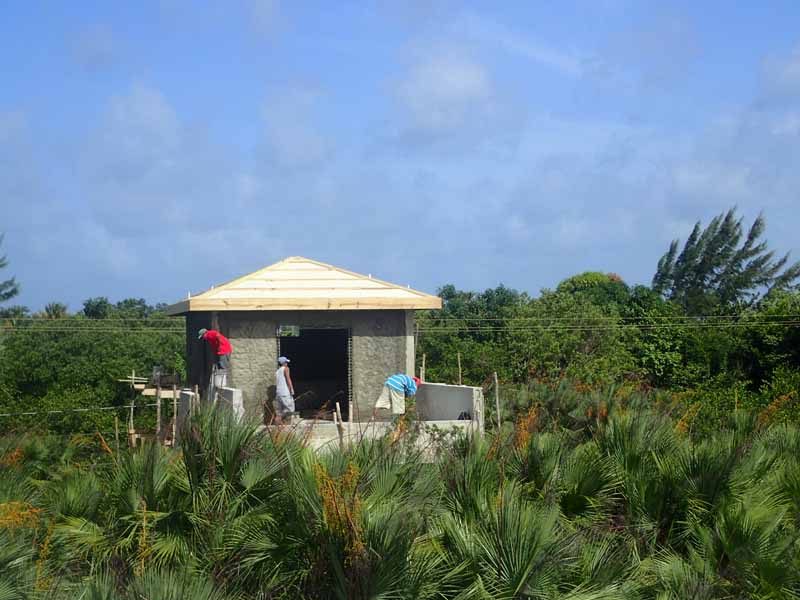

  29. 07/26/2017Framing, Kitchen Layout & Floor Aggregate.

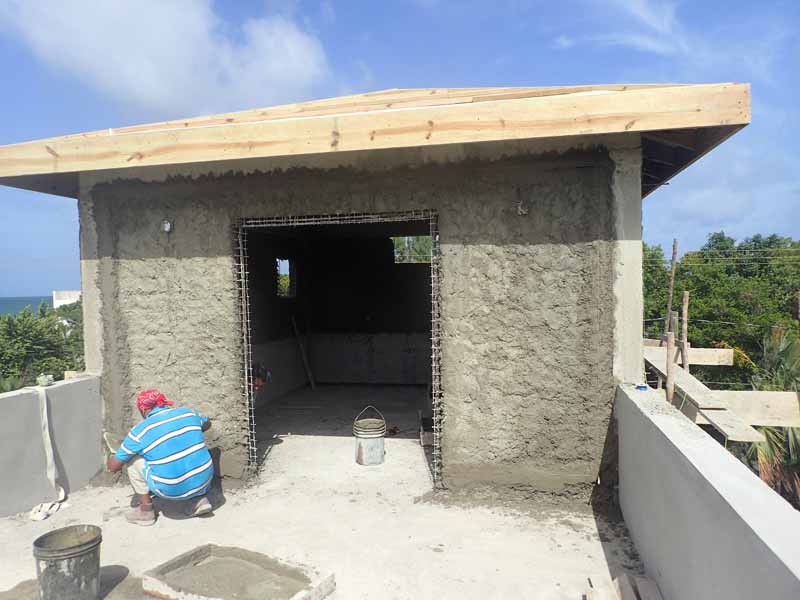

  30. 07/21/2017Landscape Design Planning Weekend.

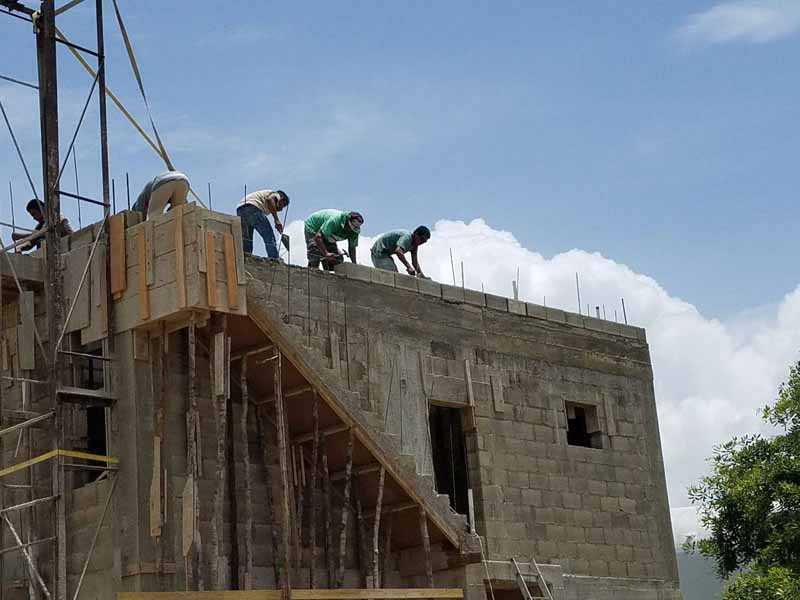

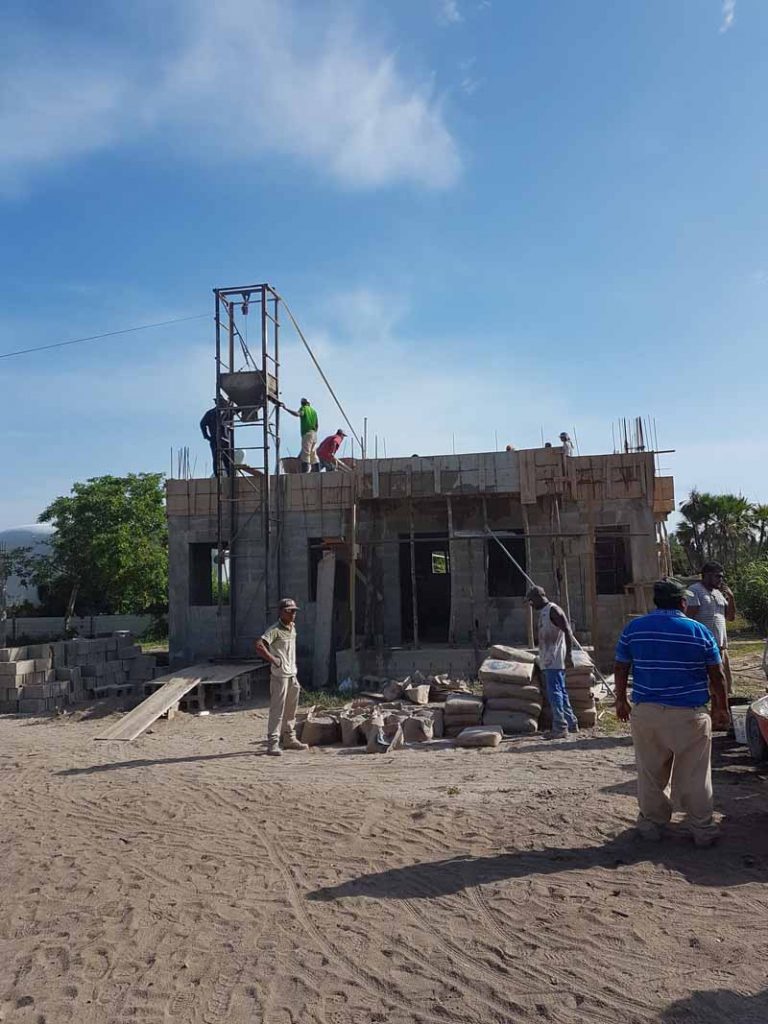

  31. 07/18/2017Third Floor Managers Unit & Misc.

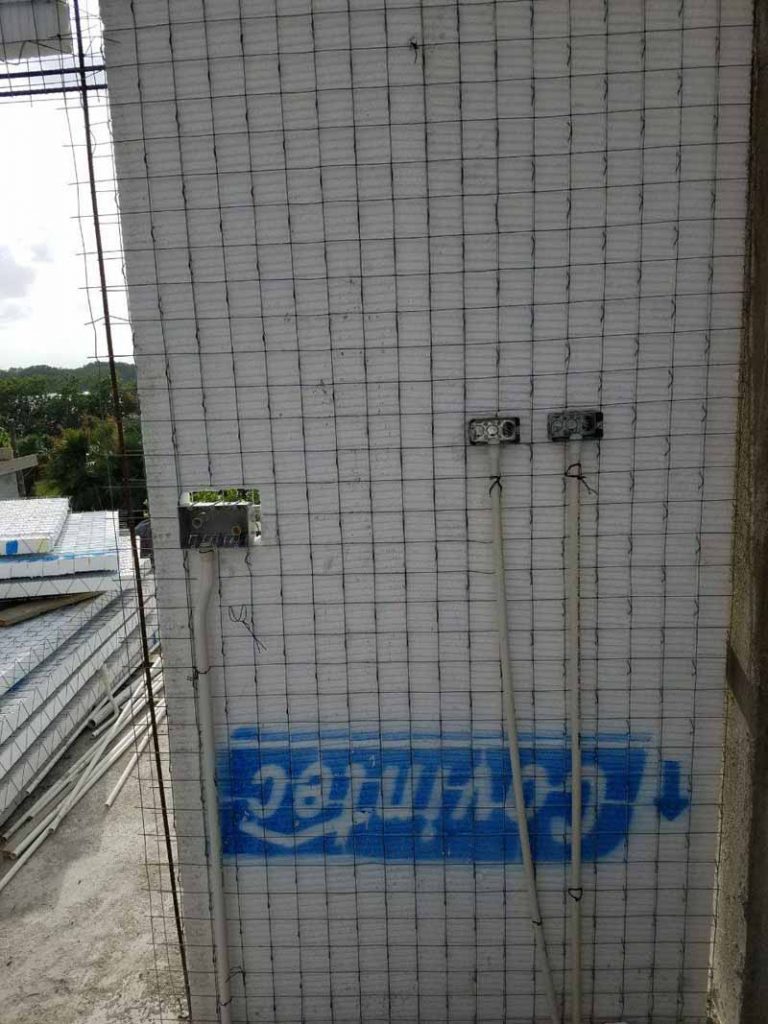

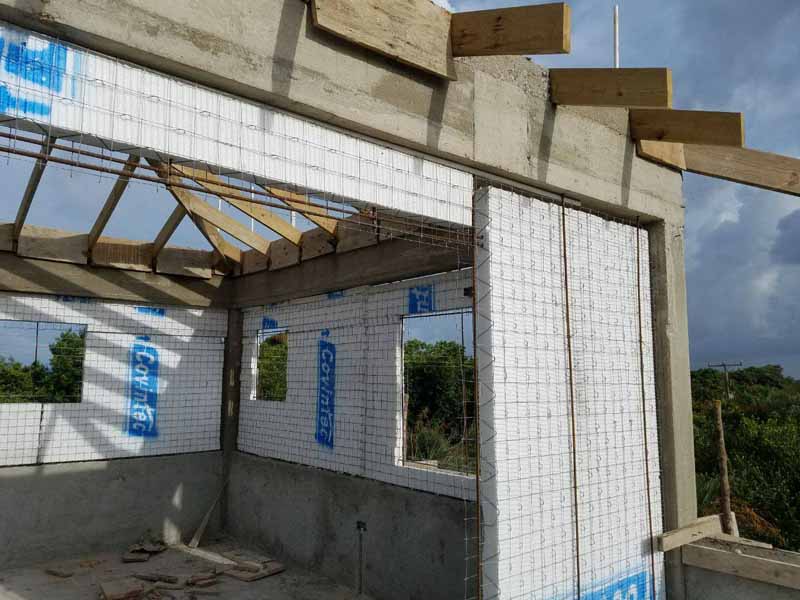

  32. 07/15/2017Endless Concrete & Manager’s Unit Roof.

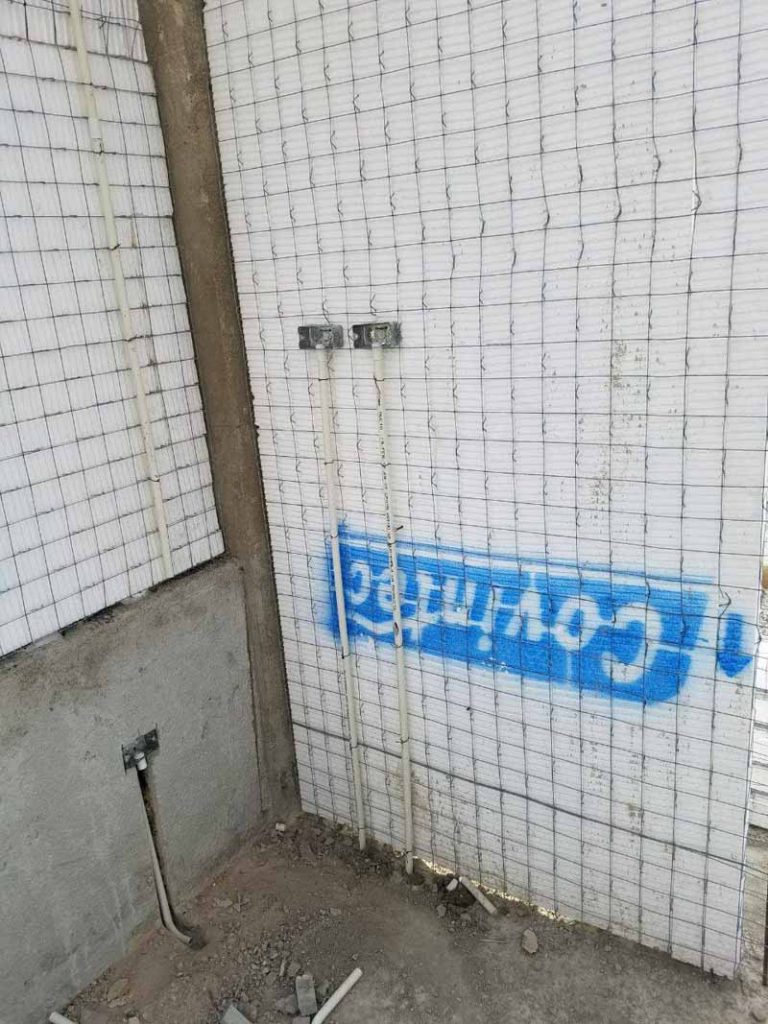

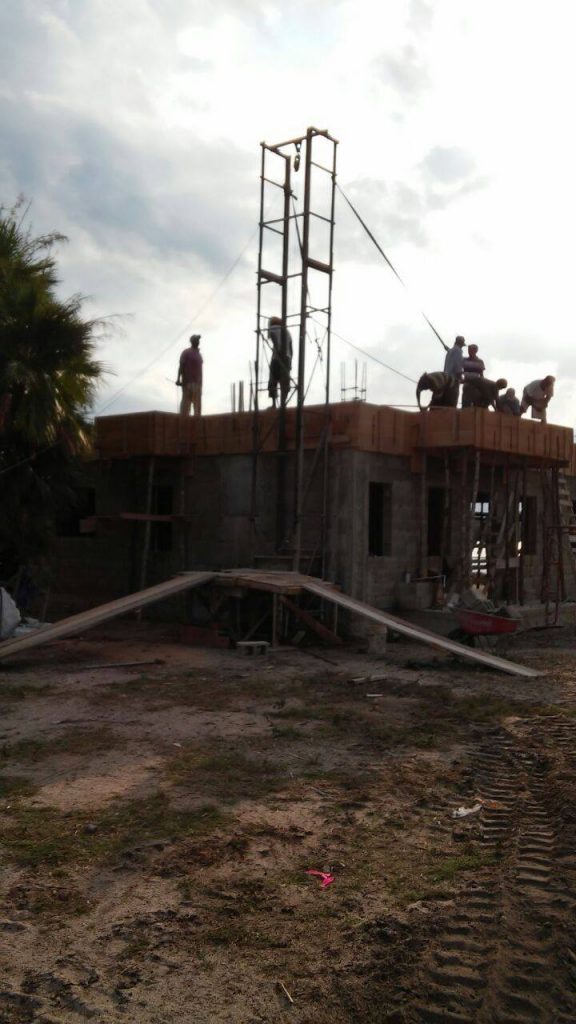

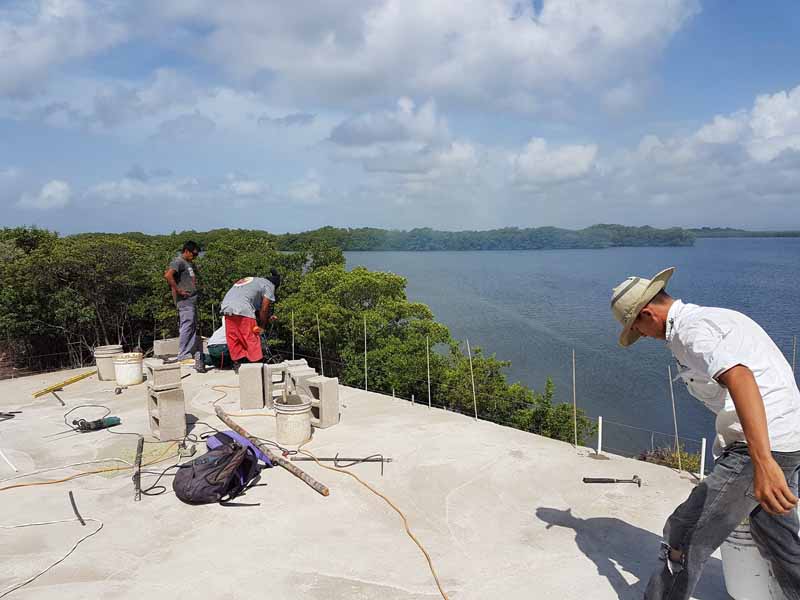

  33. 07/12/2017Concrete & Covintec.

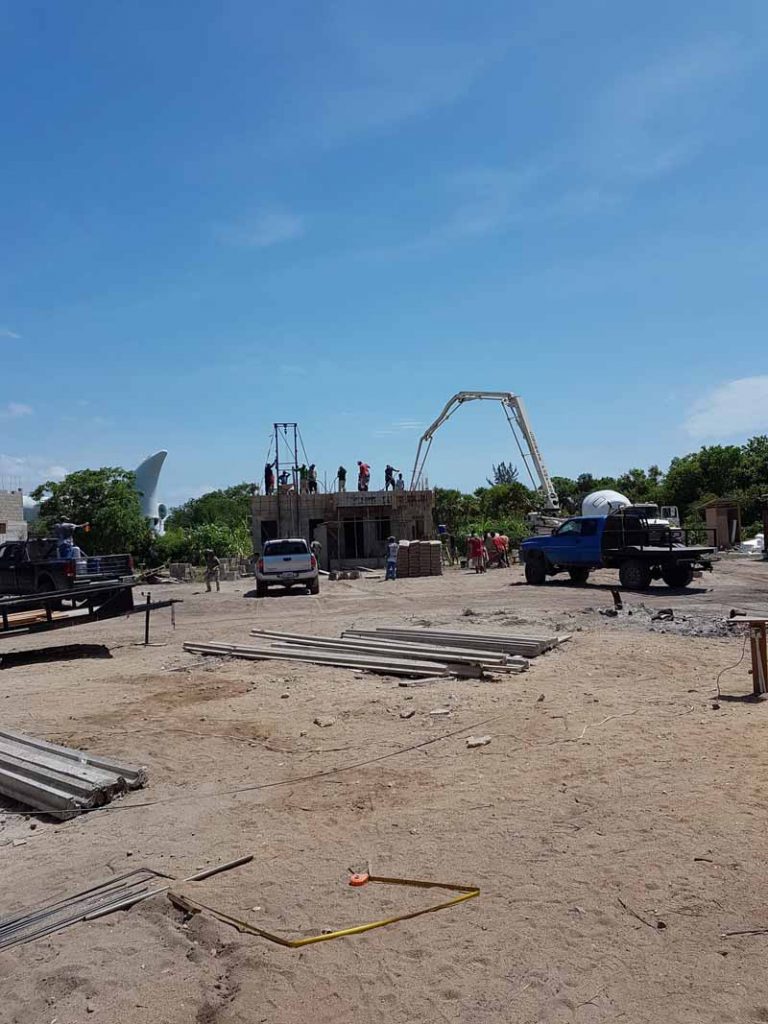

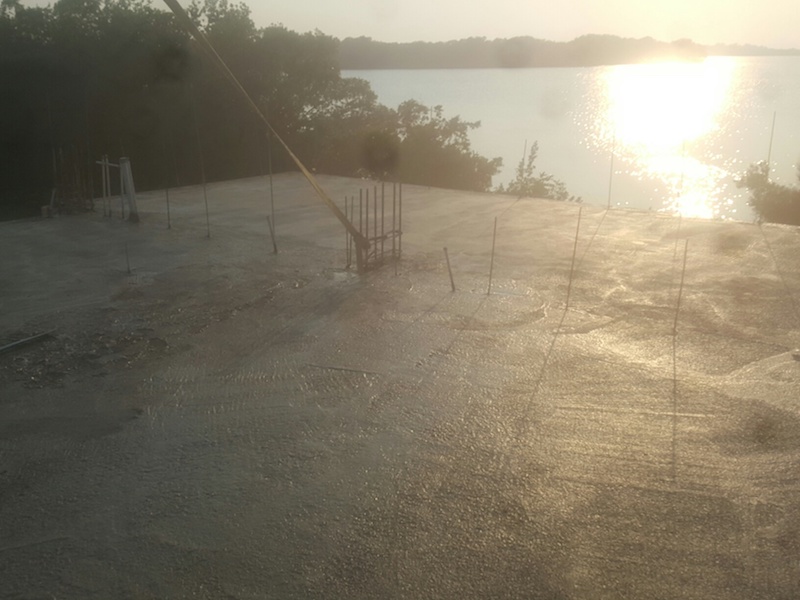

  34. 07/03/2017Starting Roof Deck Walls – House 1.

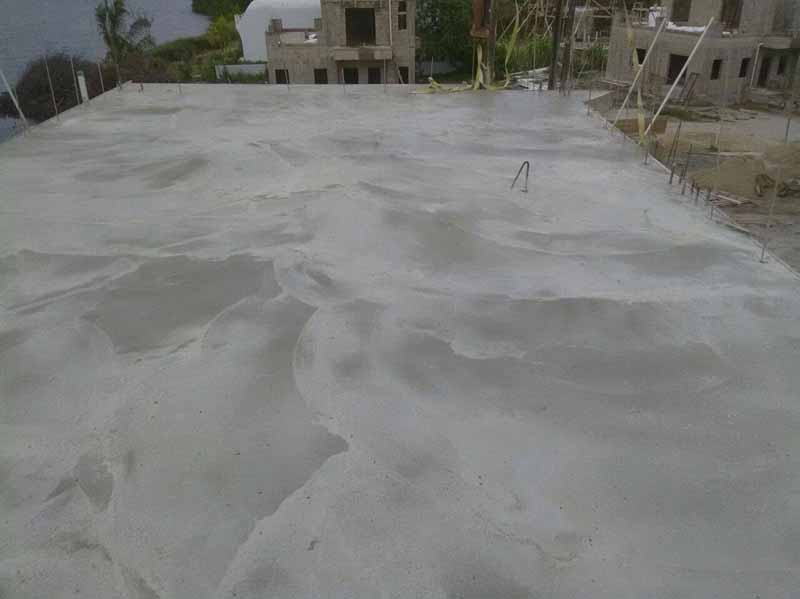

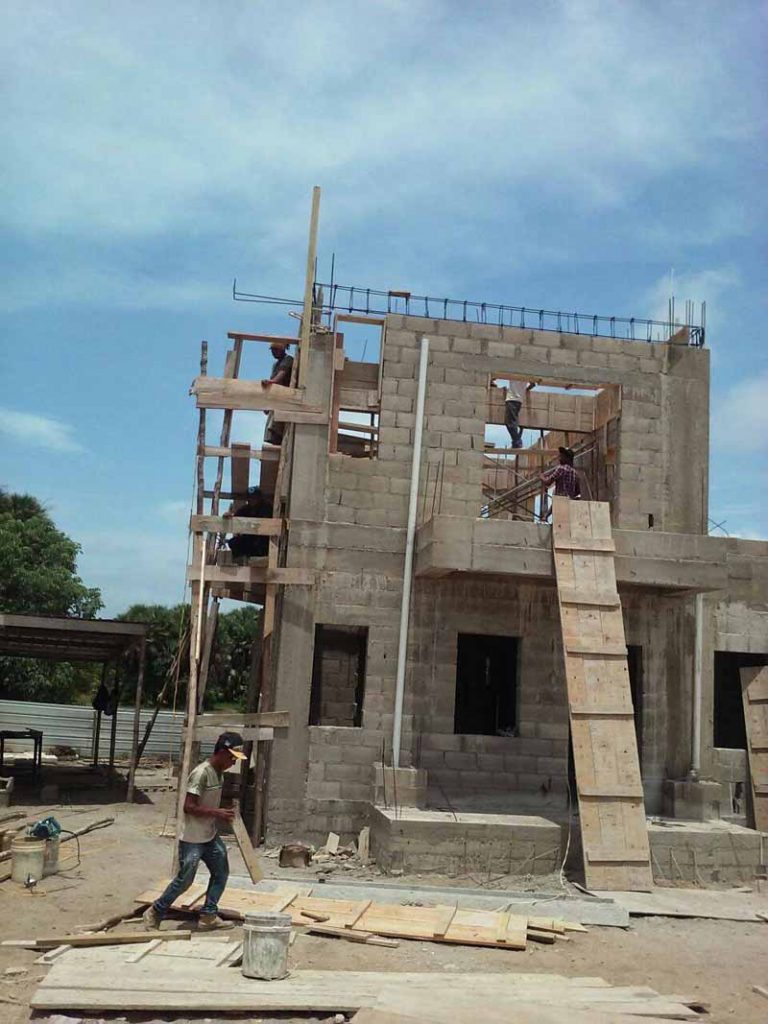

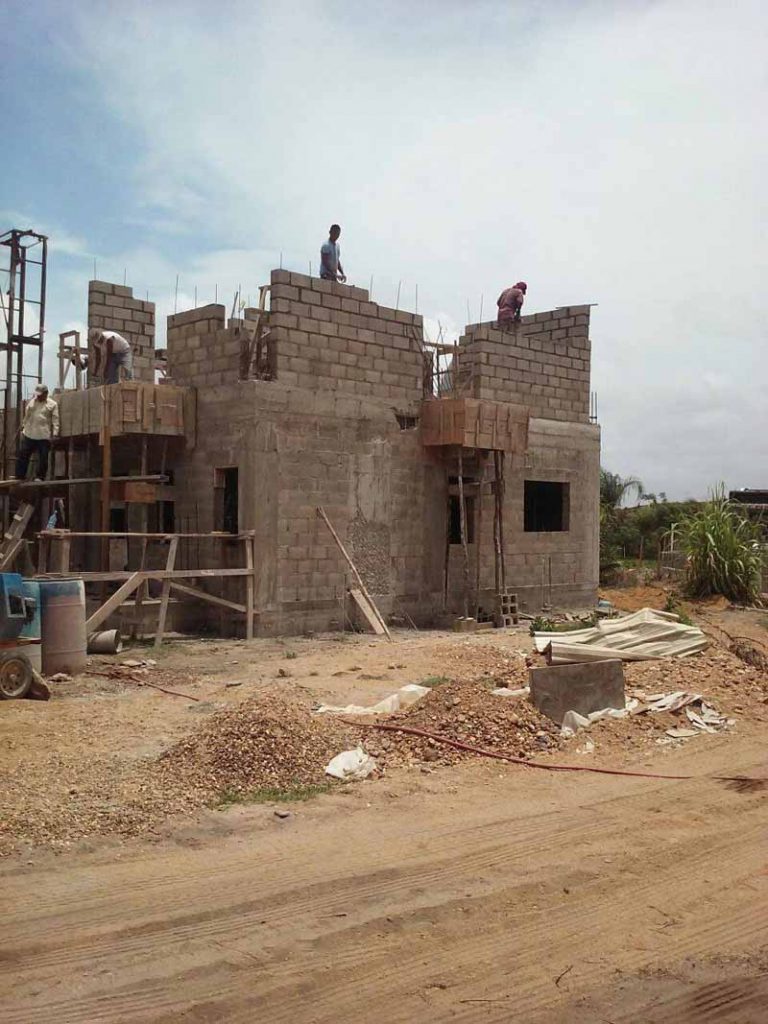

  35. 06/30/2017Pouring Roof on House 1.

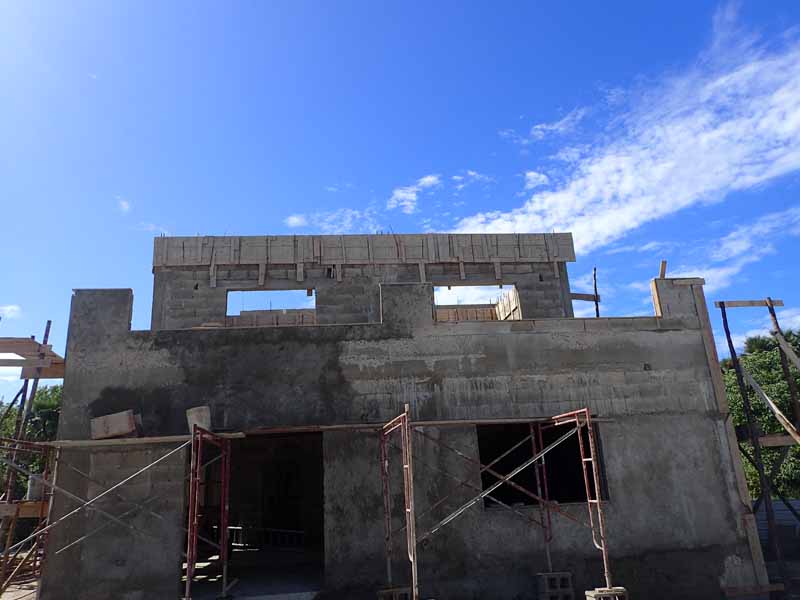

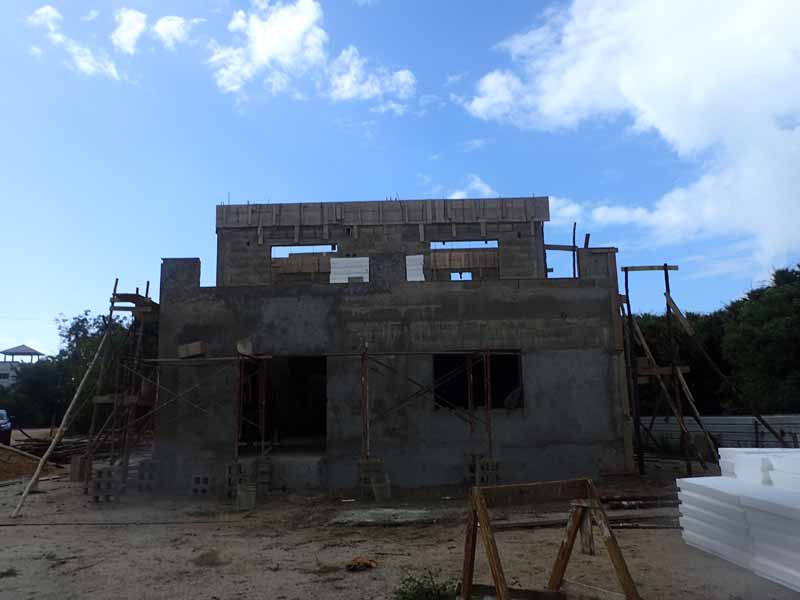

  36. 06/26/2017Second Floor Pics.
  37. 06/23/2017Openings will be railings.
  38. 06/17/2017Still Going Up.
  39. 06/14/2017Rebar & Plastering.

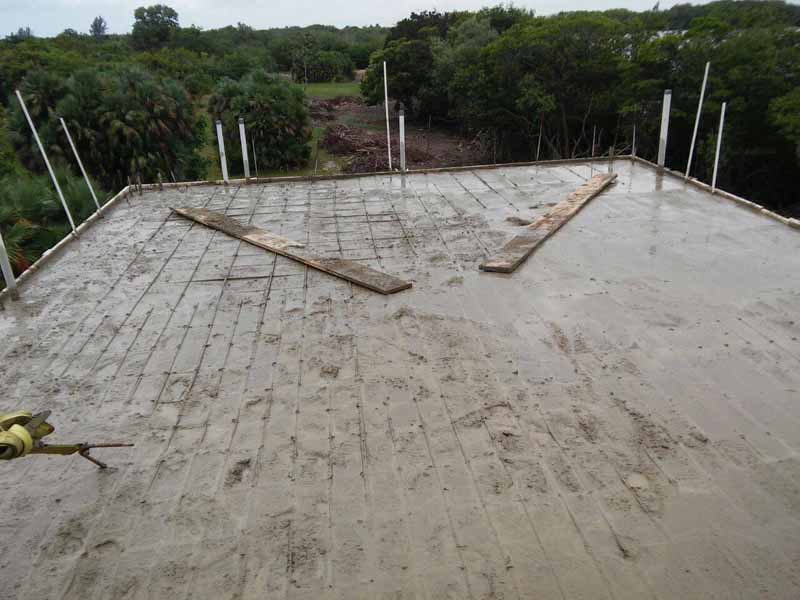

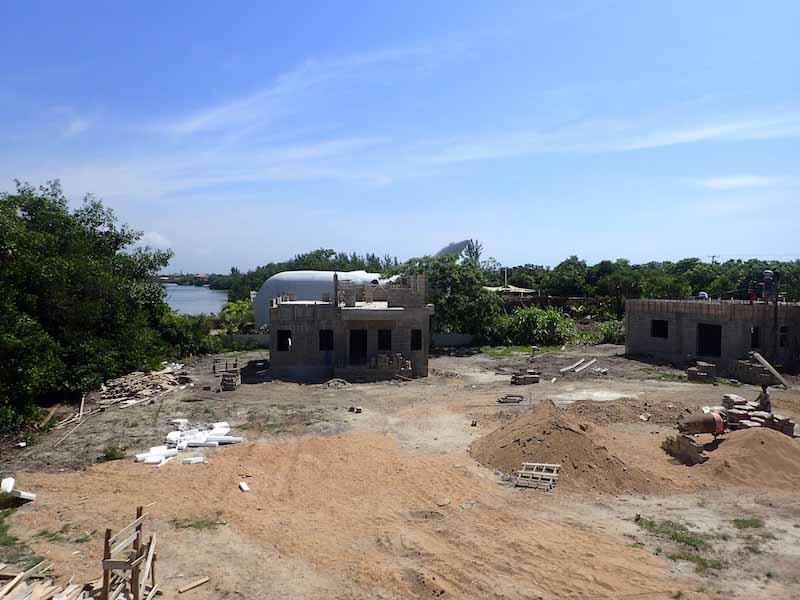

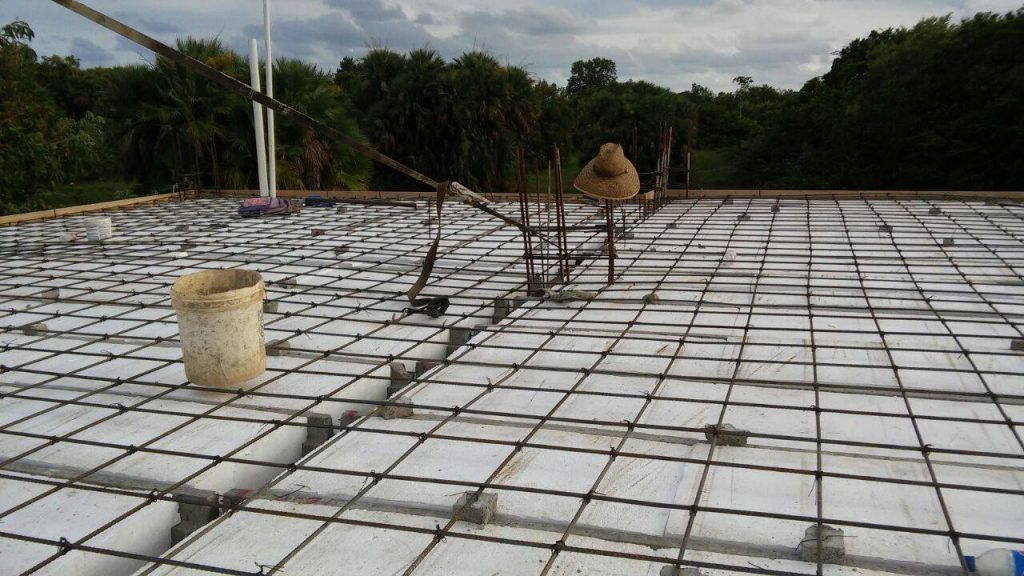

  40. 06/02/2017Preparing roofs for slab.

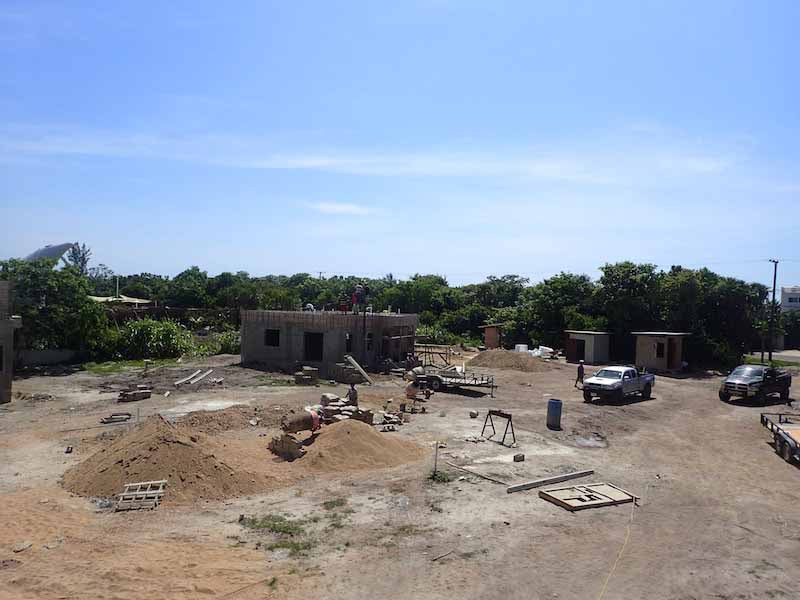

  41. 05/25/2017Pouring Roofs.

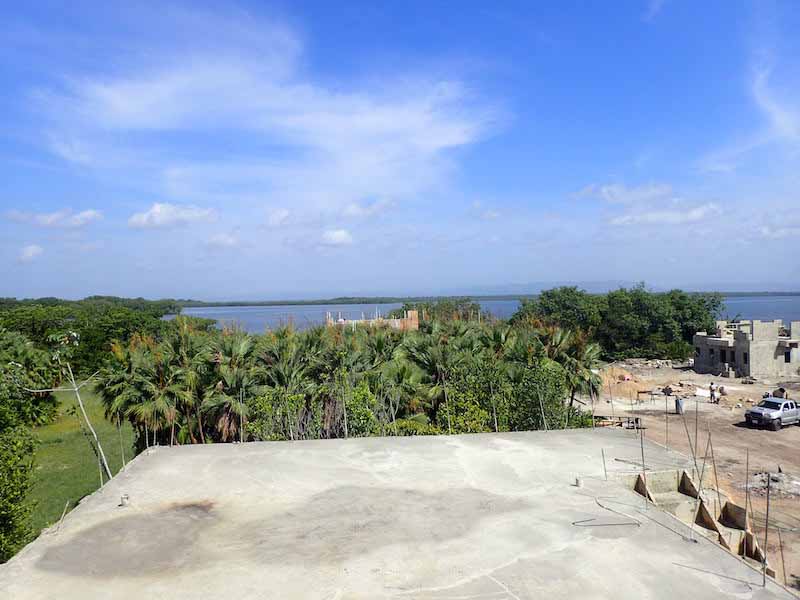

  42. 05/24/2017Conduit/Wiring & Misc.

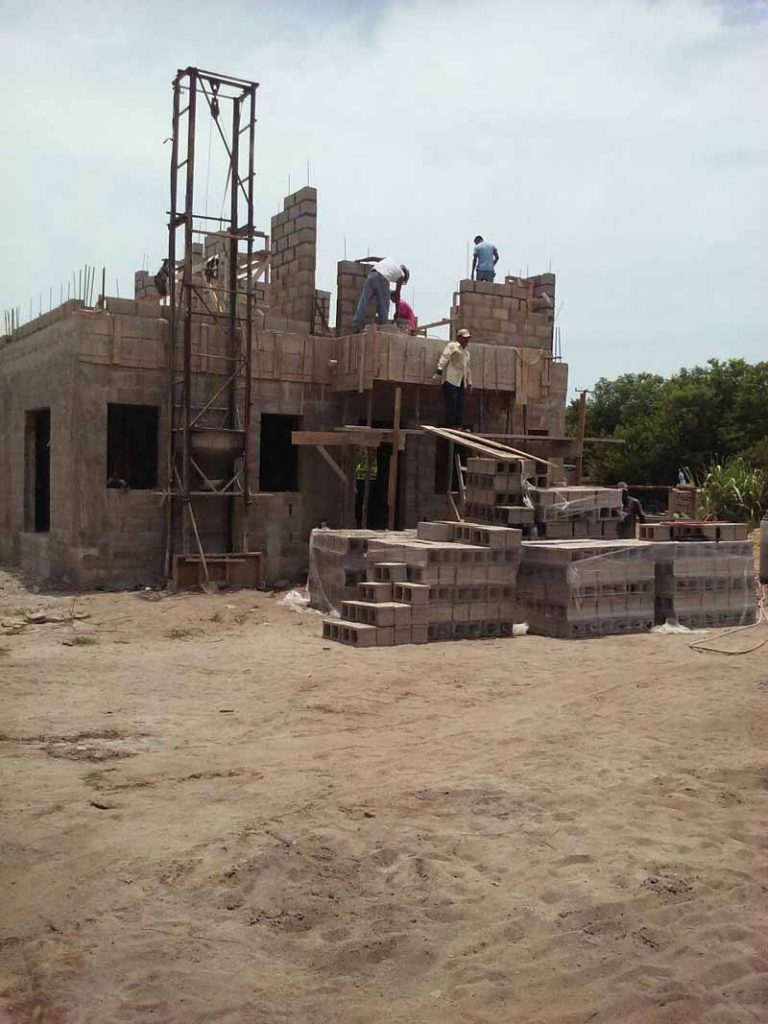

  43. 05/23/2017Pouring Garage Roof.
  44. 05/19/2017Reaching for the roofs.

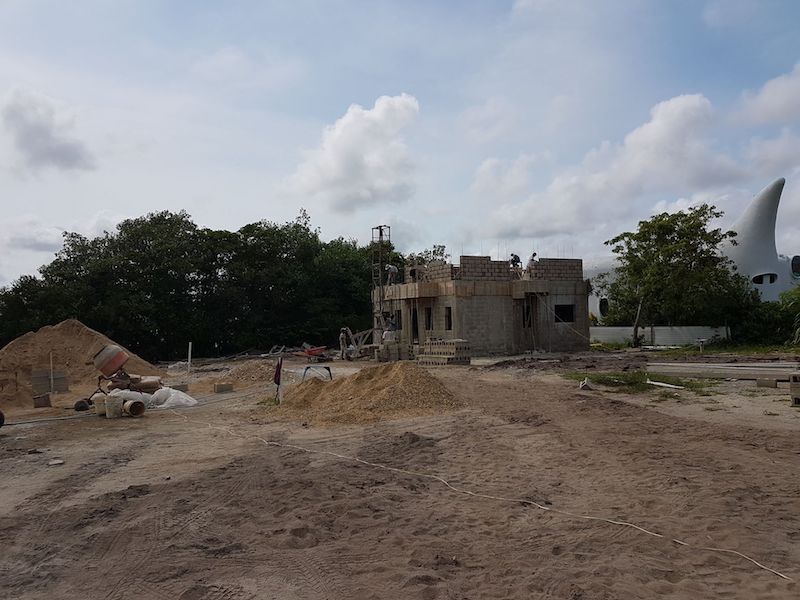

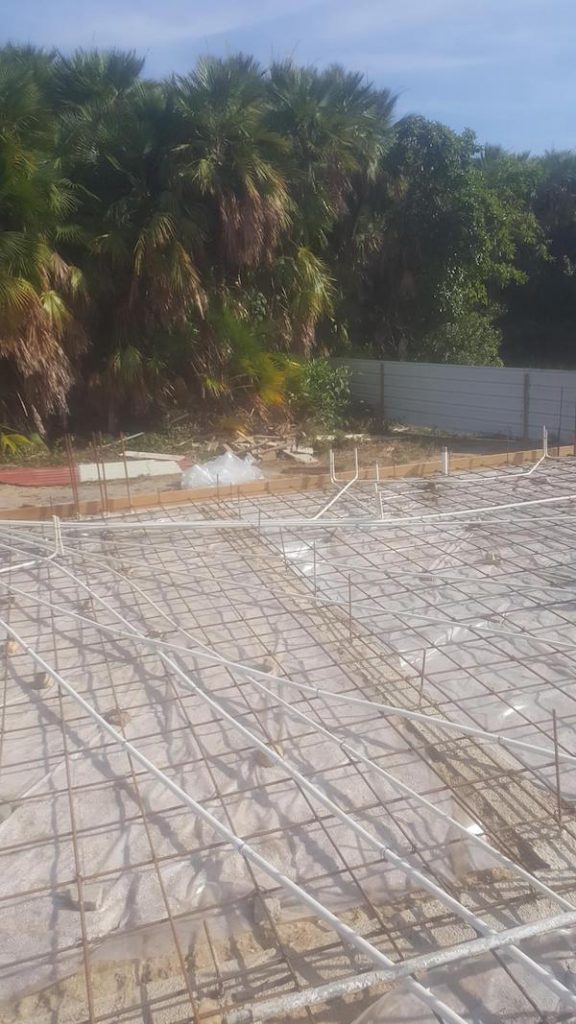

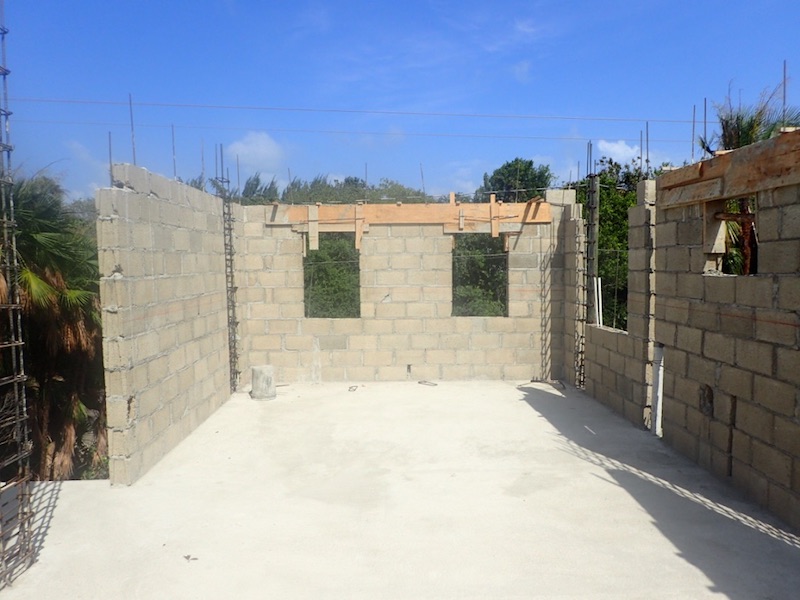

  45. 05/12/2017Second floor underway on 4 out of 5 structures.
  46. 05/08/2017Preparing House 3 for Slab Pour & 2nd Floor Walls on House 1 & 2.

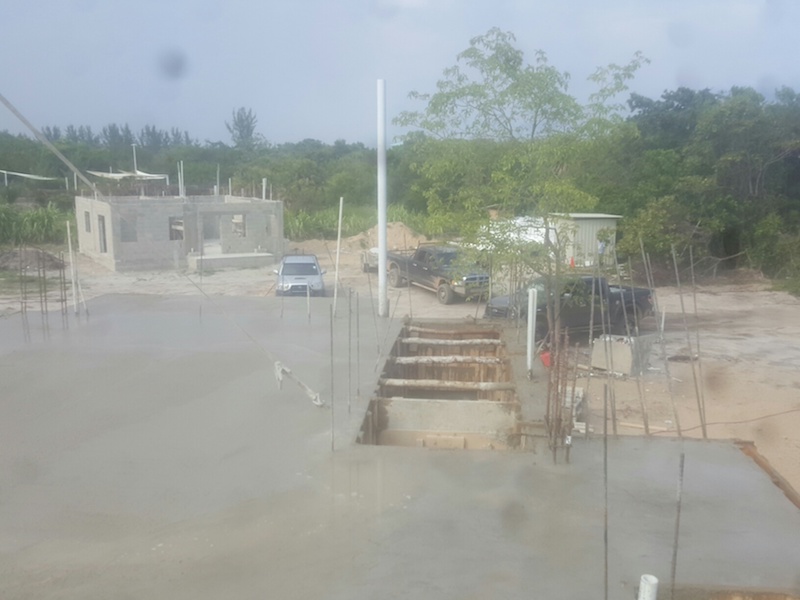

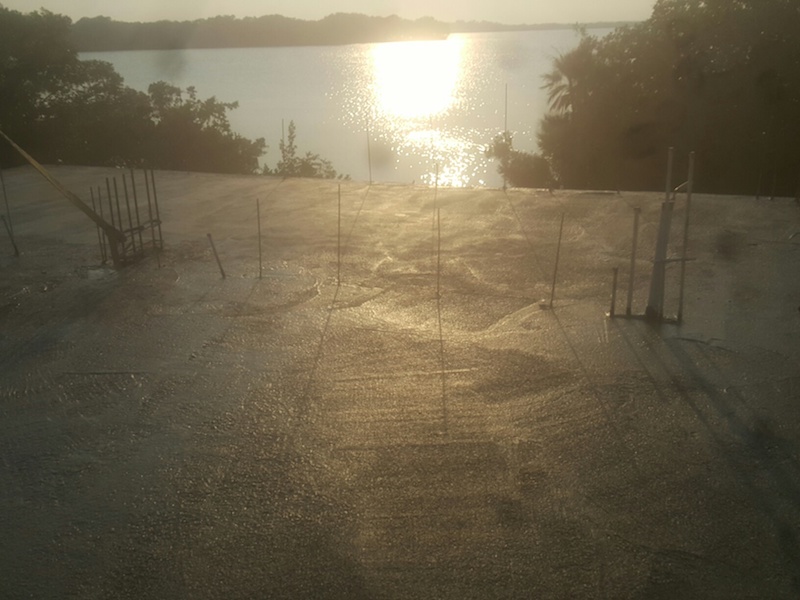

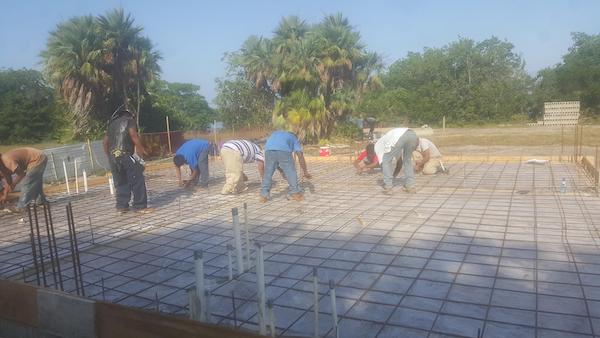

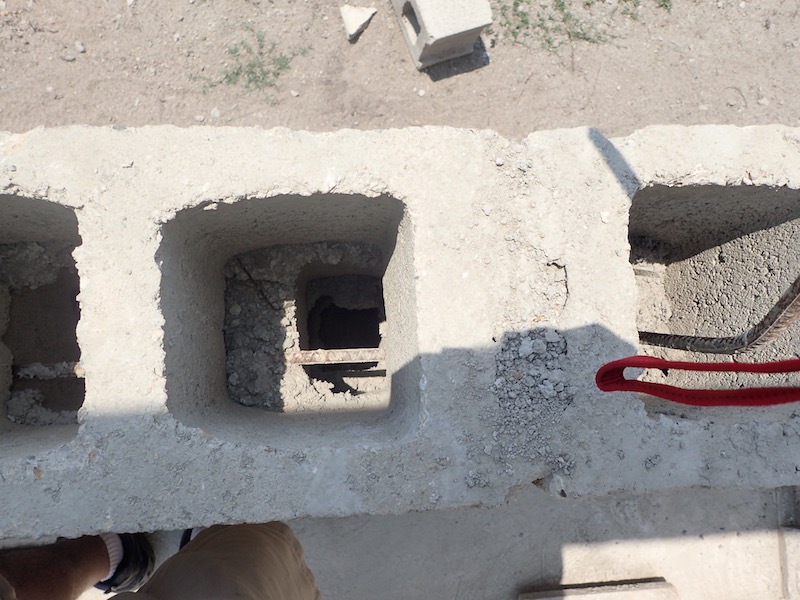

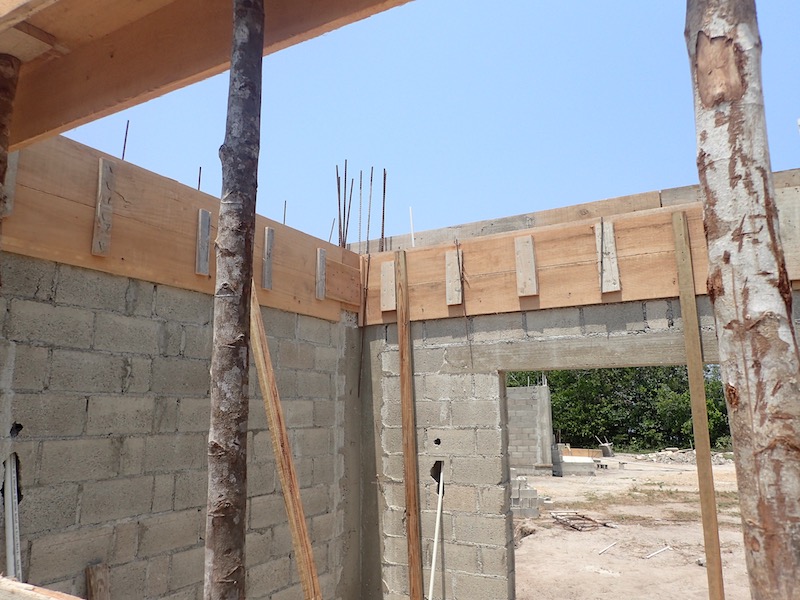

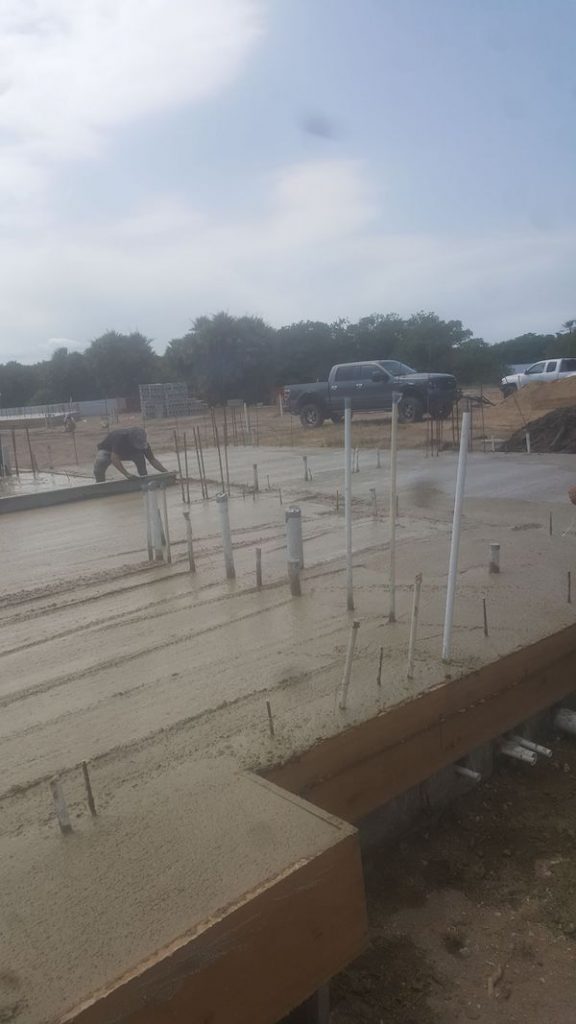

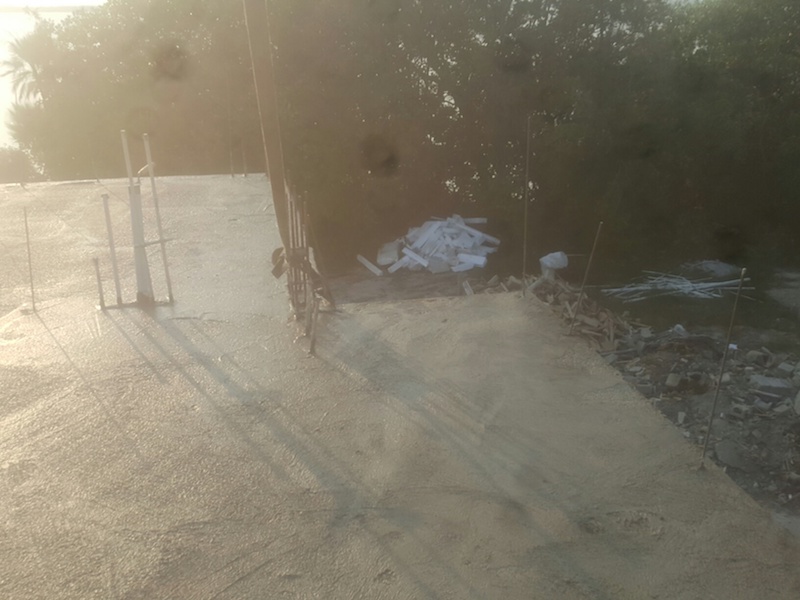

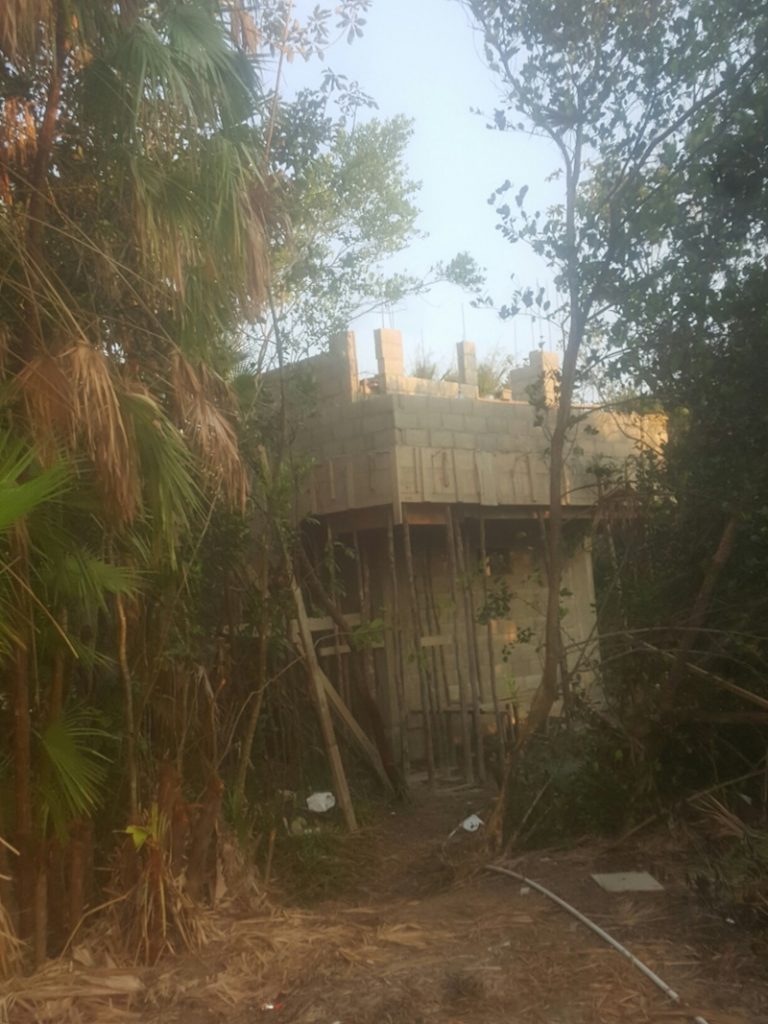

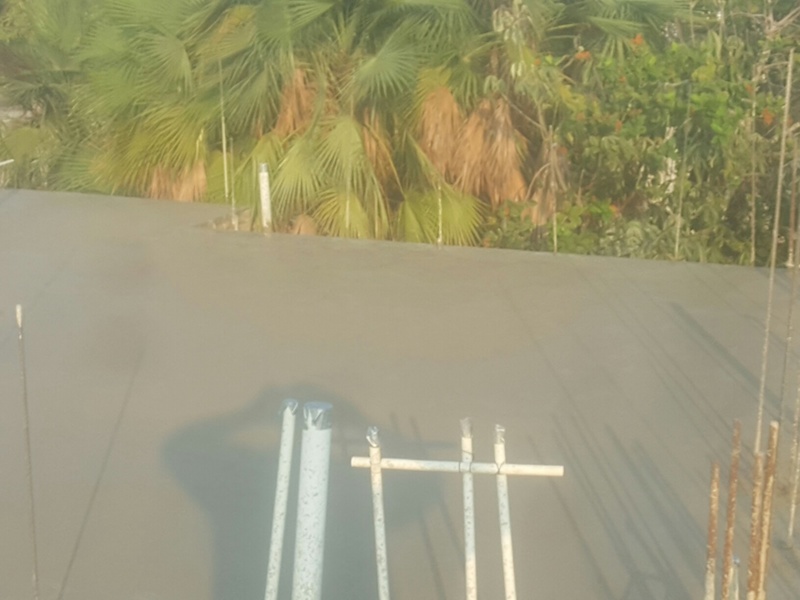

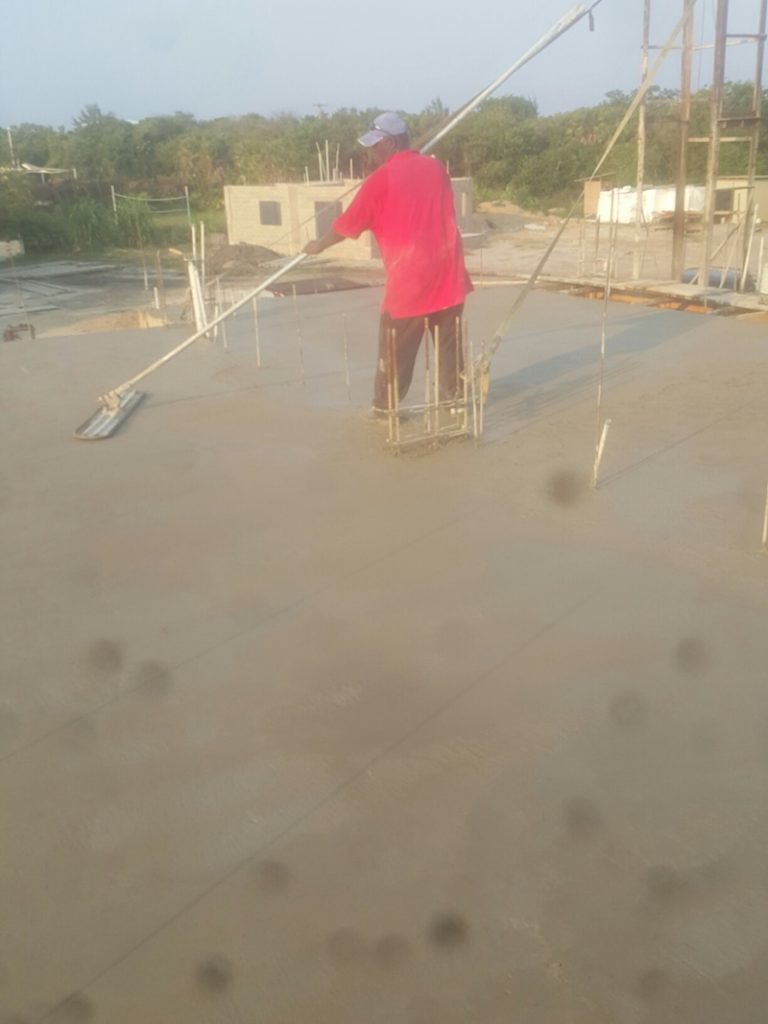

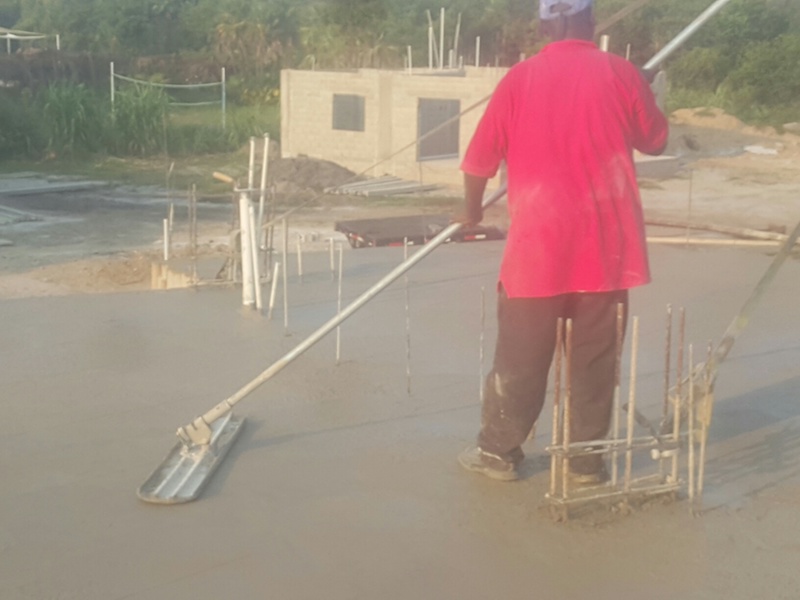

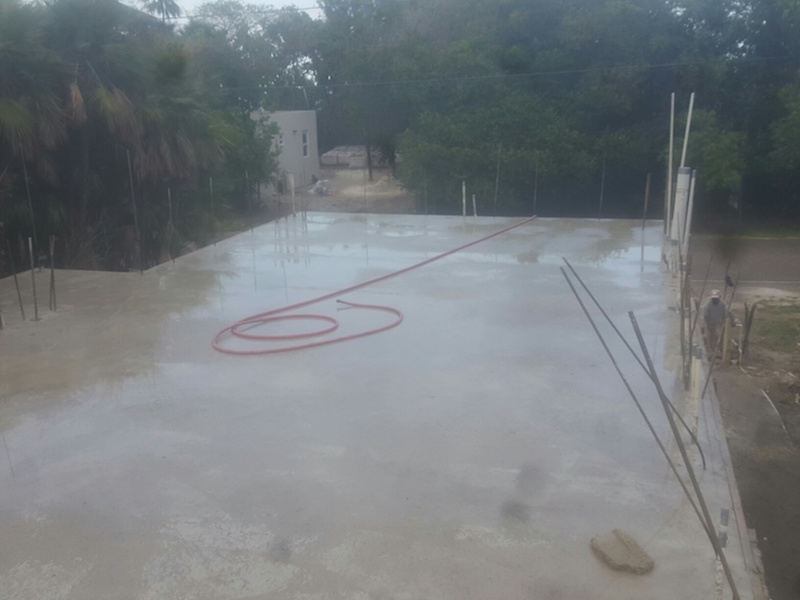

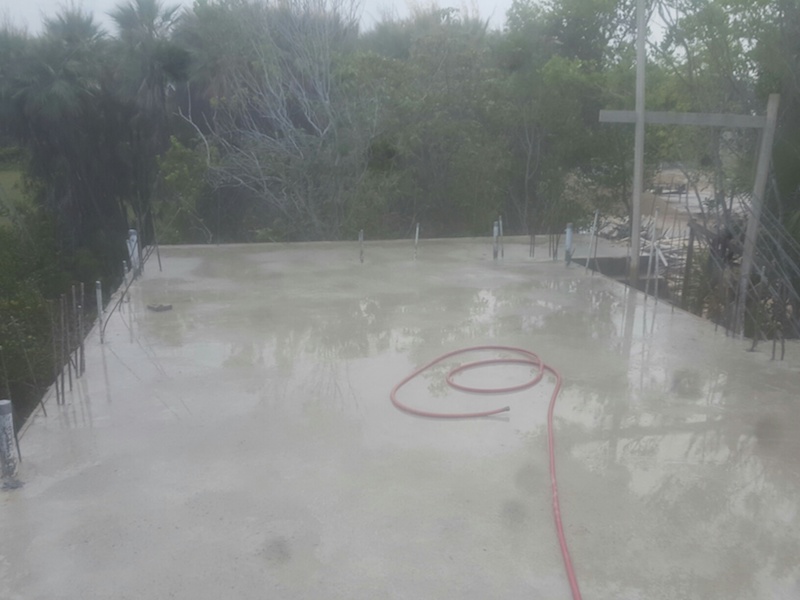

  47. 05/02/2017Materials & Walls going up.

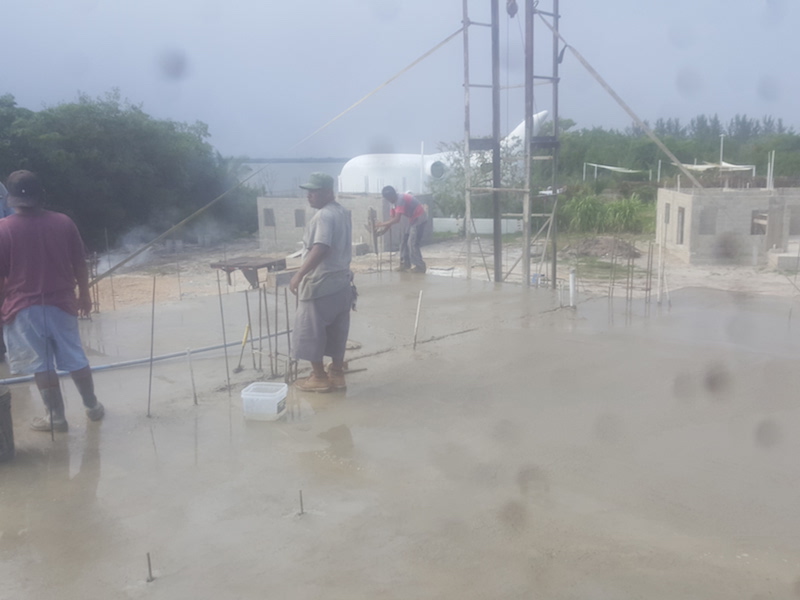

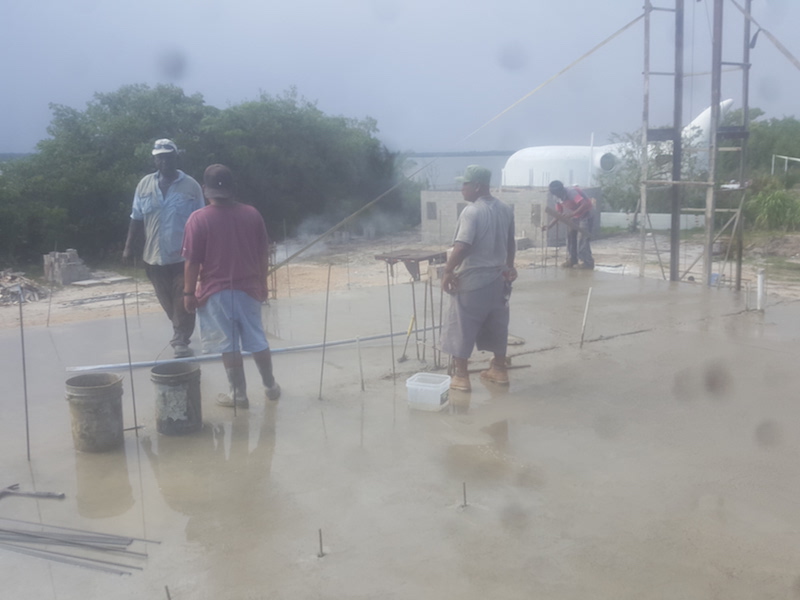

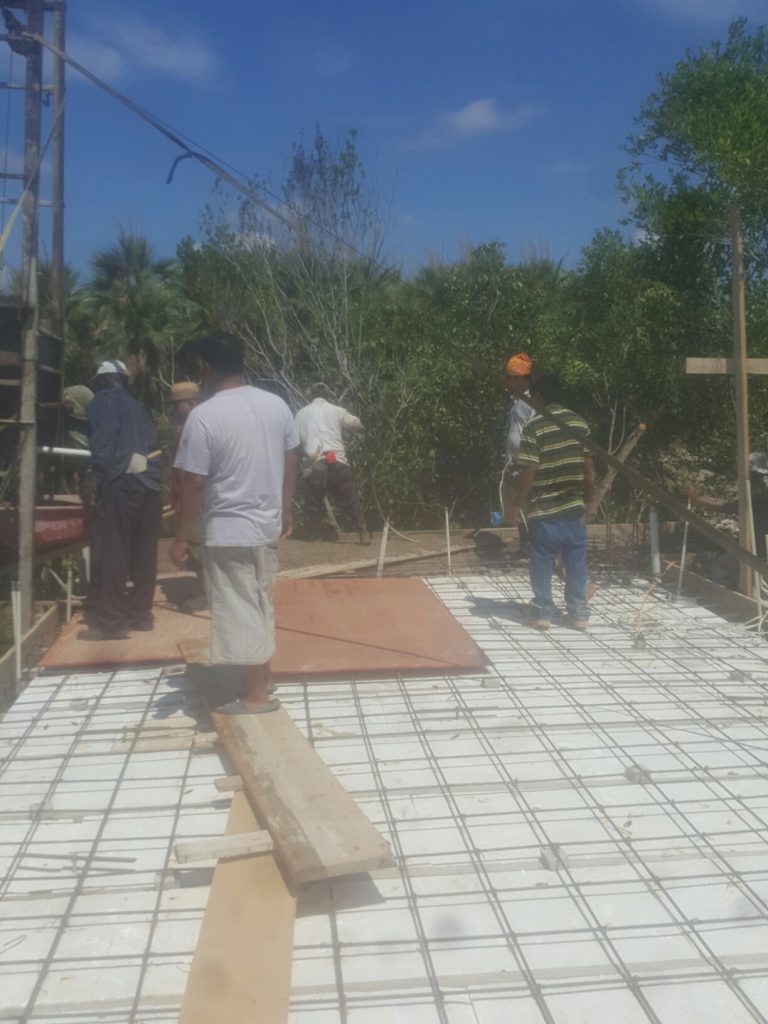

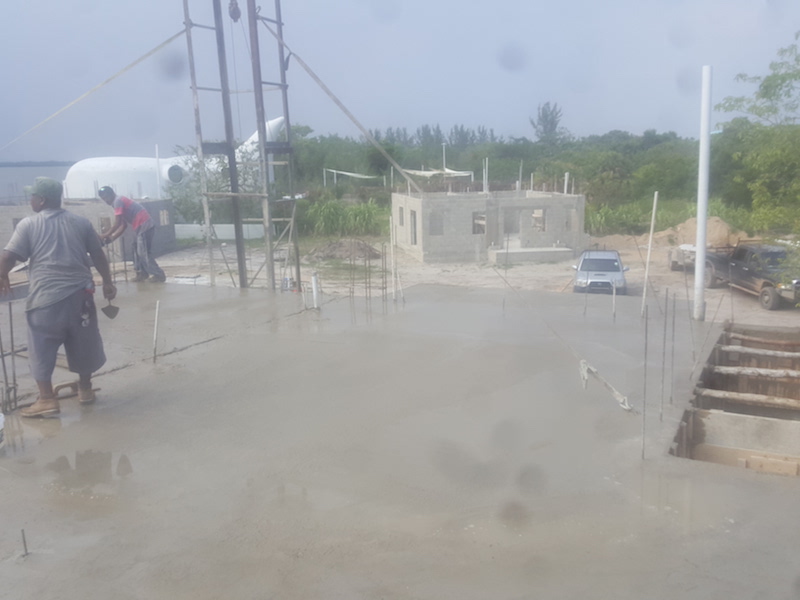

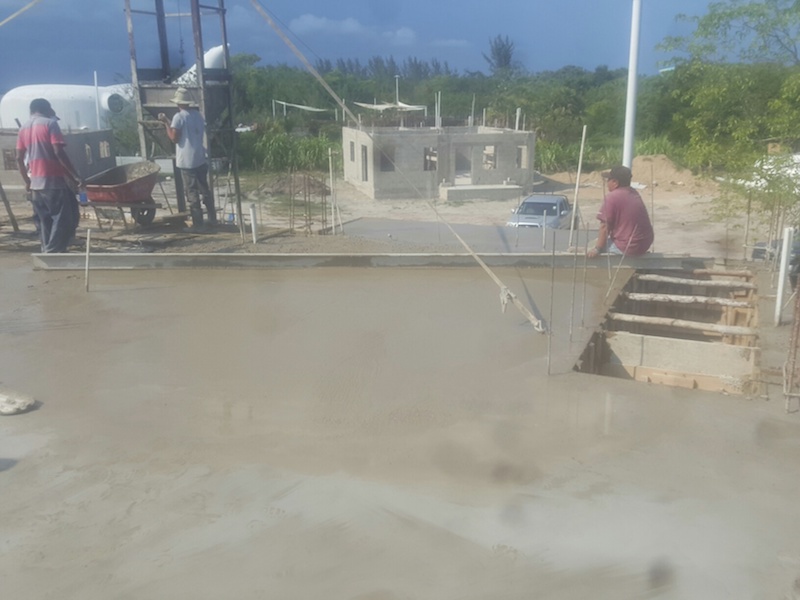

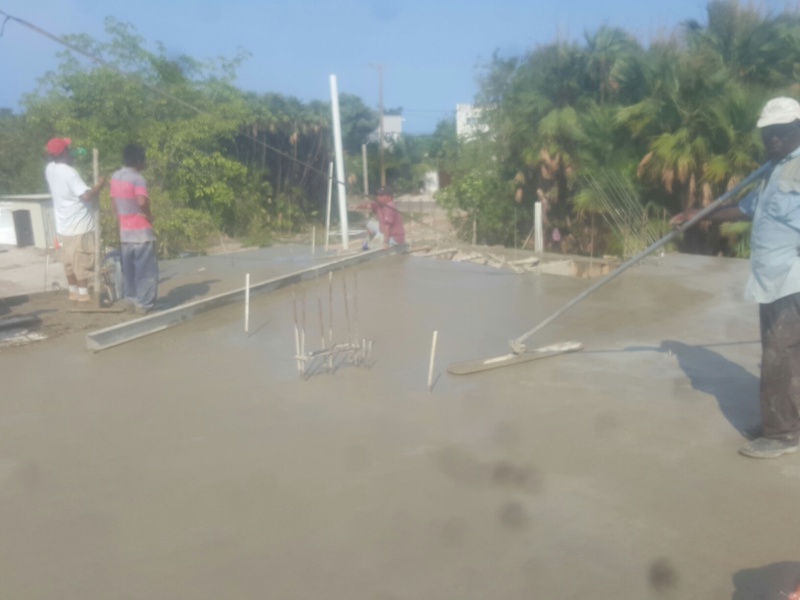

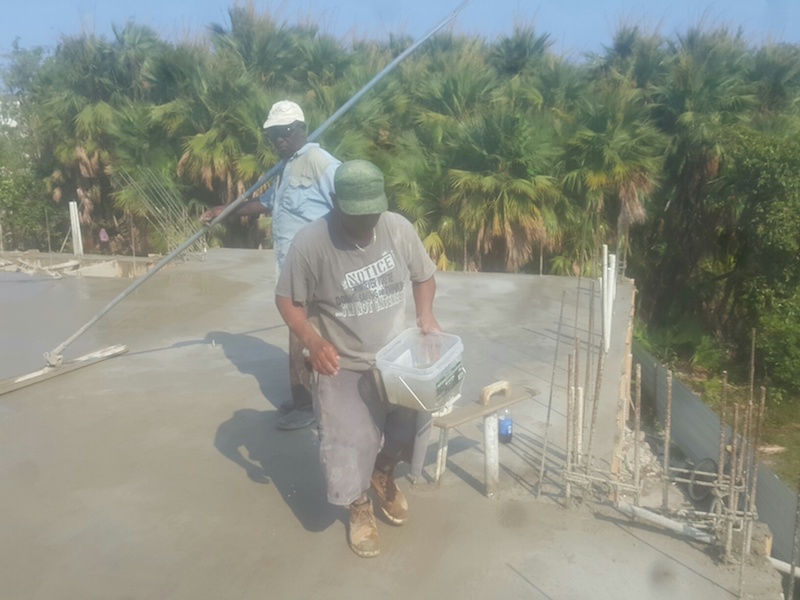

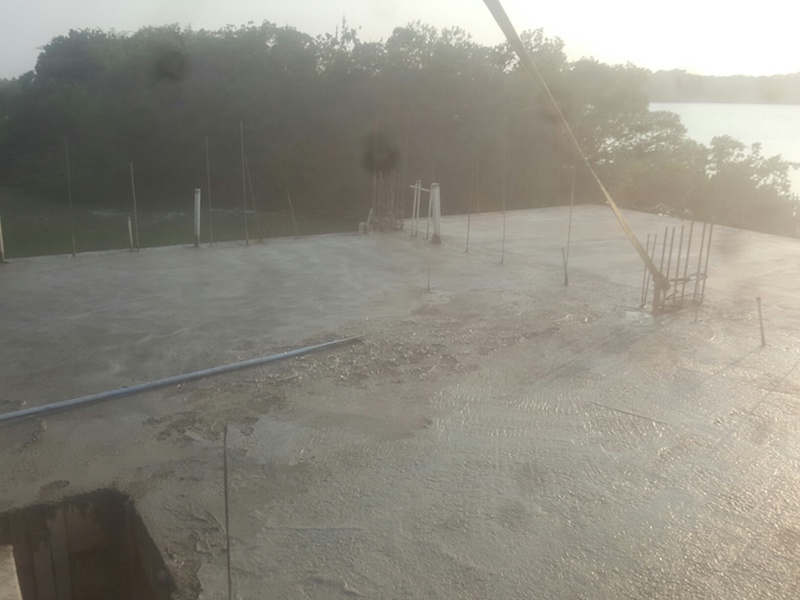

  48. 04/26/2017House 1 – Second Floor Slab Pour & Apt.

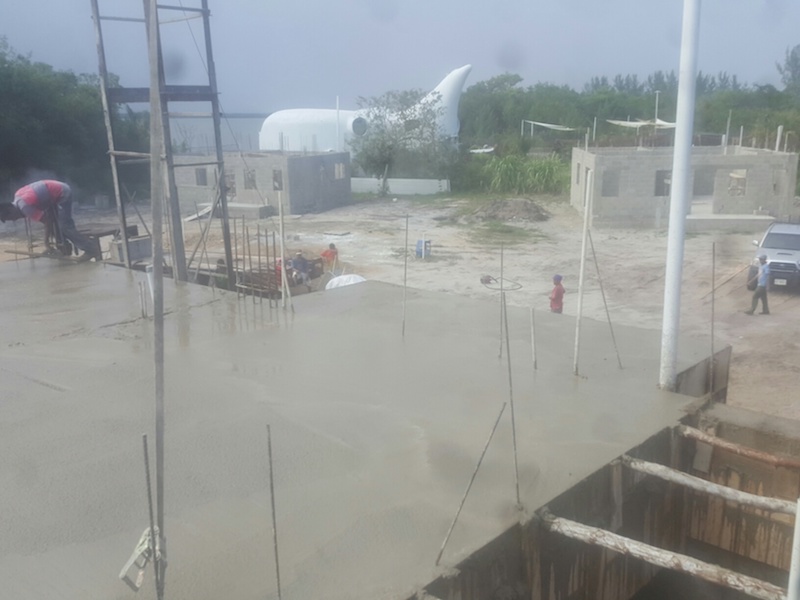

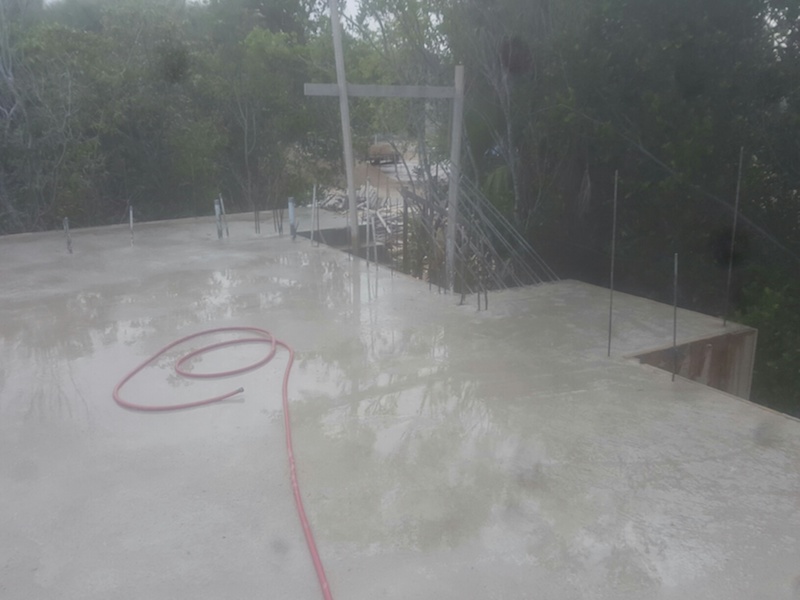

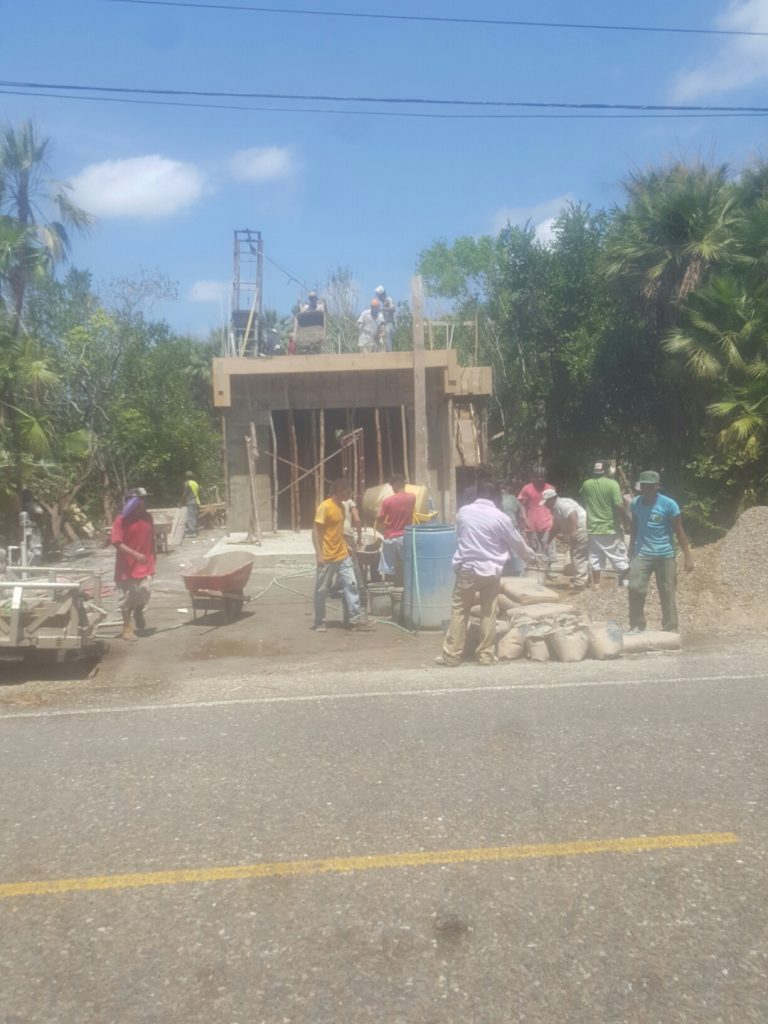

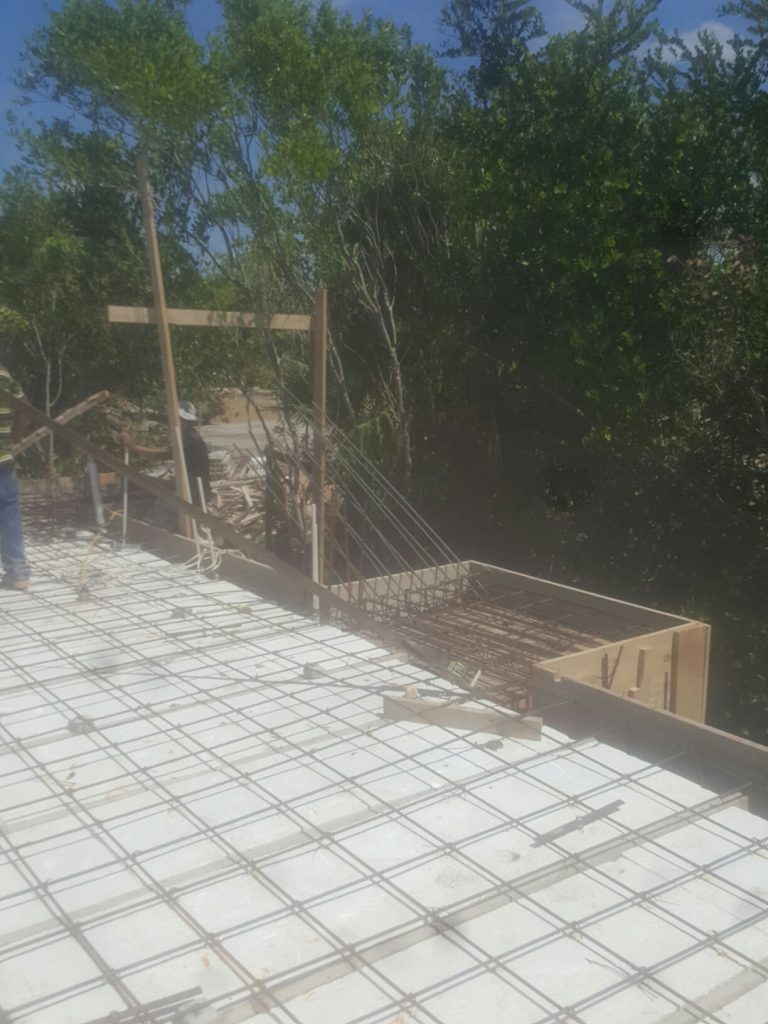

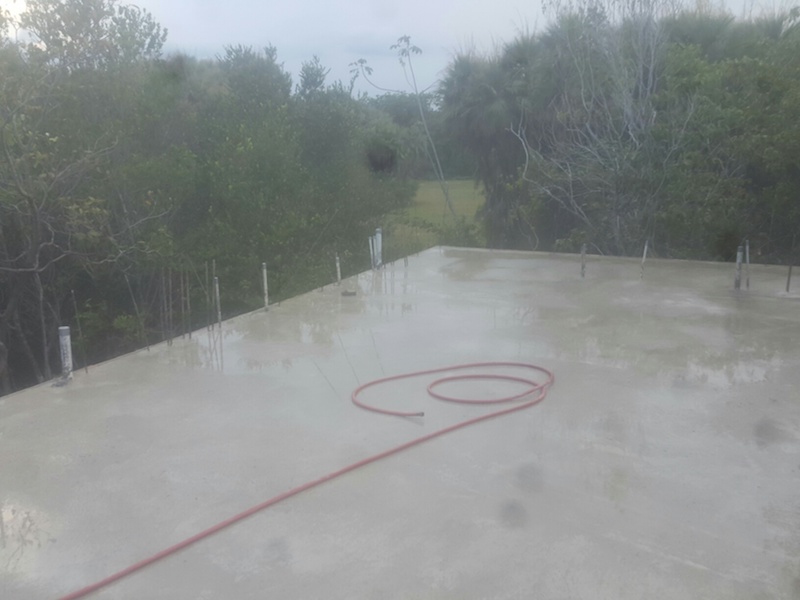

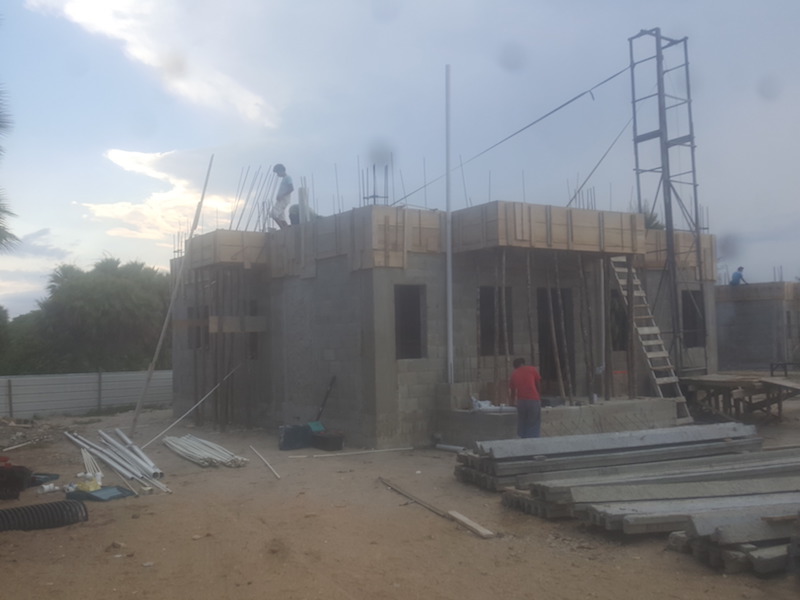

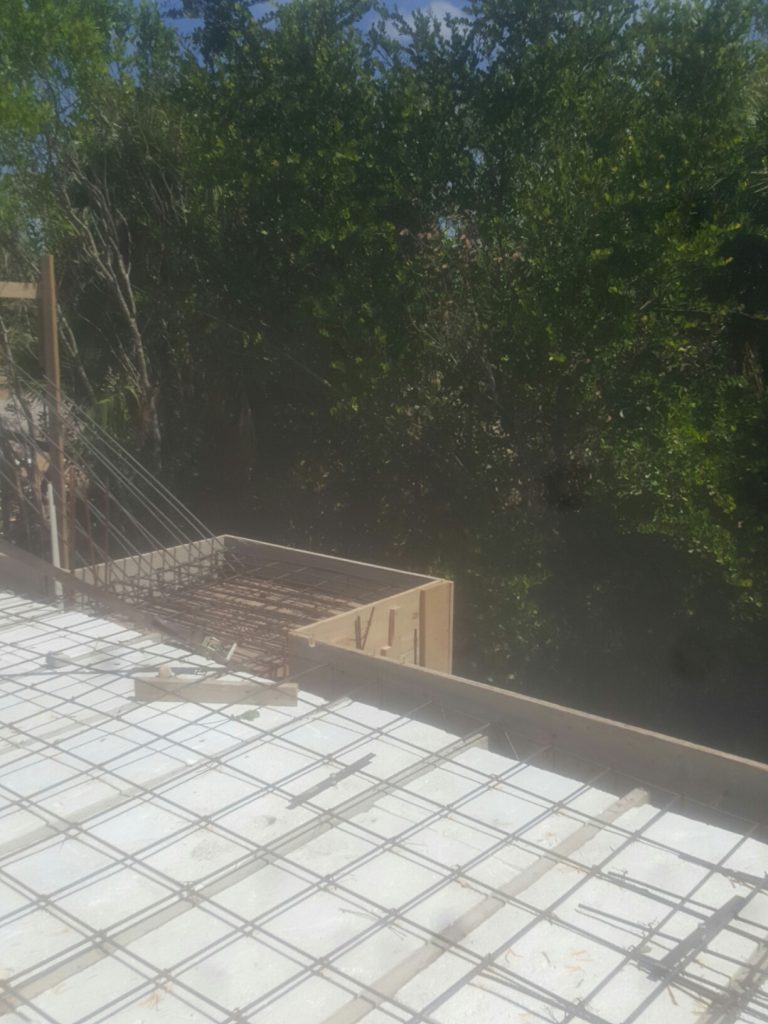

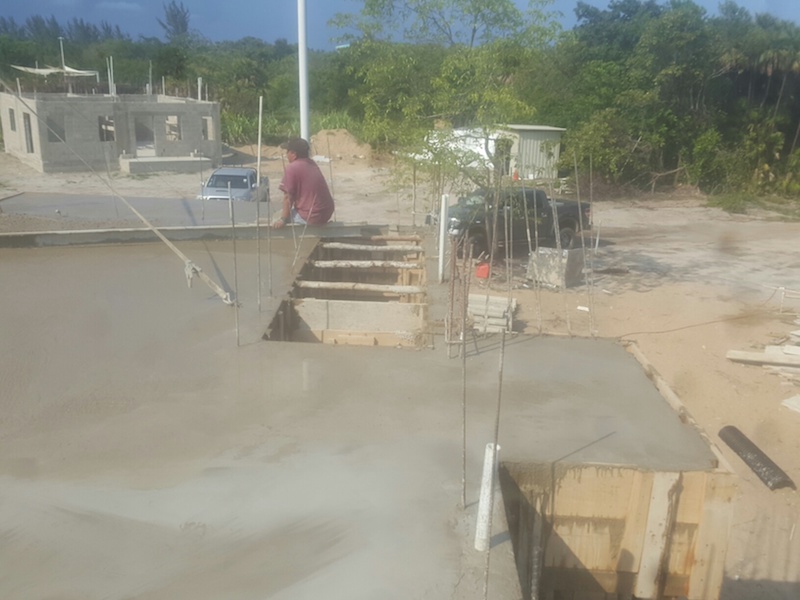

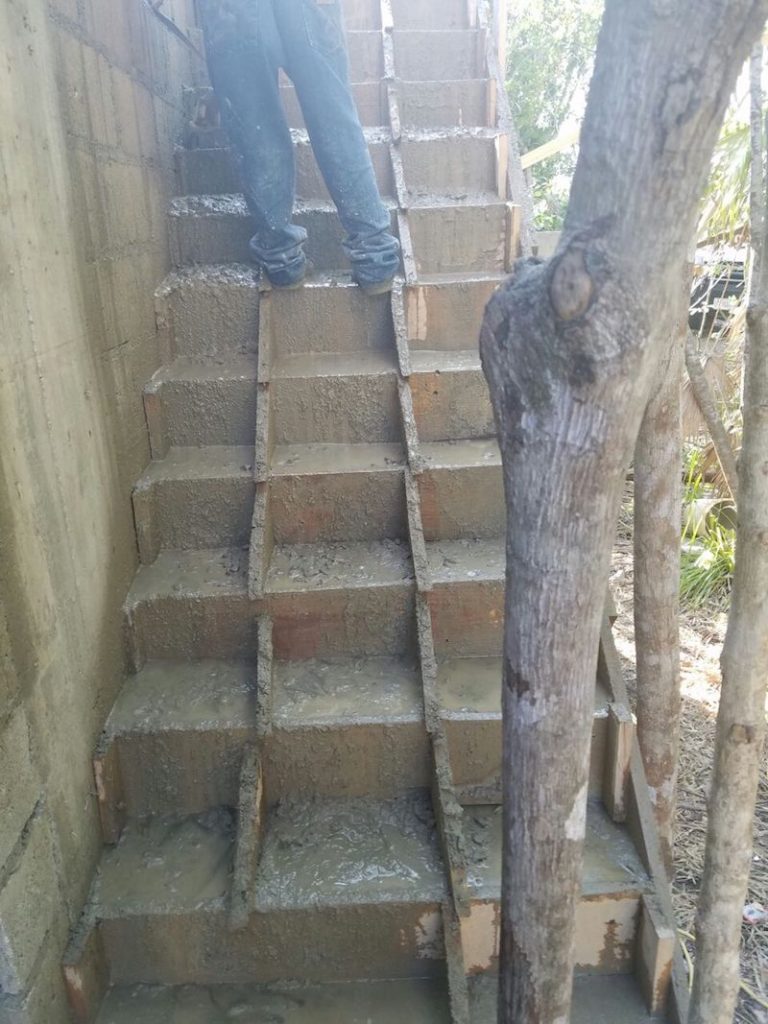

  49. 04/22/2017House 2 – Second Floor Slab Pour.

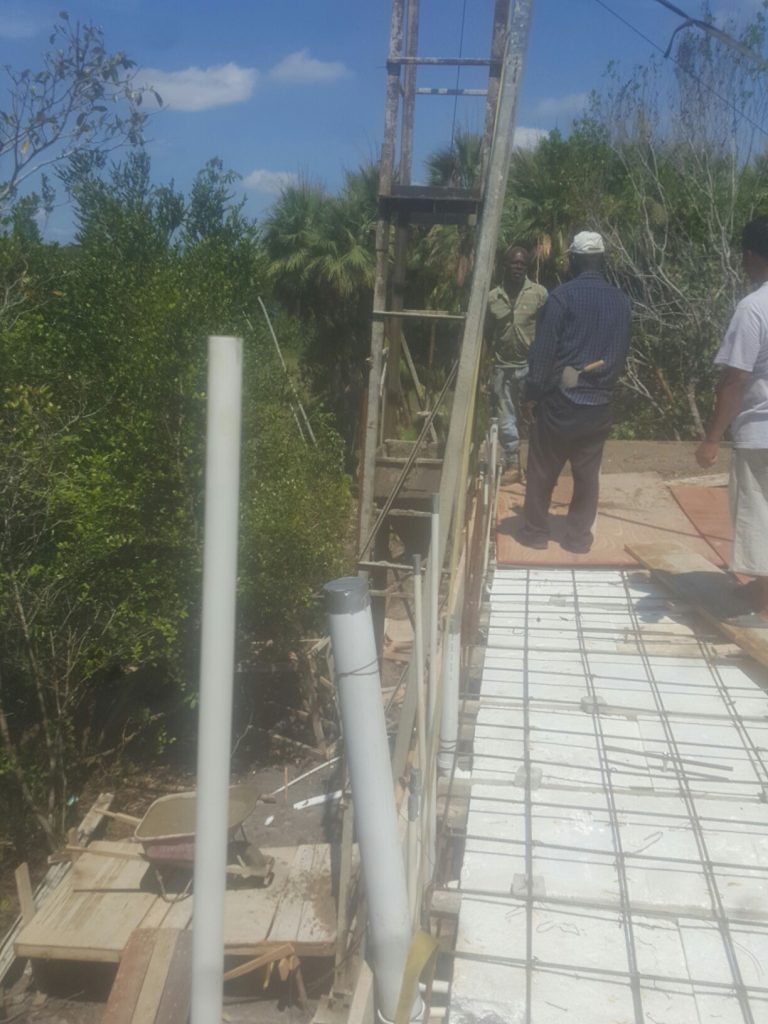

  50. 04/21/2017Slab & Stair Pour – Utility Garage & Apt.

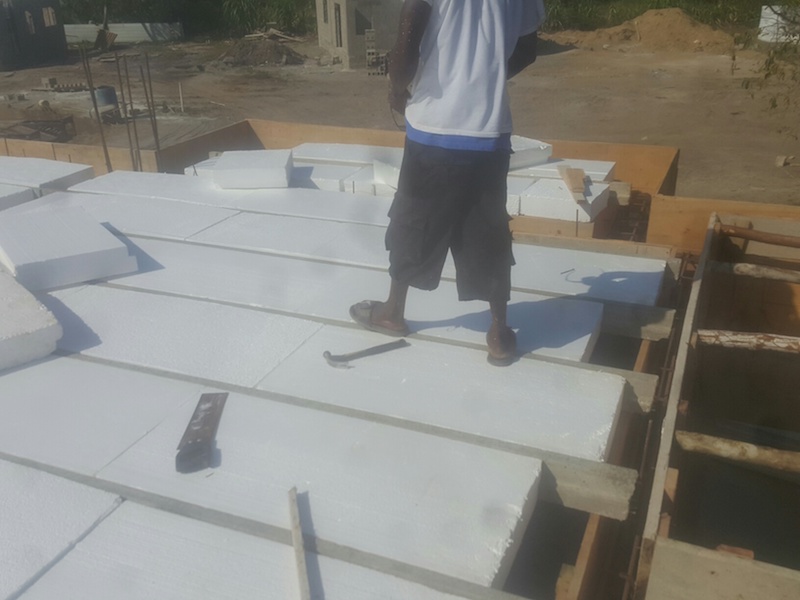

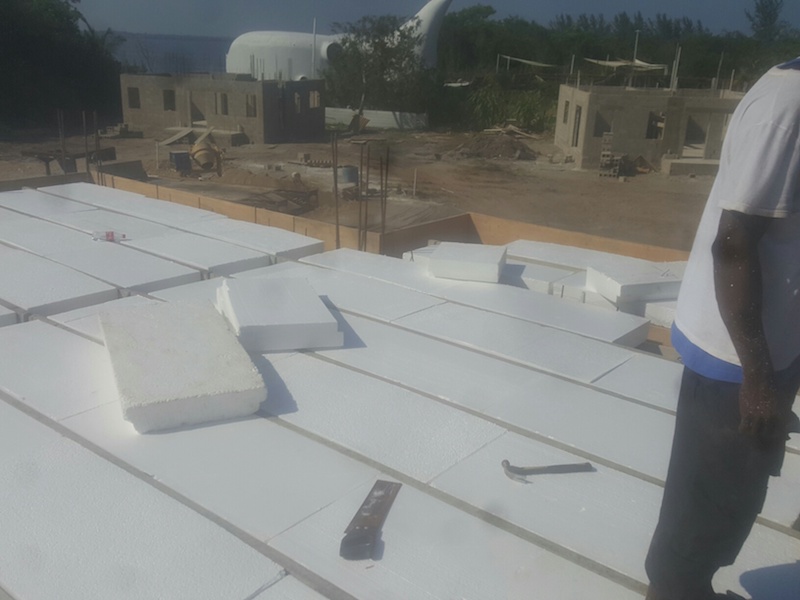

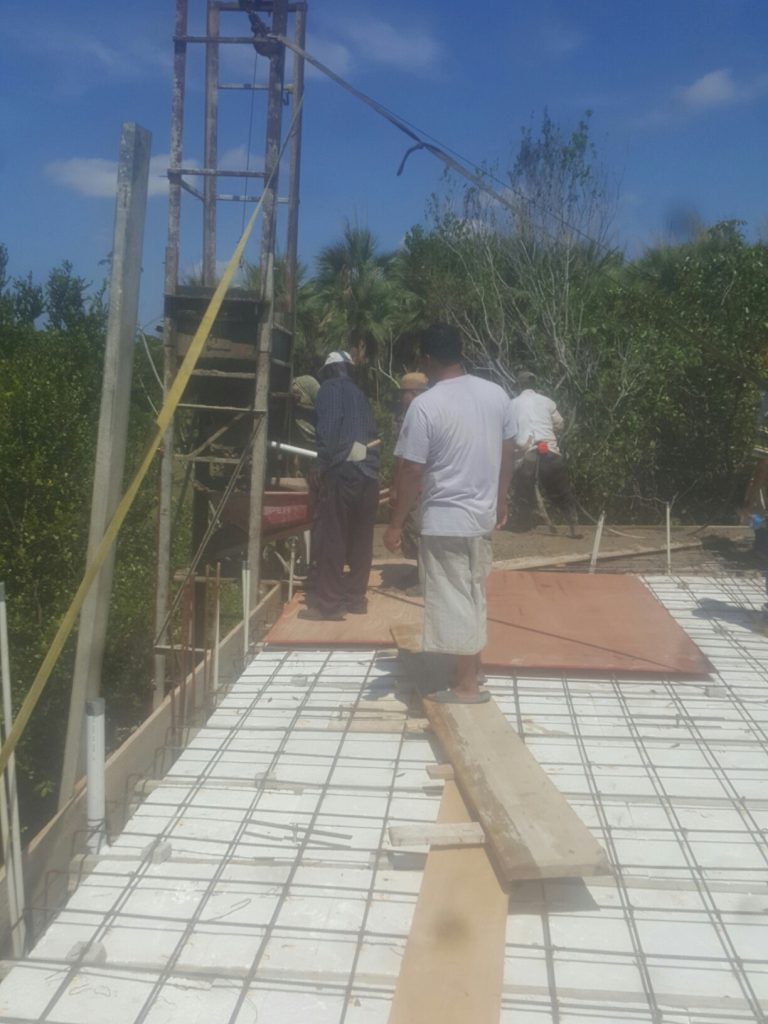

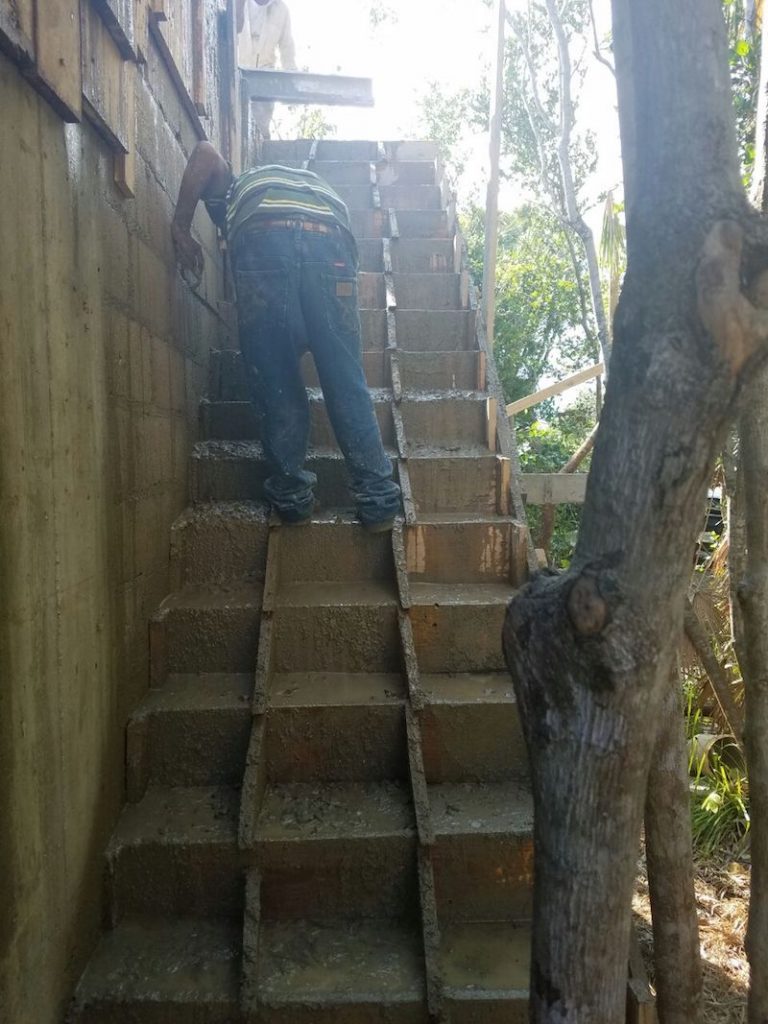

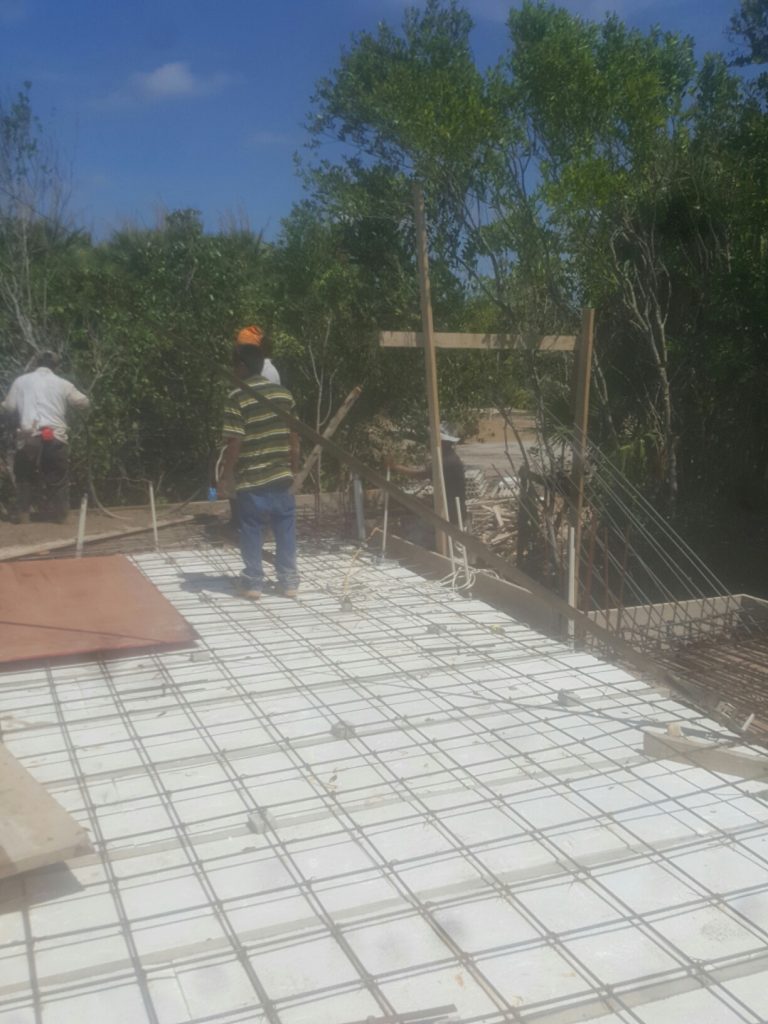

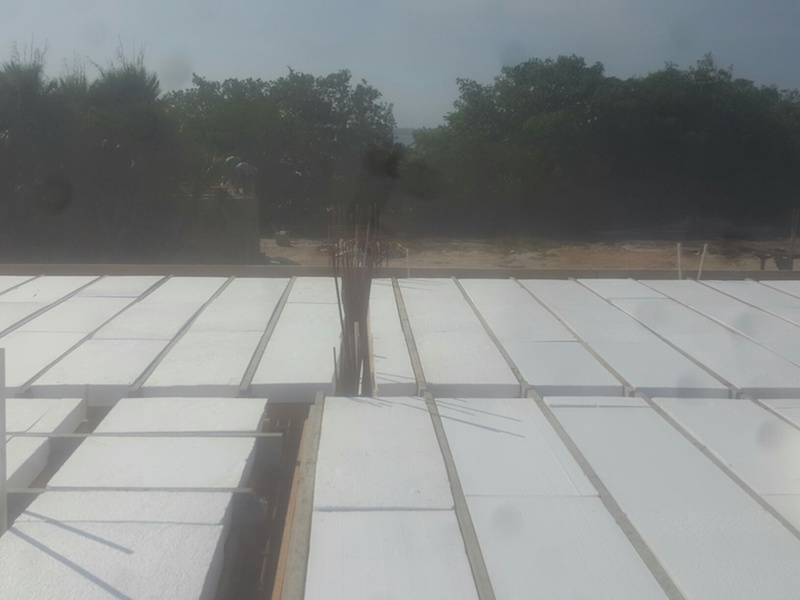

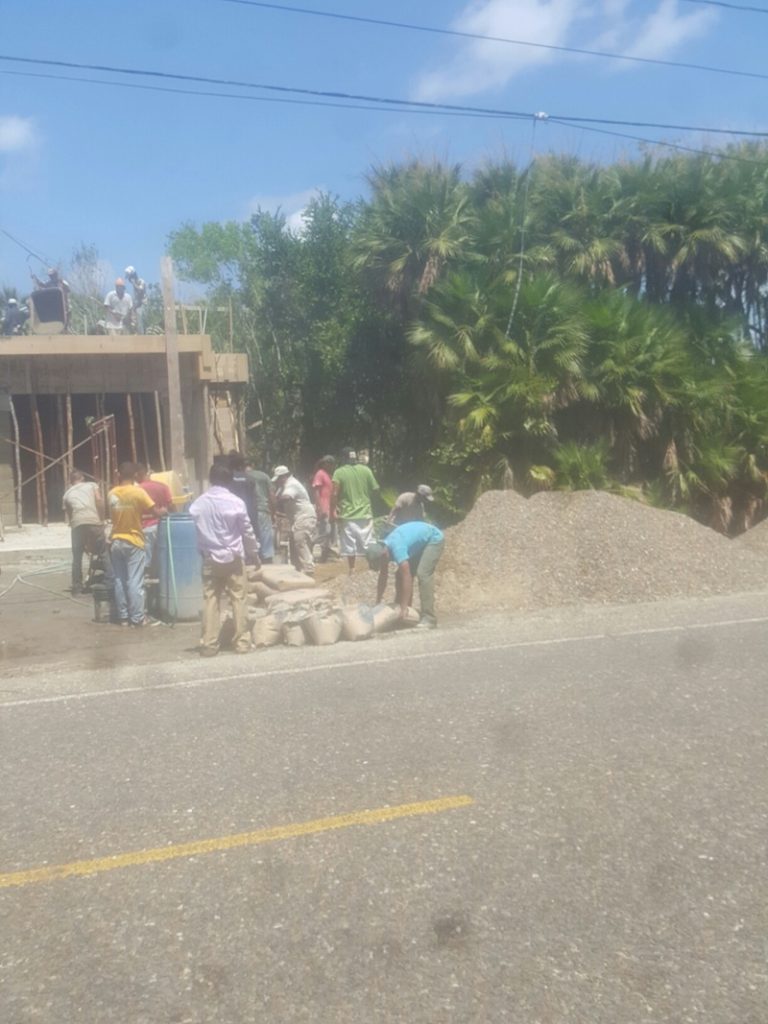

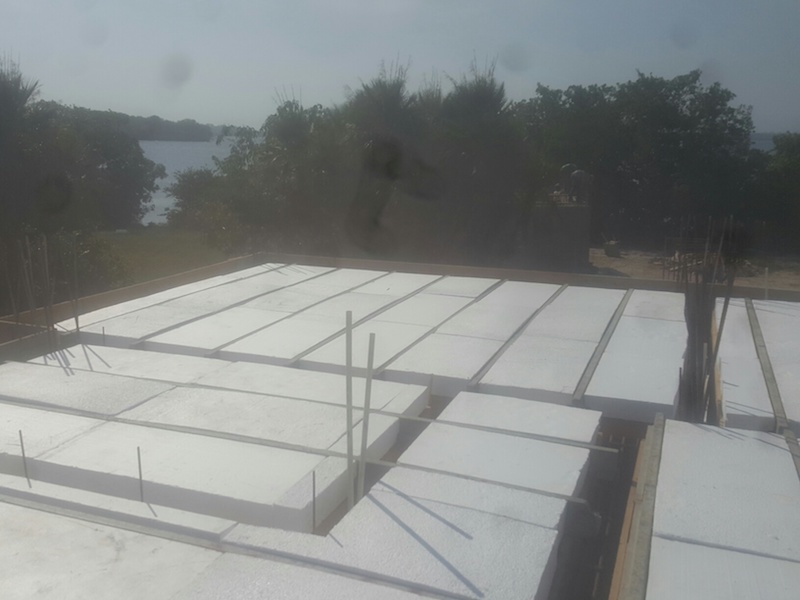

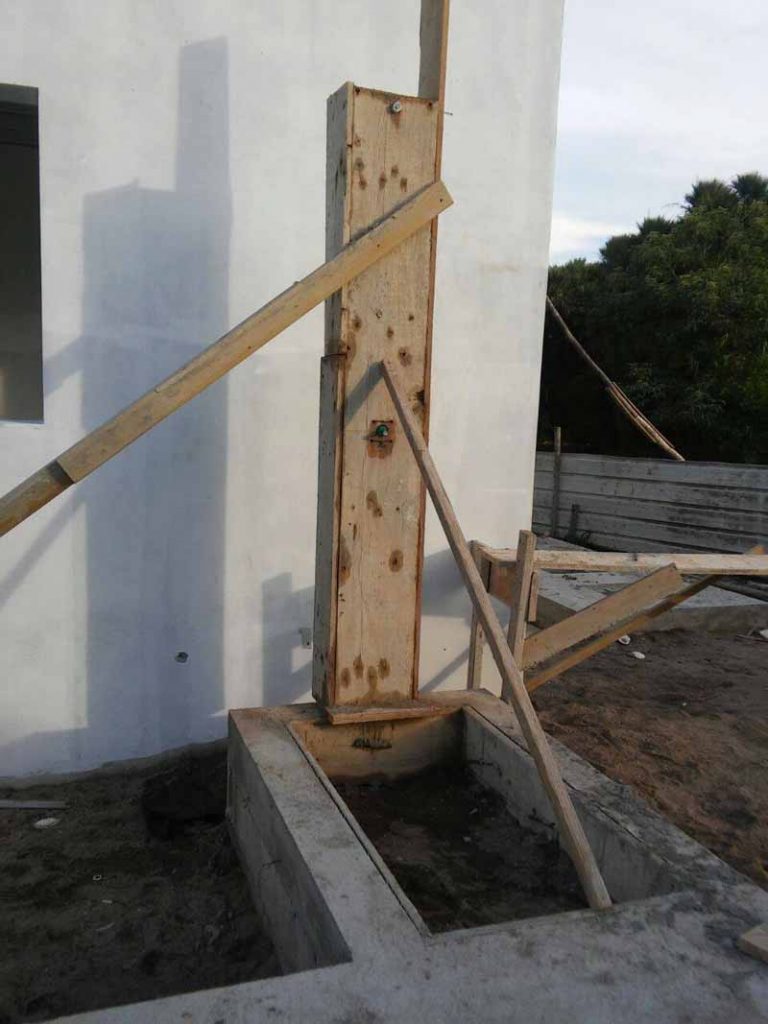

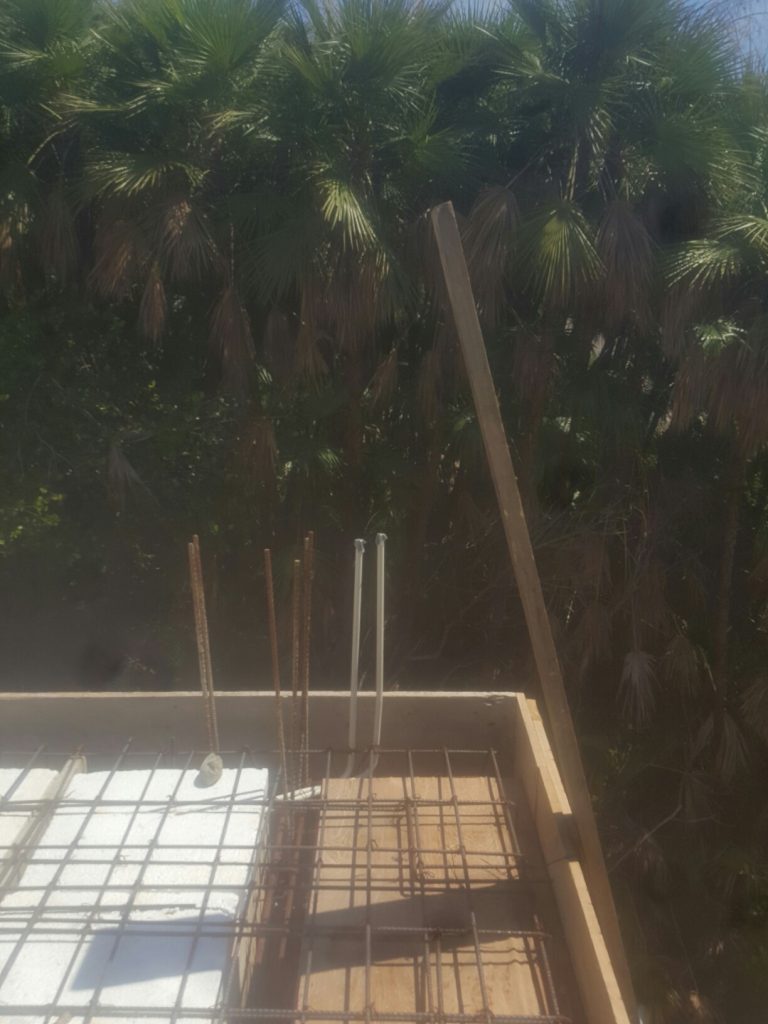

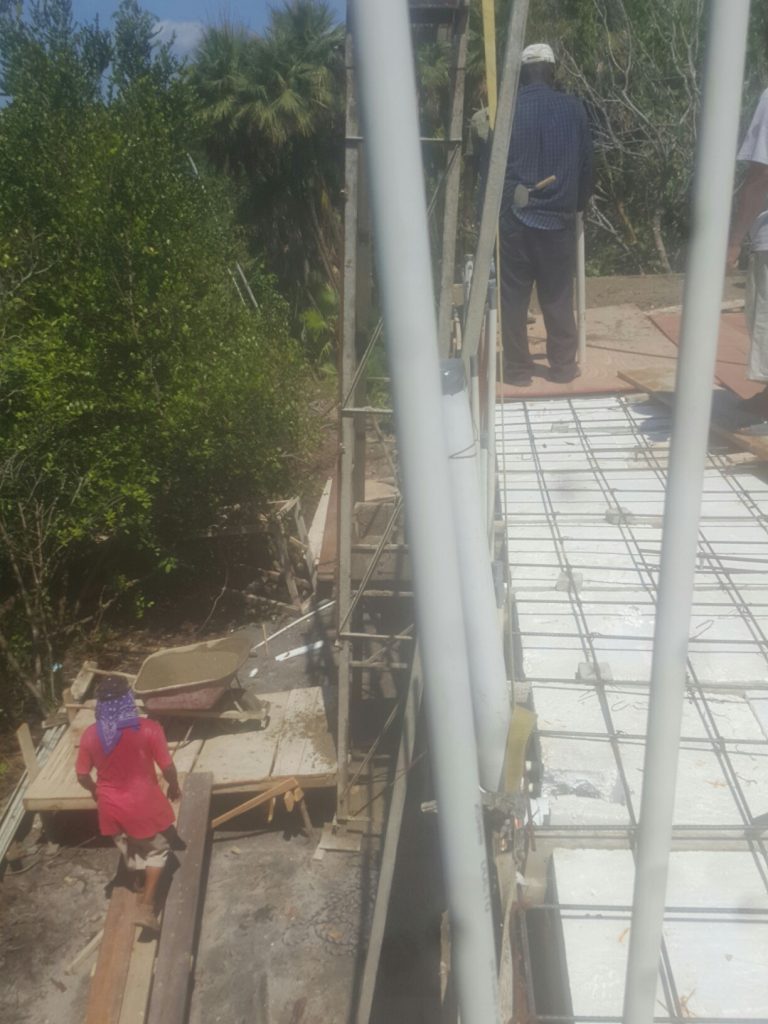

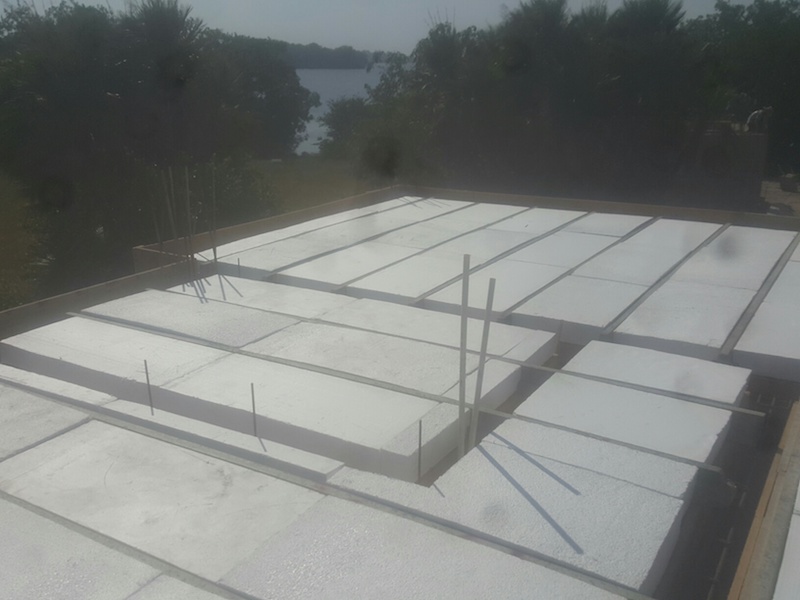

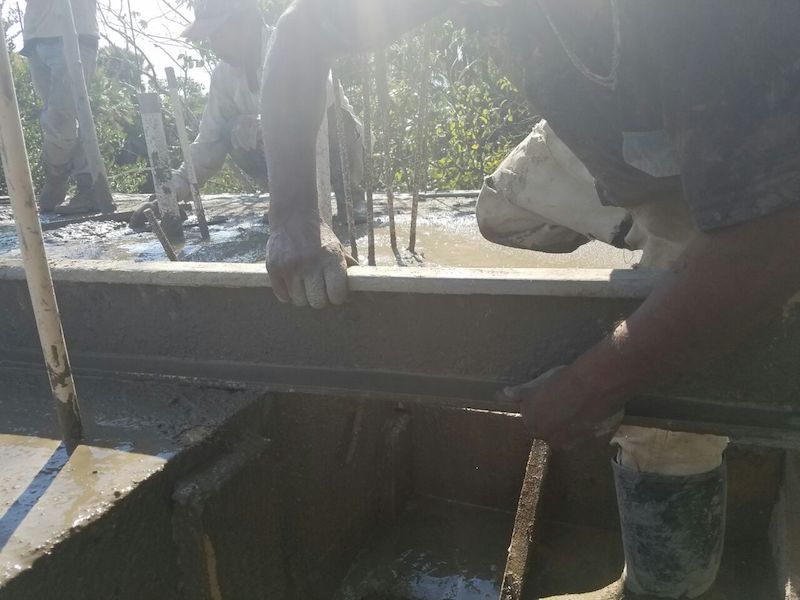

  51. 04/19/2017Slab & Stair Pour – Utility Garage & Apt.

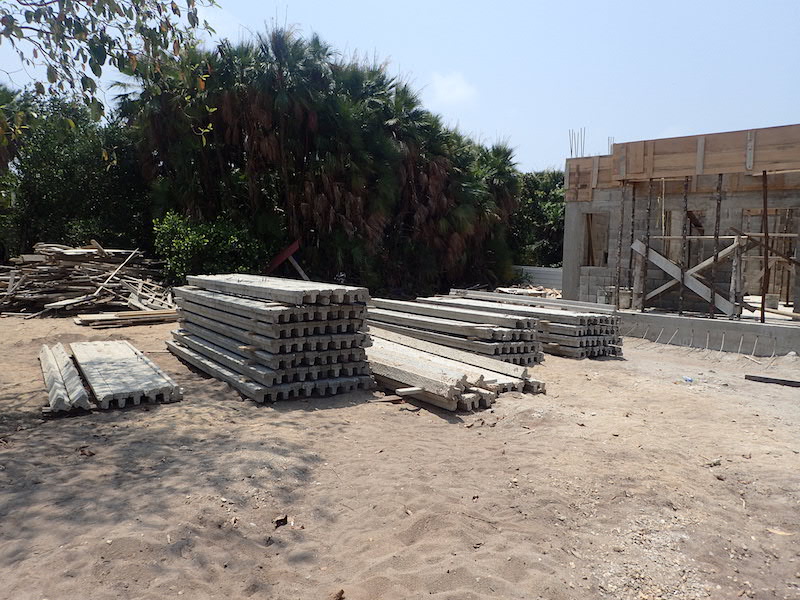

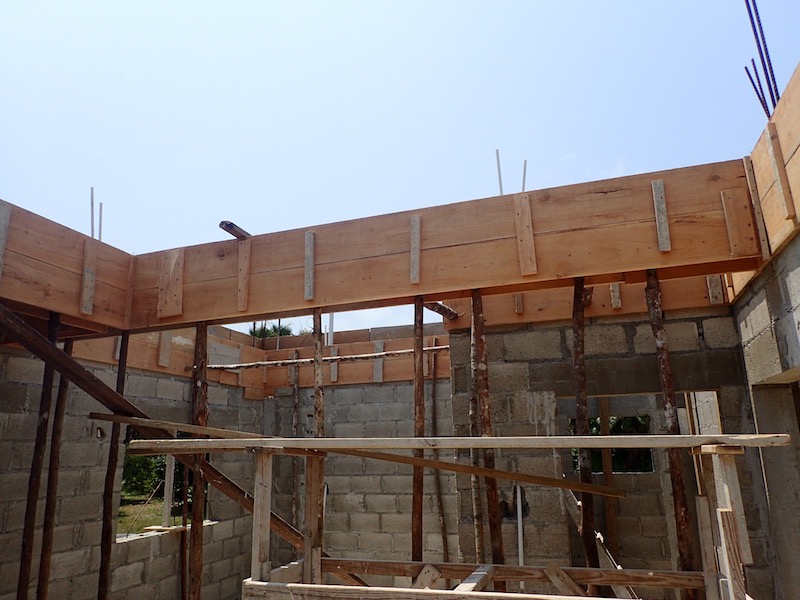

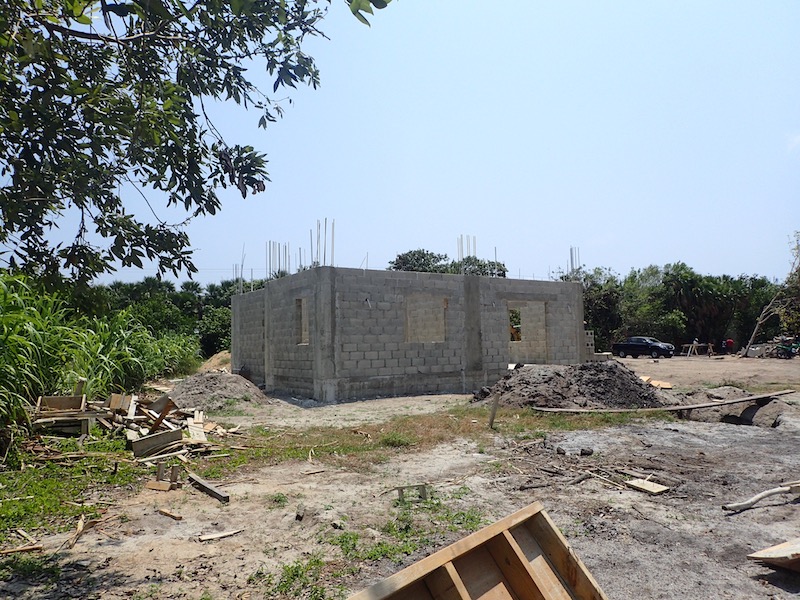

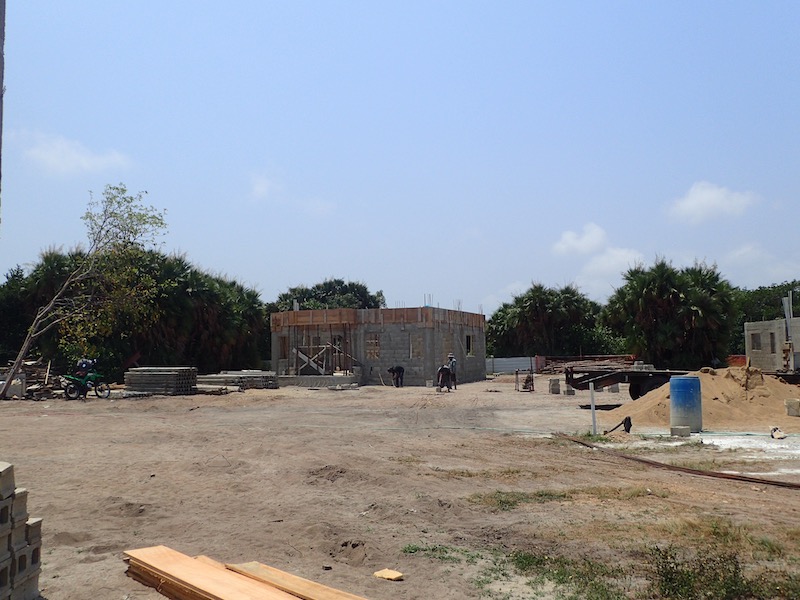

  52. 04/05/2017Beams & Insulation going in for 1st floor slab.

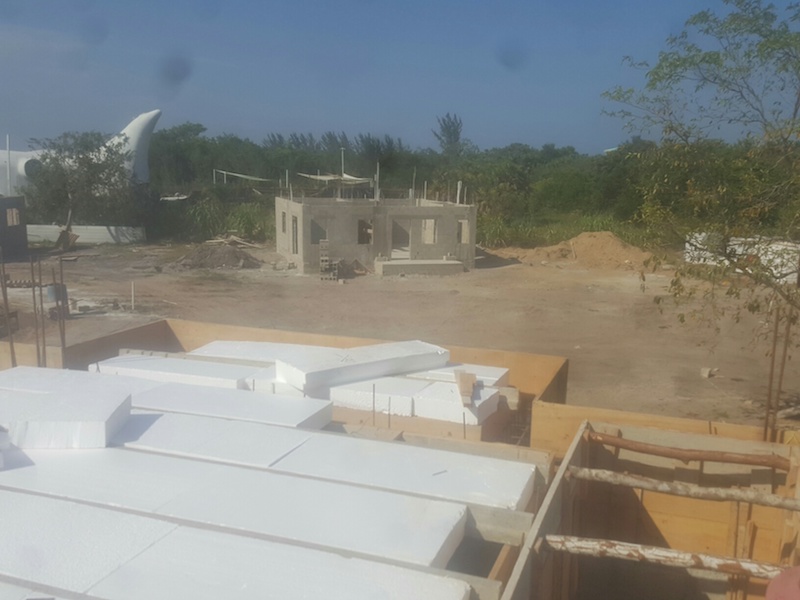

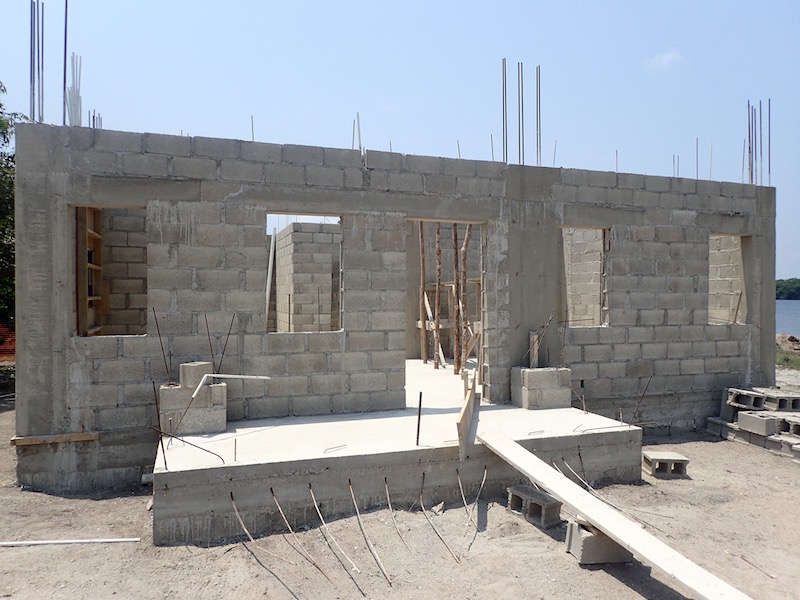

  53. 04/01/2017Coming along.

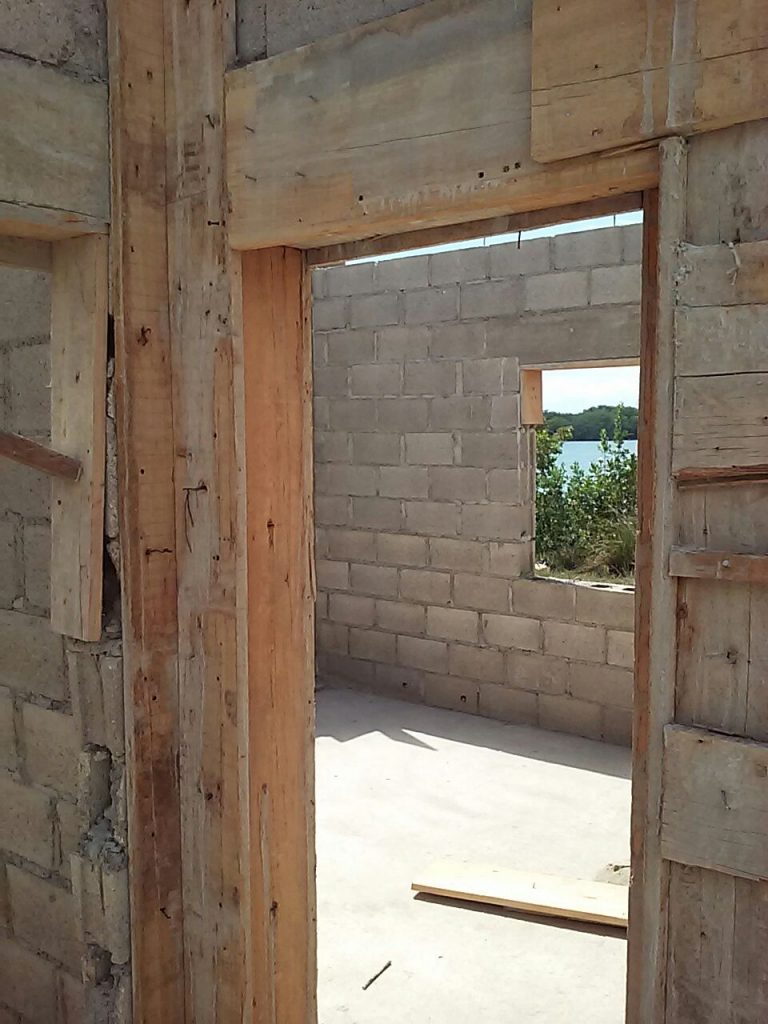

  54. 03/28/20171st floor beams & styrofoam insulation arrive.

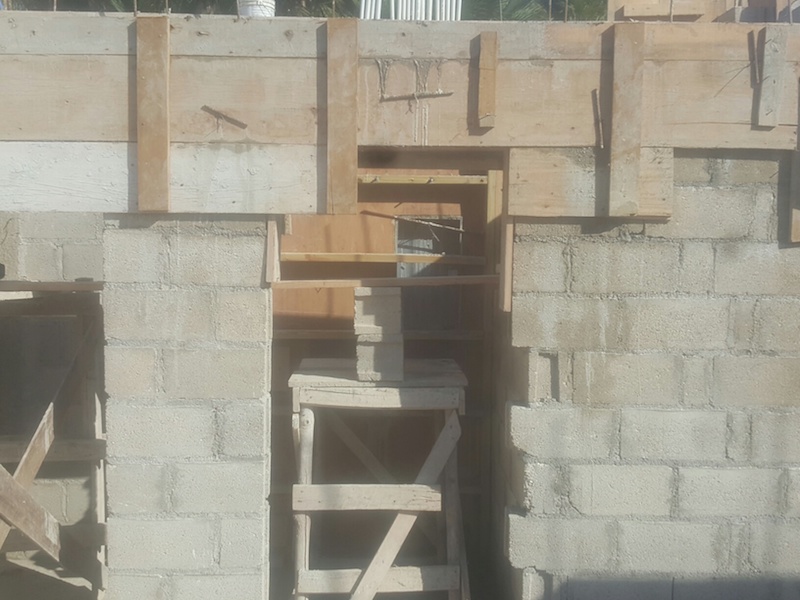

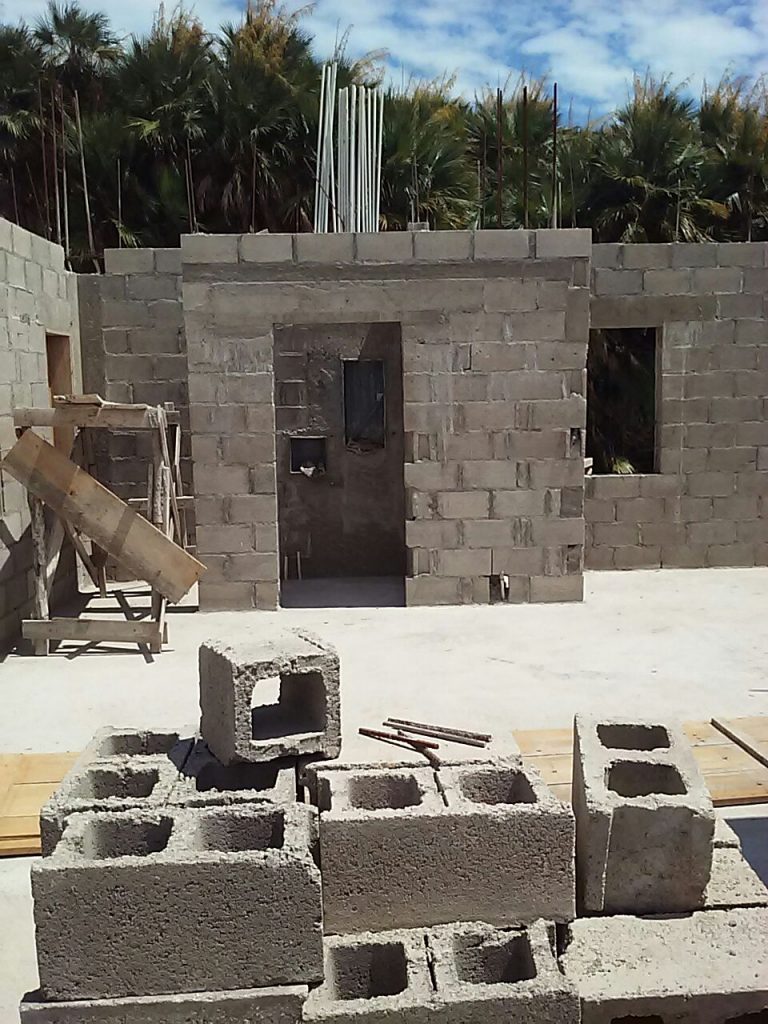

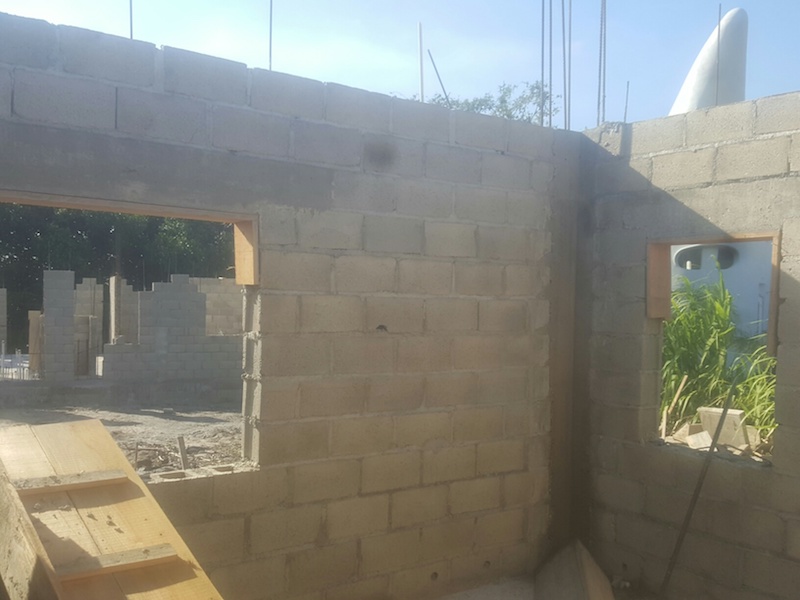

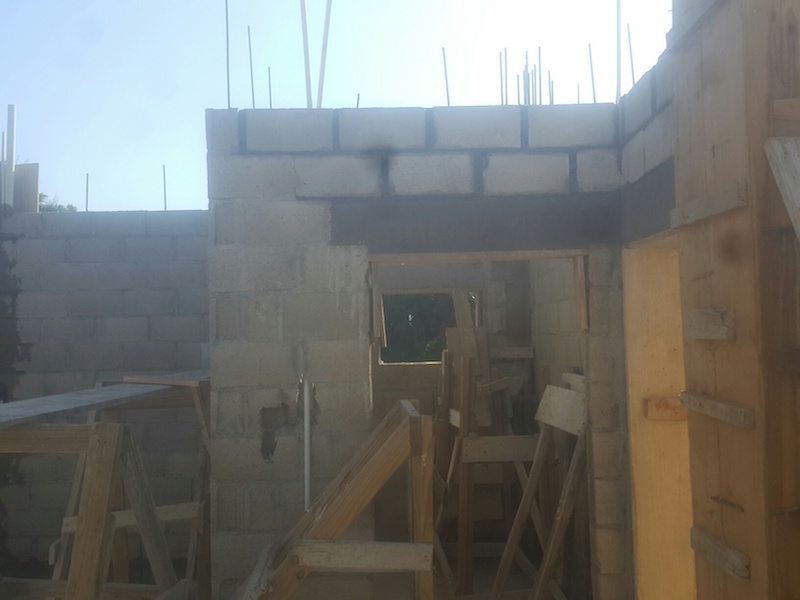

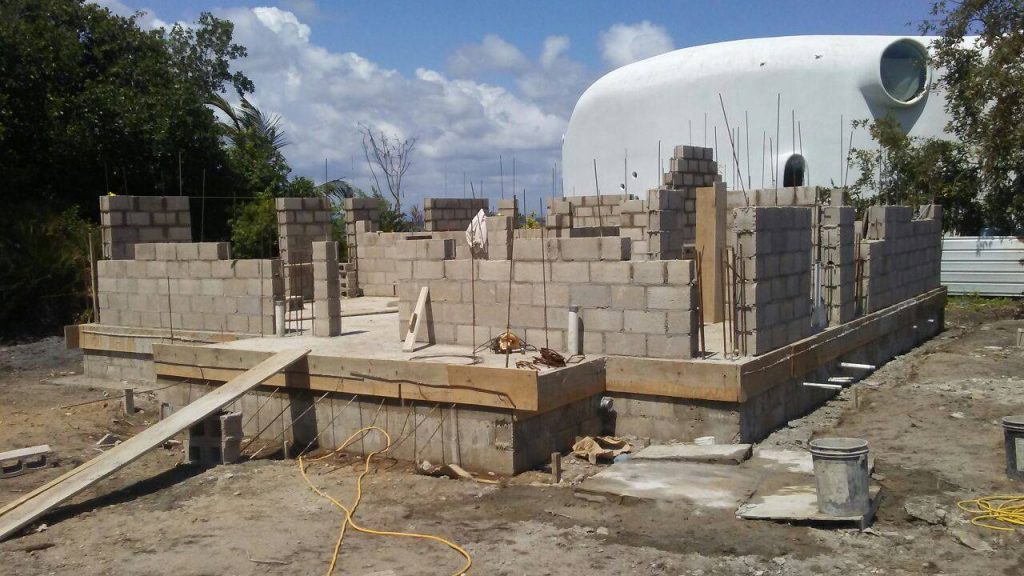

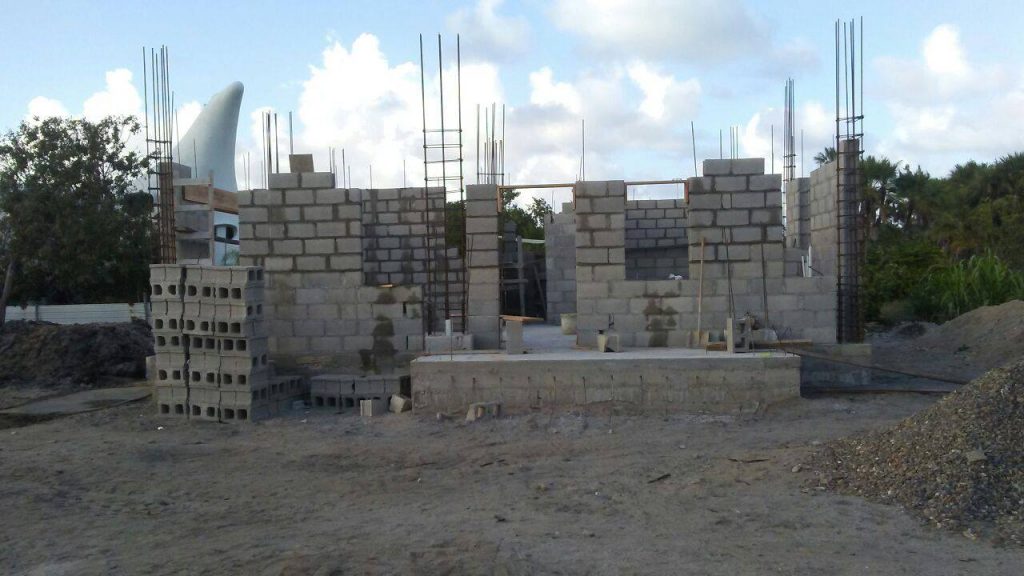

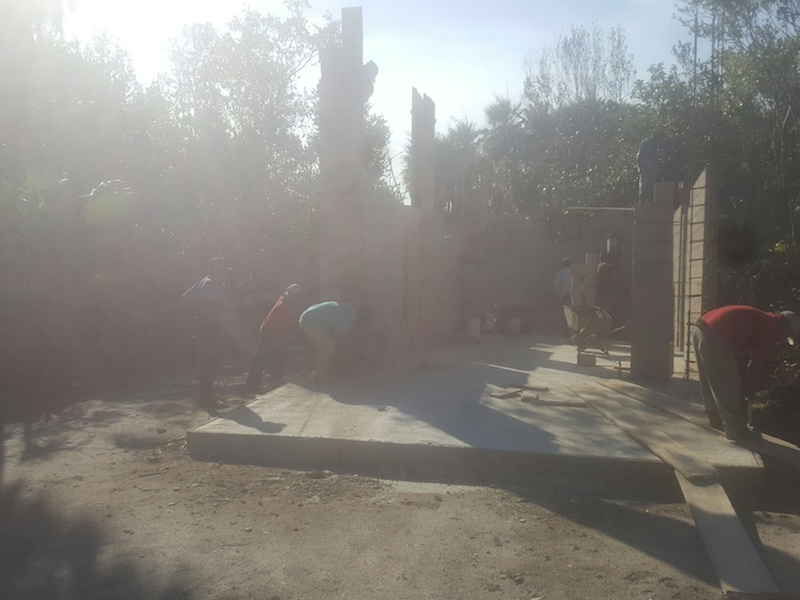

  55. 03/24/2017Still at it.

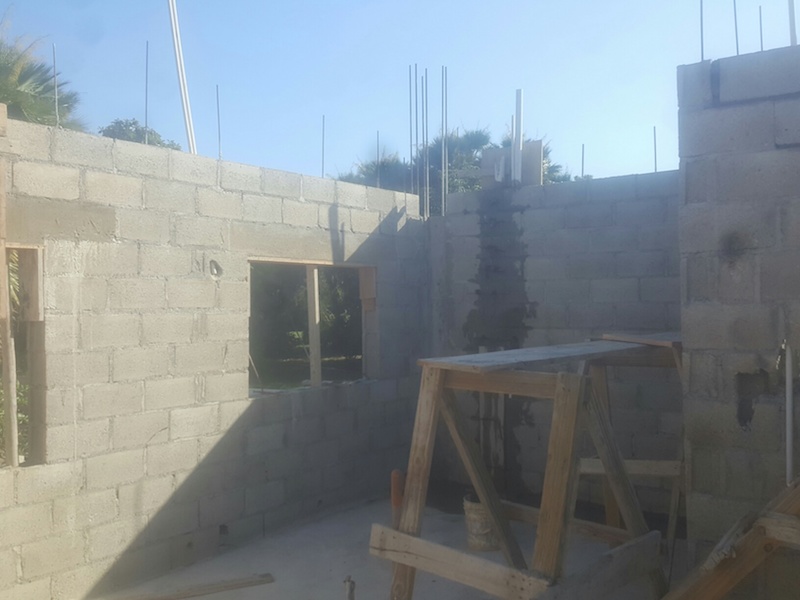

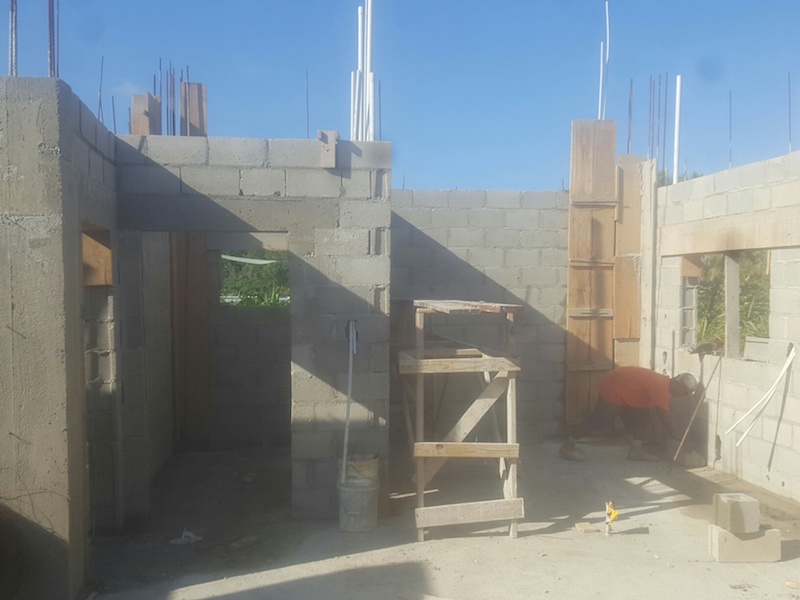

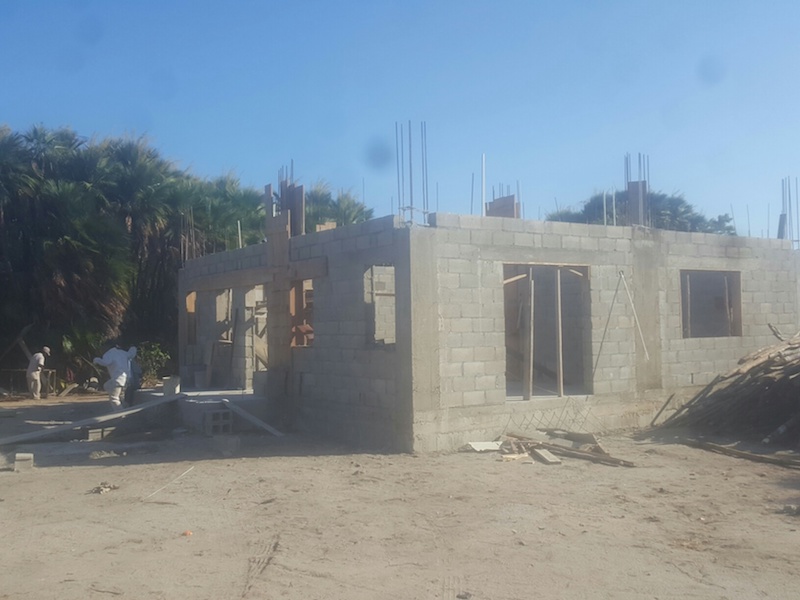

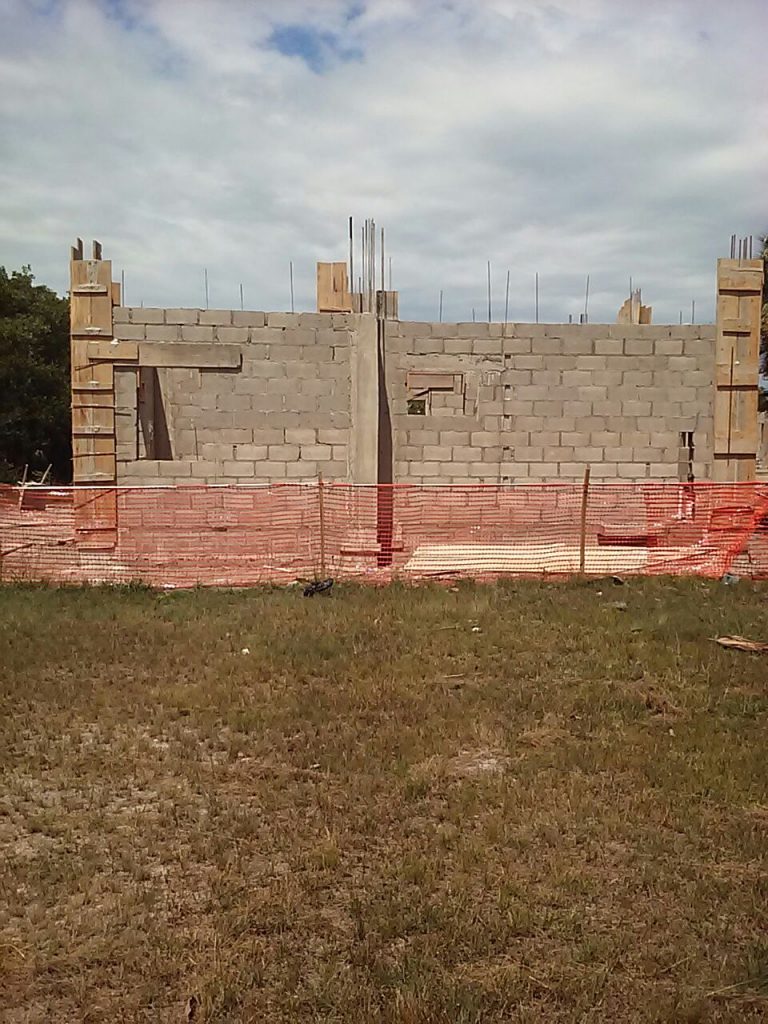

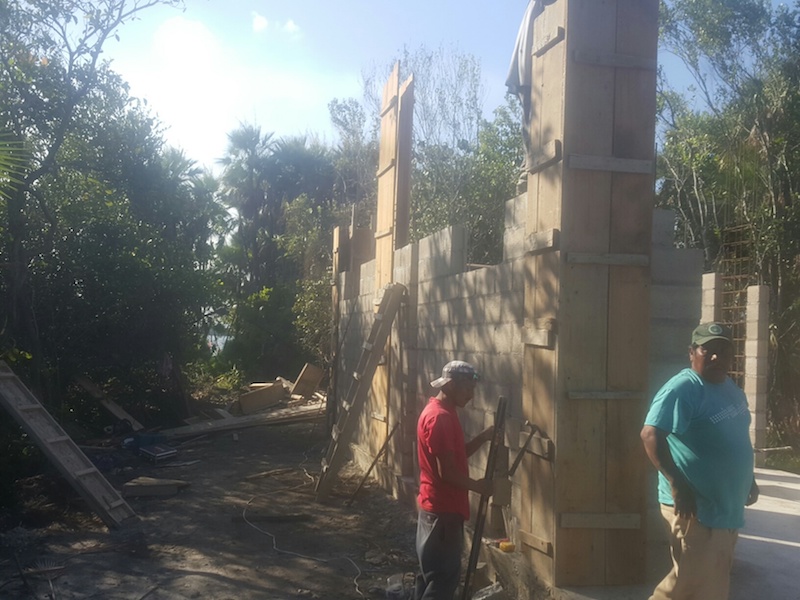

  56. 03/17/2017Nearly ready for 1st floor ceiling beams.
  57. 03/14/2017First floor walls getting close to completion.
  58. 03/10/2017Framing to pour columns.

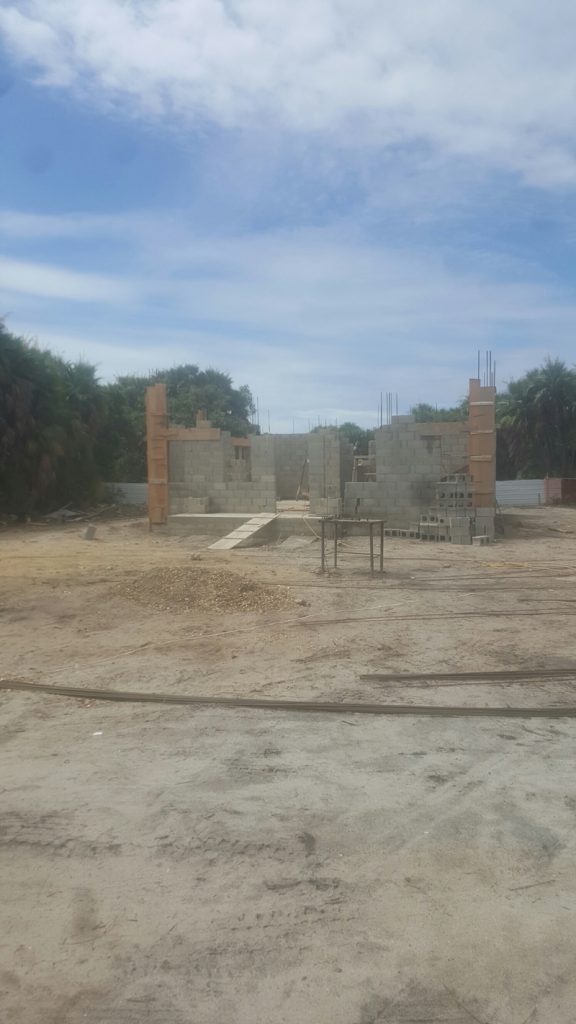

  59. 03/08/2017Continuing upward – 1st floor walls.

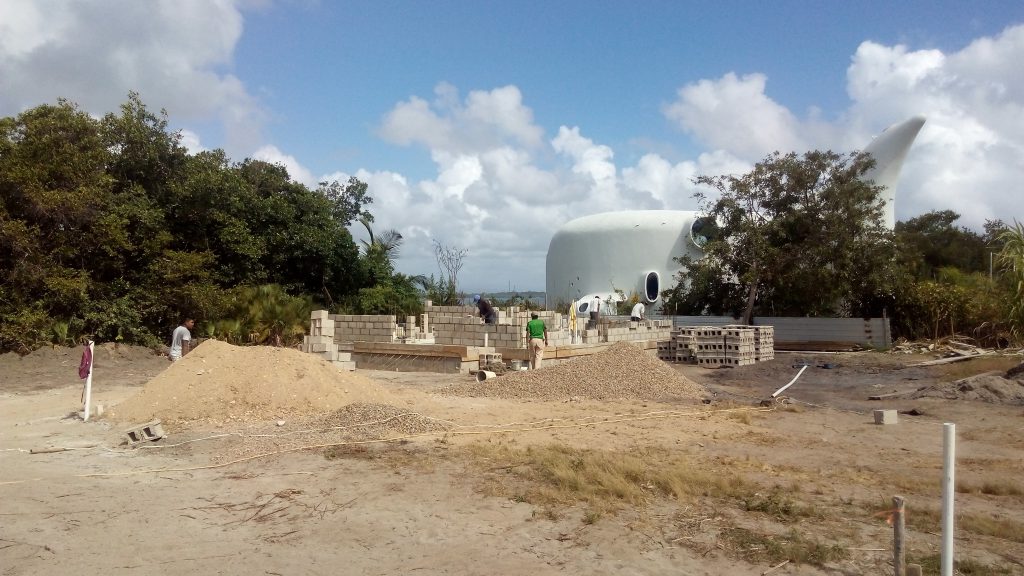

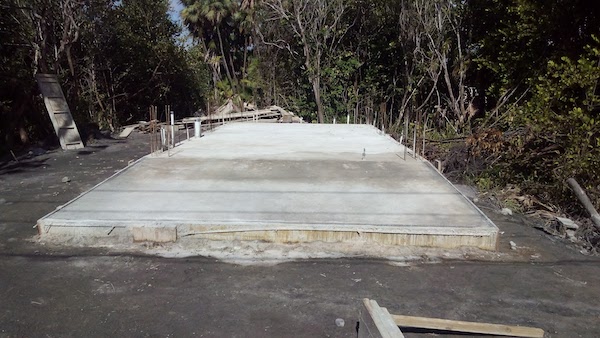

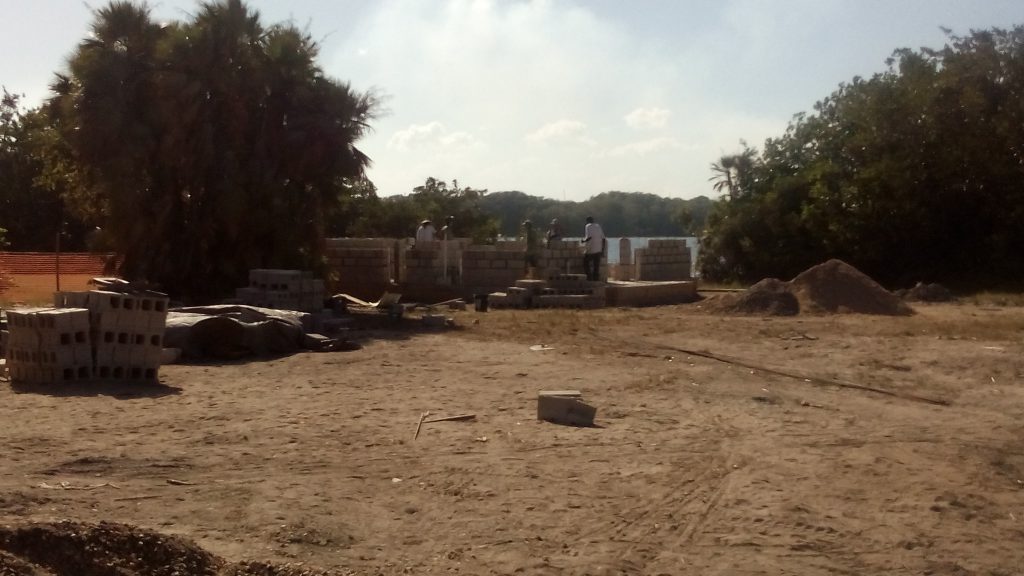

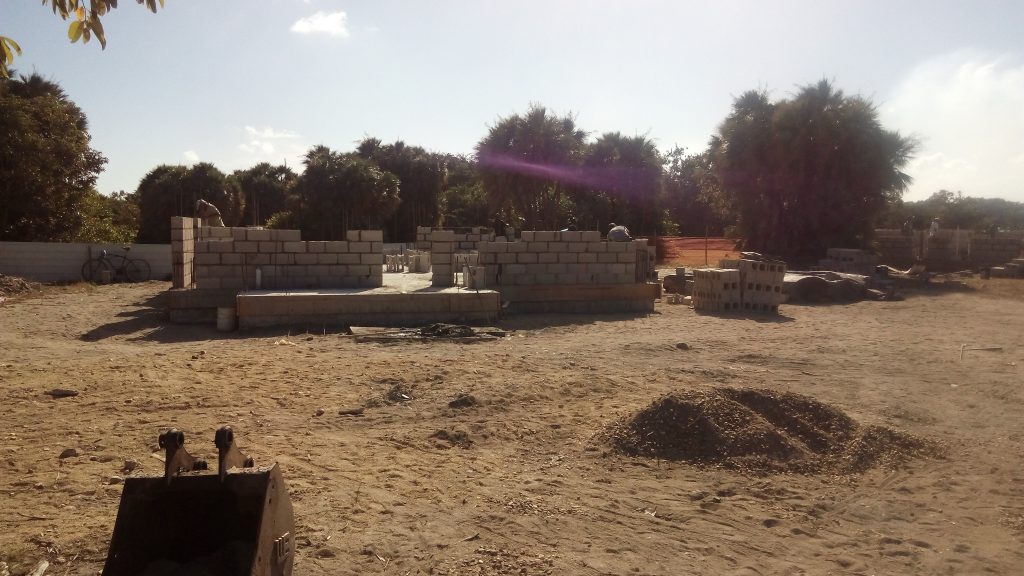

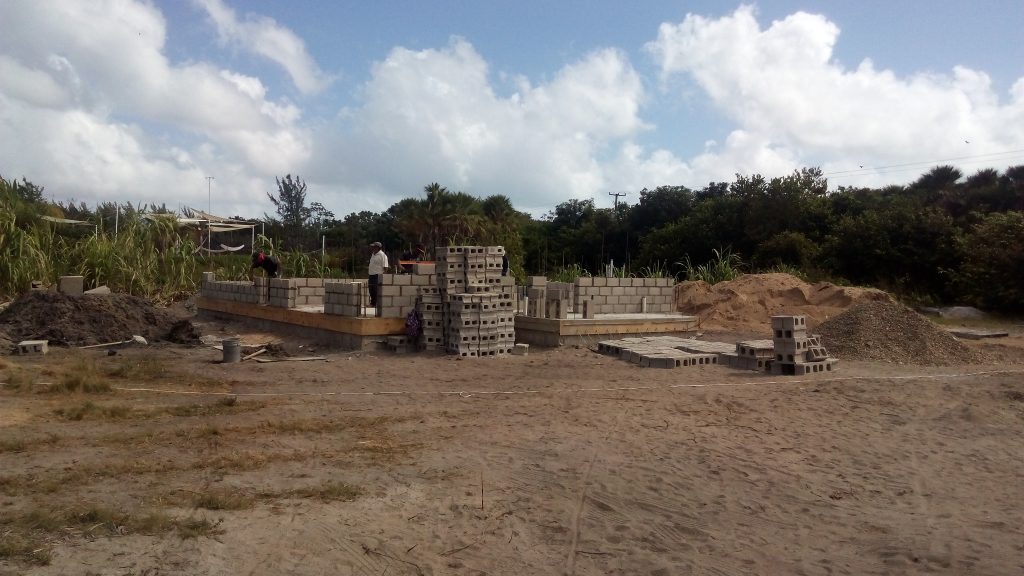

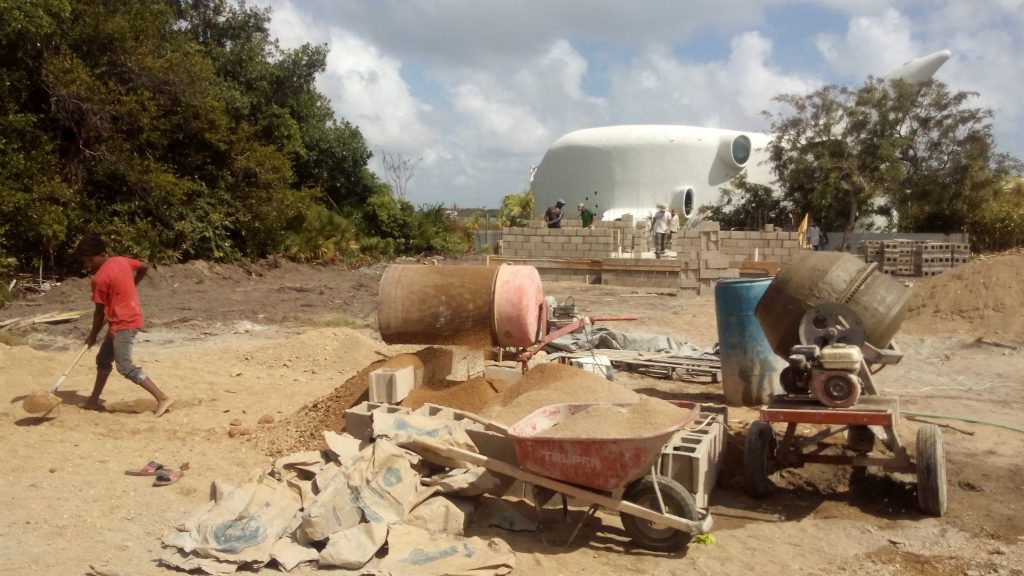

  60. 03/04/2017First floor walls continue upward.

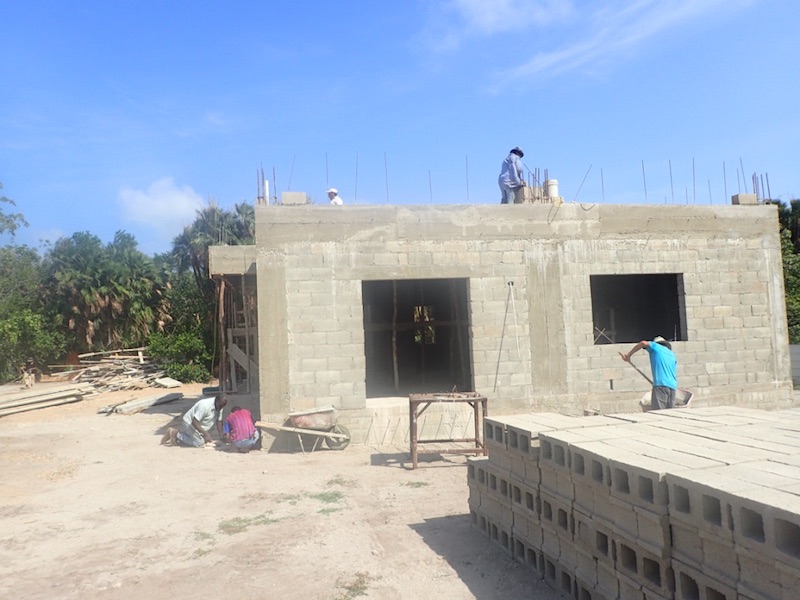

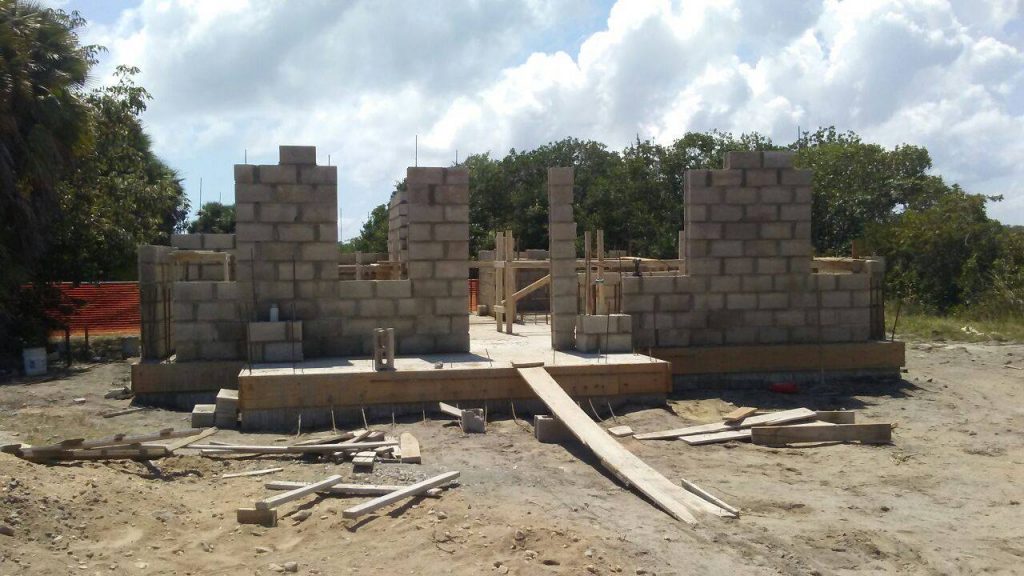

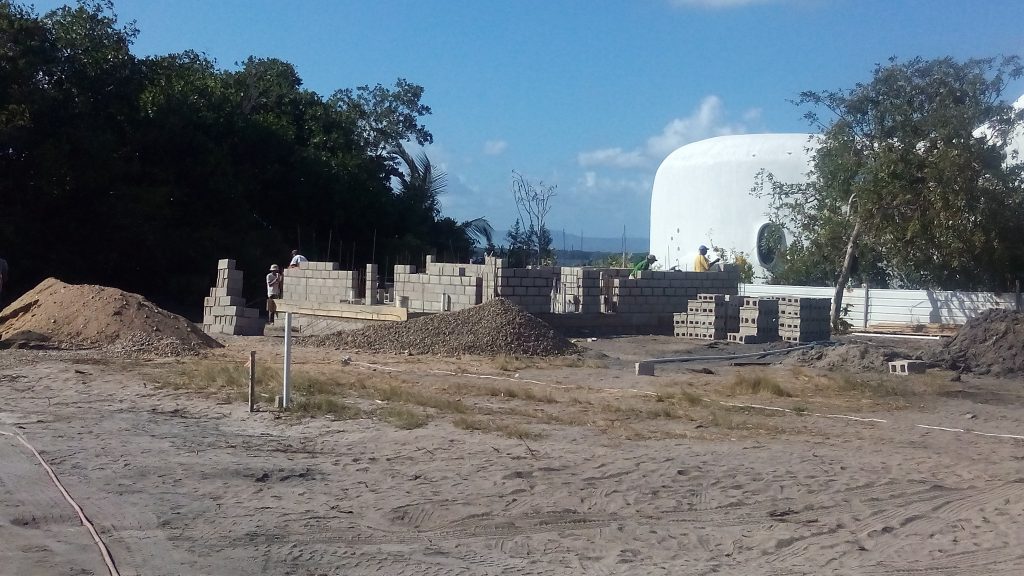

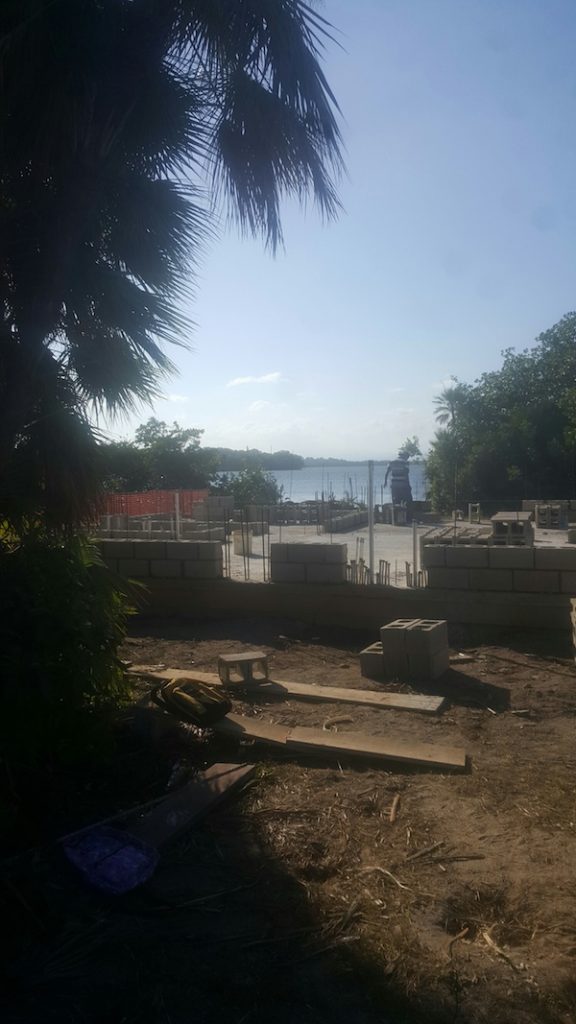

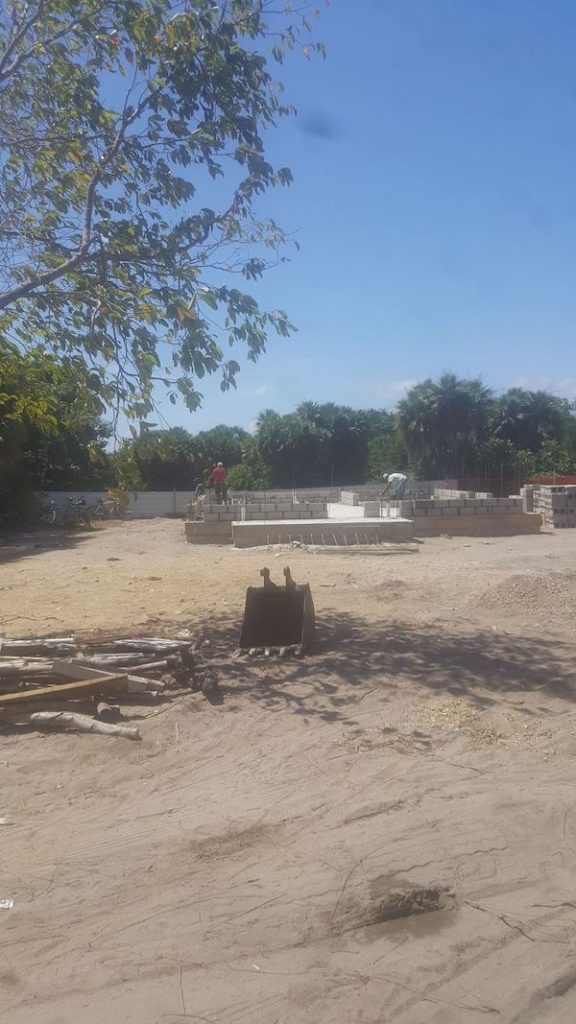

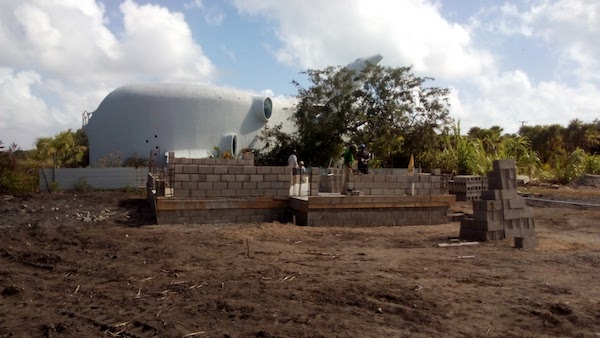

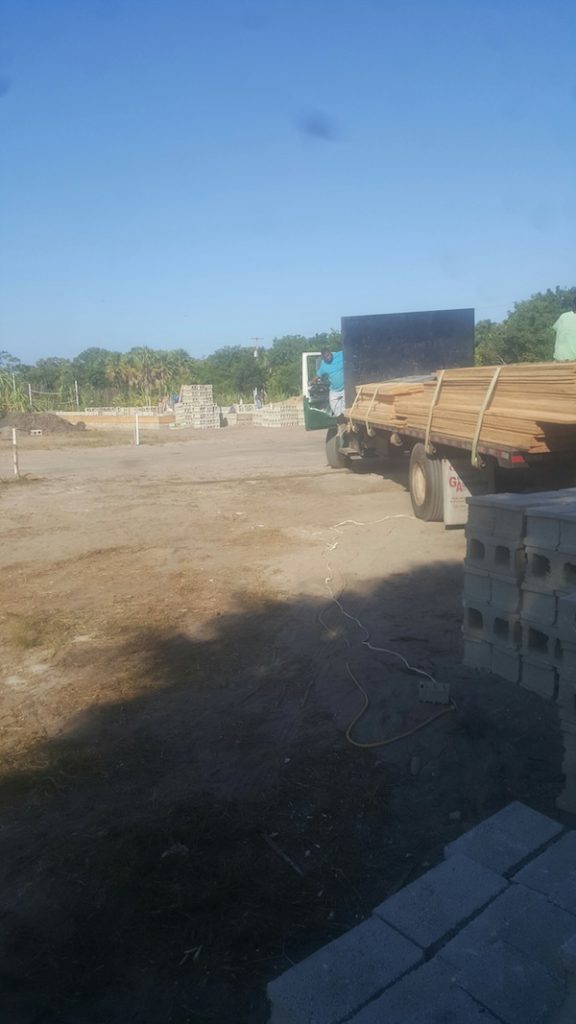

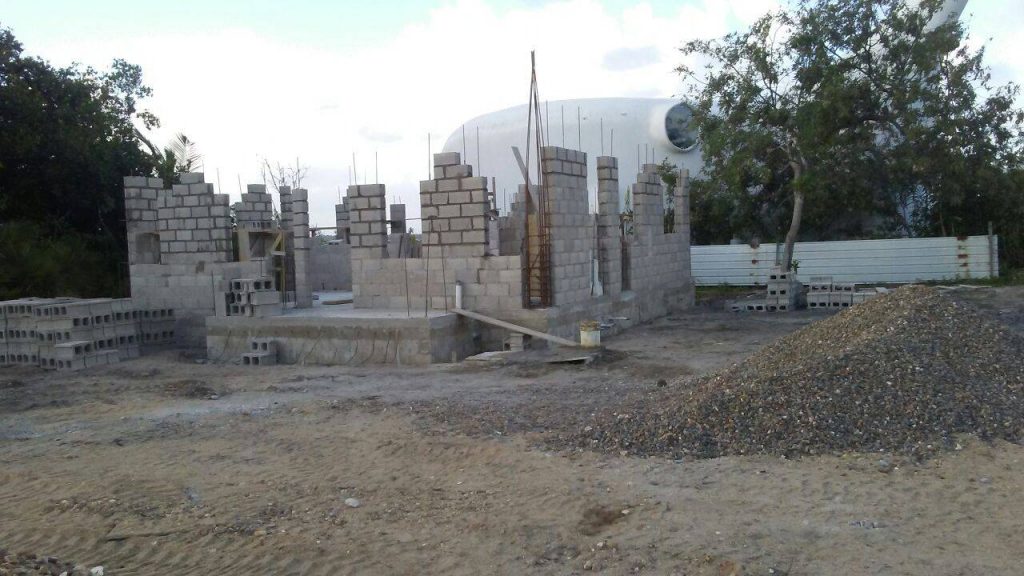

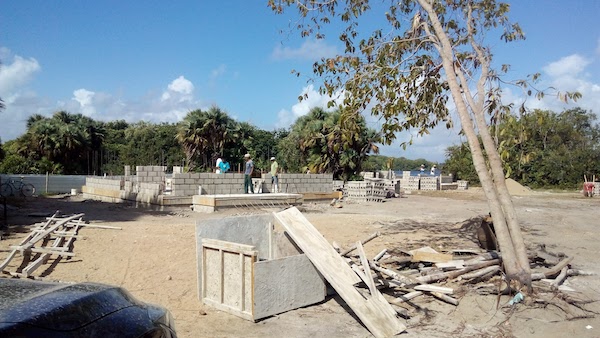

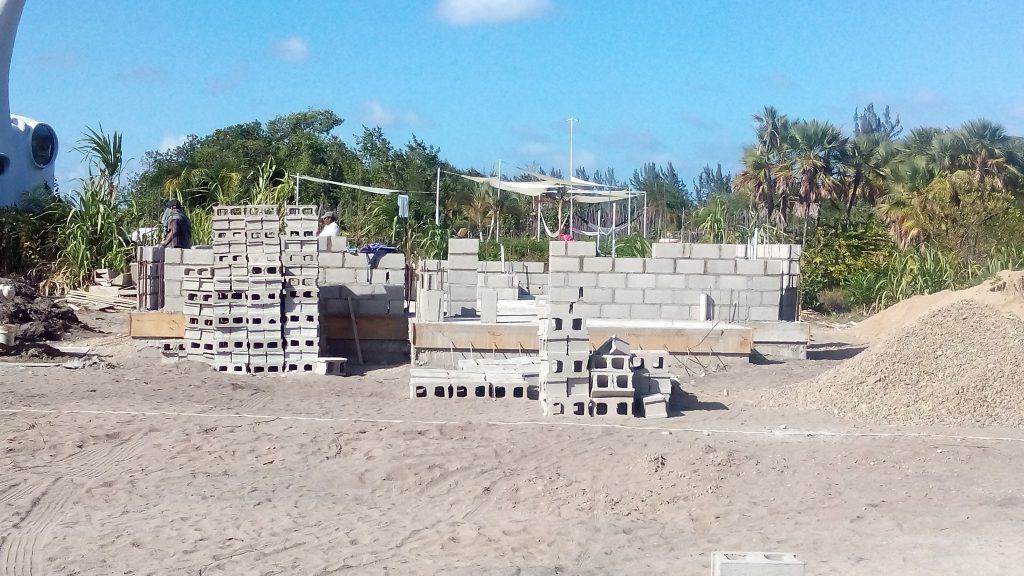

  61. 03/02/2017First floor walls going up.

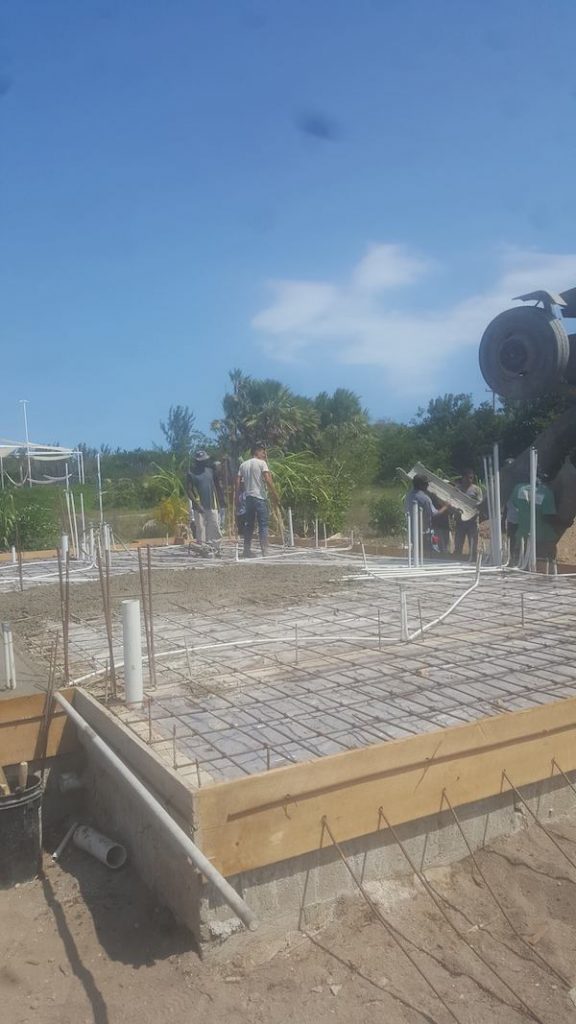

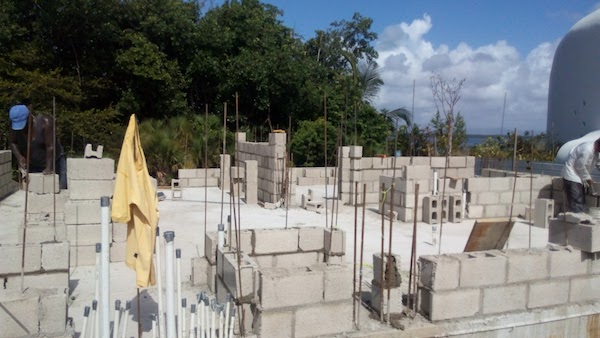

  62. 02/28/2017Final slab work & start of walls.
  63. 02/27/2017Paperwork filed with Lands Department, Belmopan.

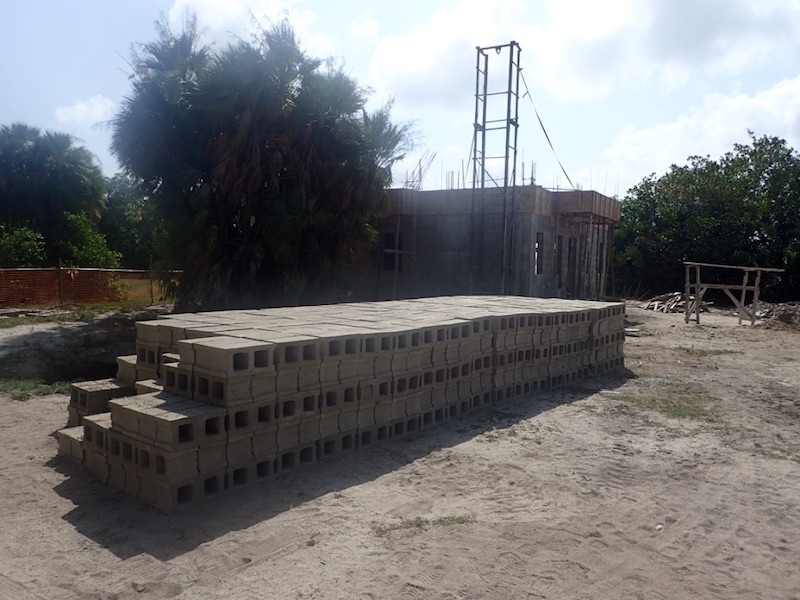

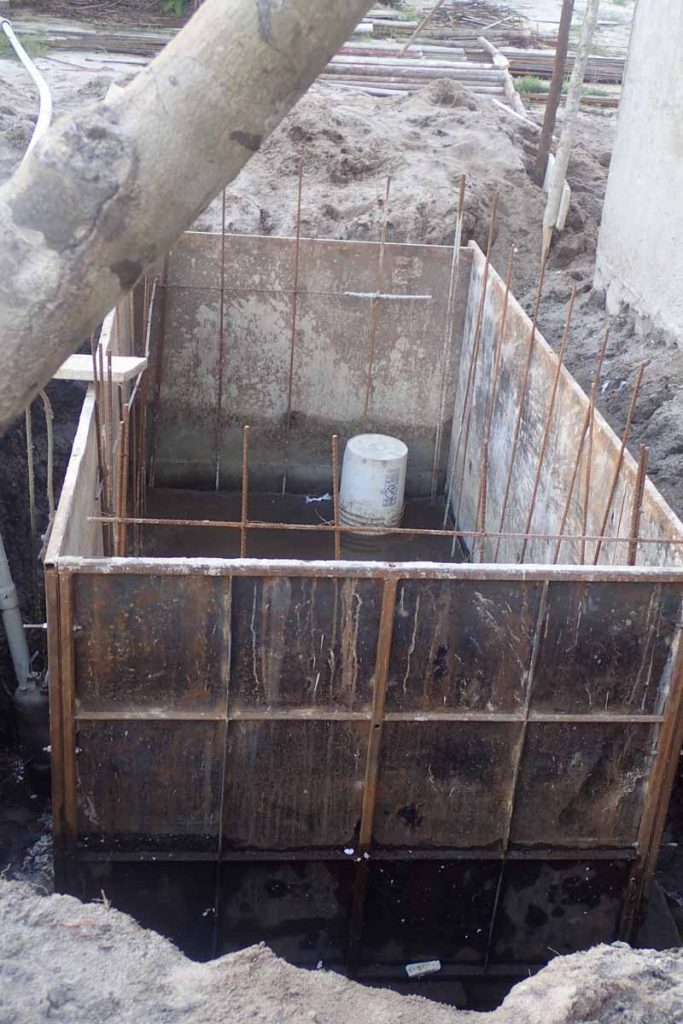

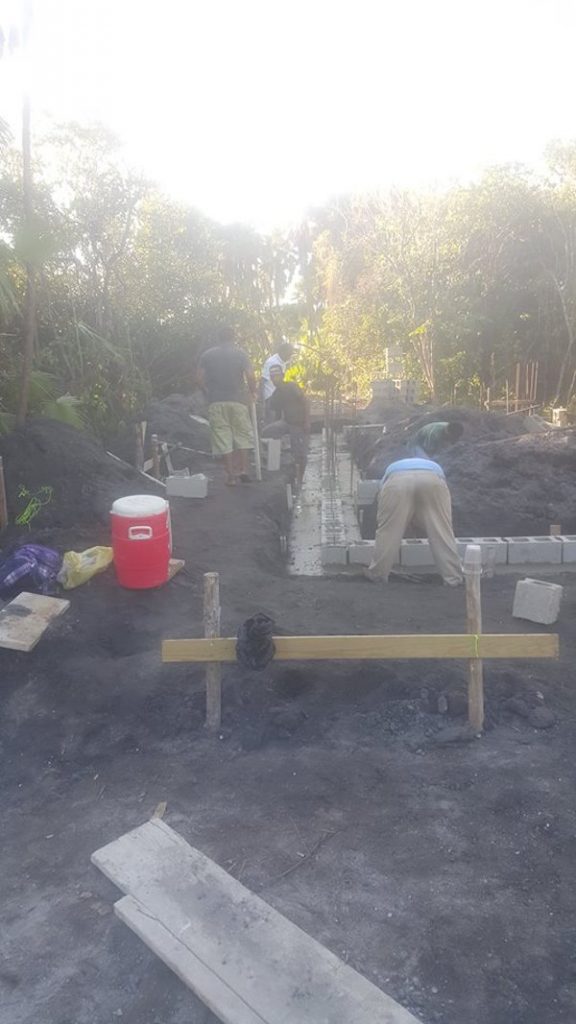

  64. 02/23/2017Central Bank approval received for purchase from foreign entity (Chianti, Ltd.).

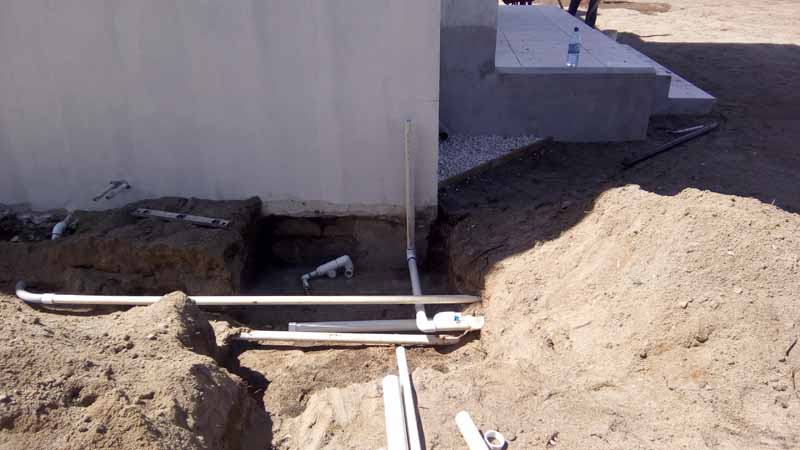

  65. 02/22/2017Utility garage footers & slab work.
  66. 02/21/2017Continued plumbing, electrical and slab prep.

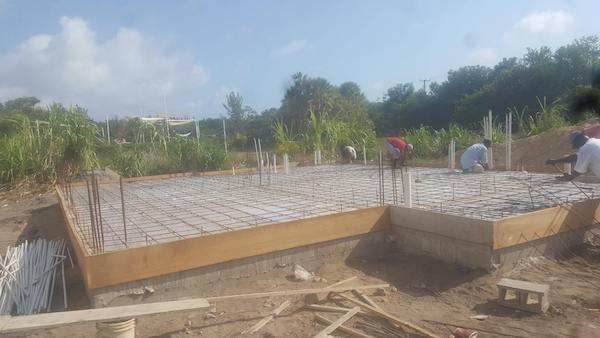

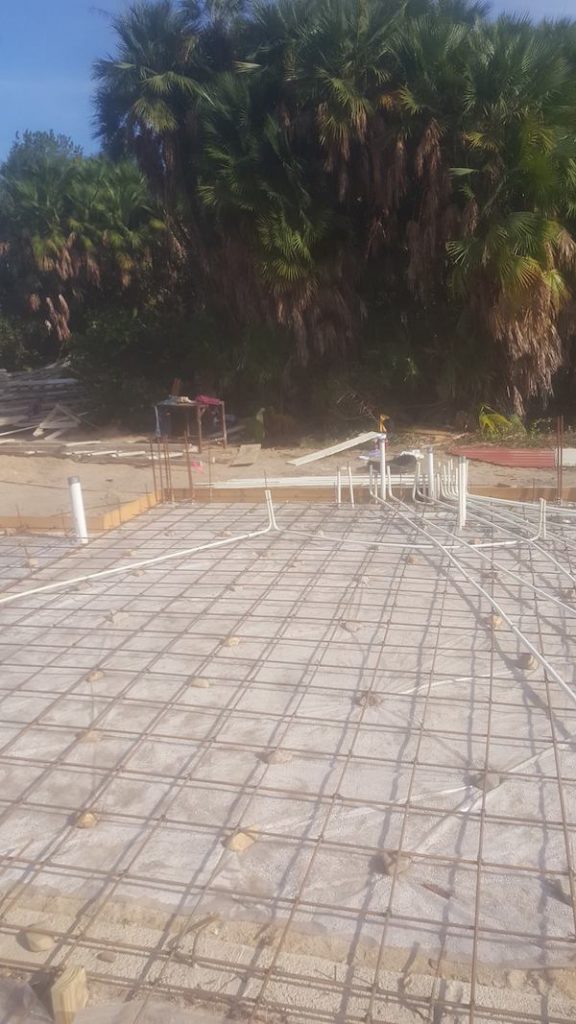

  67. 02/18/2017Continued plumbing, electrical and slab prep.

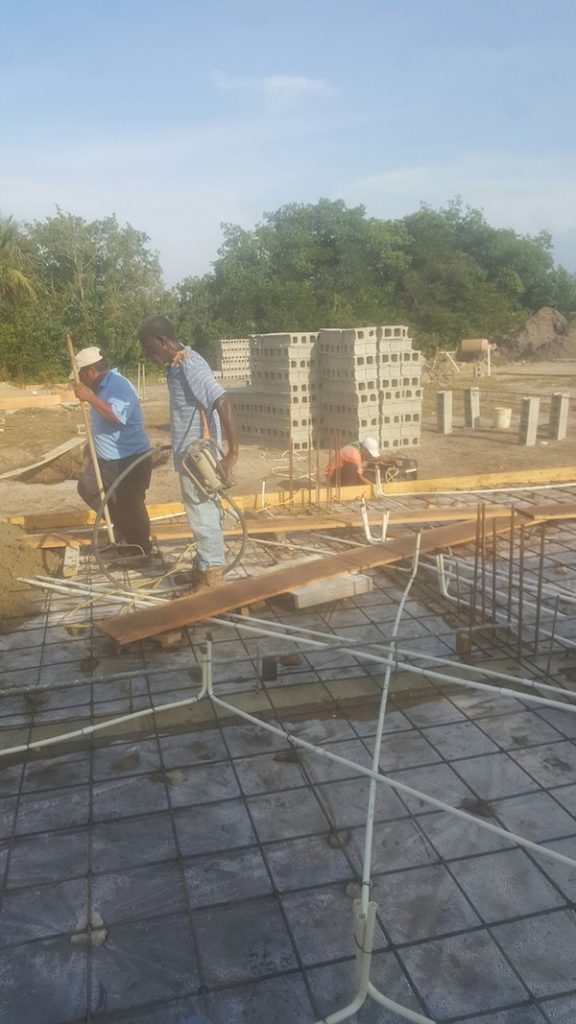

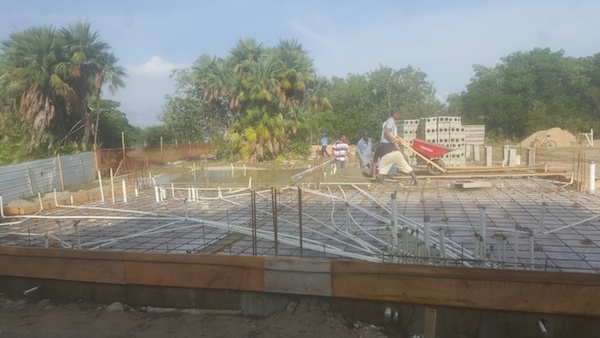

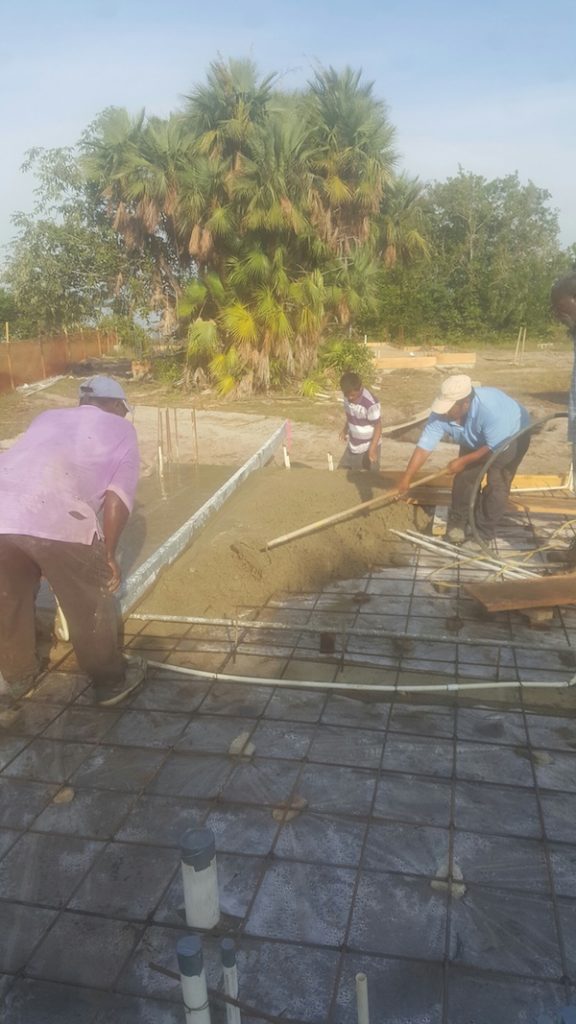

  68. 02/17/2017Plumbing, electrical & slab pours.

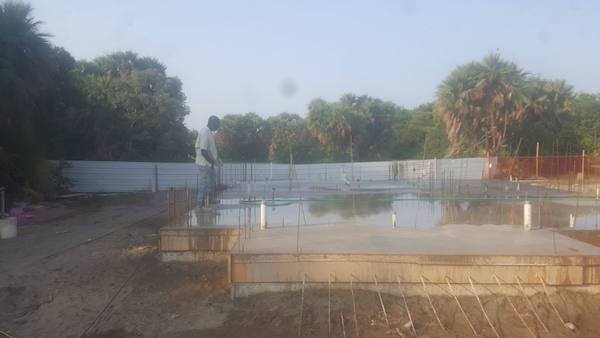

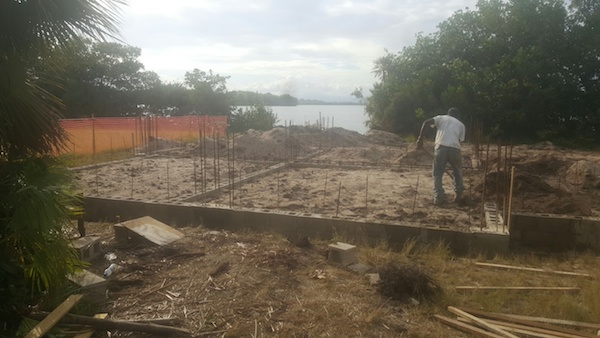

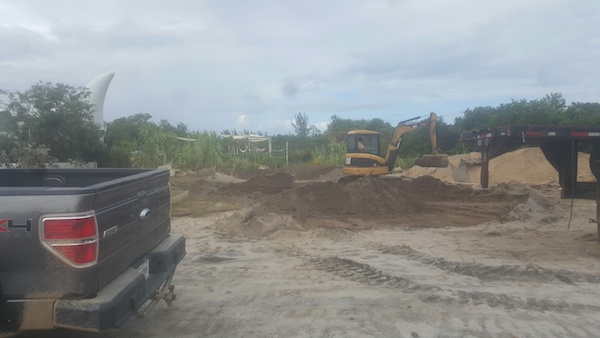

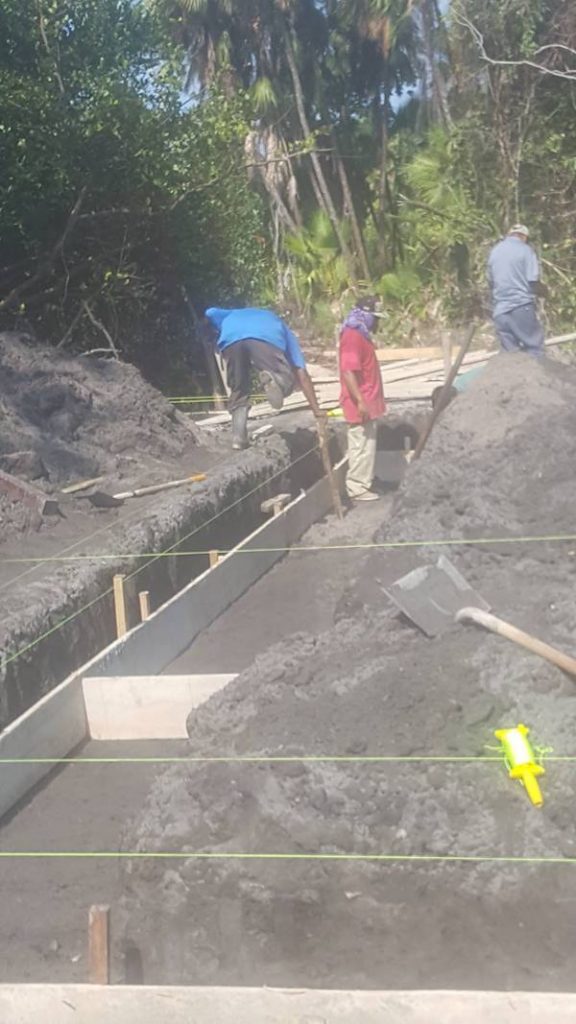

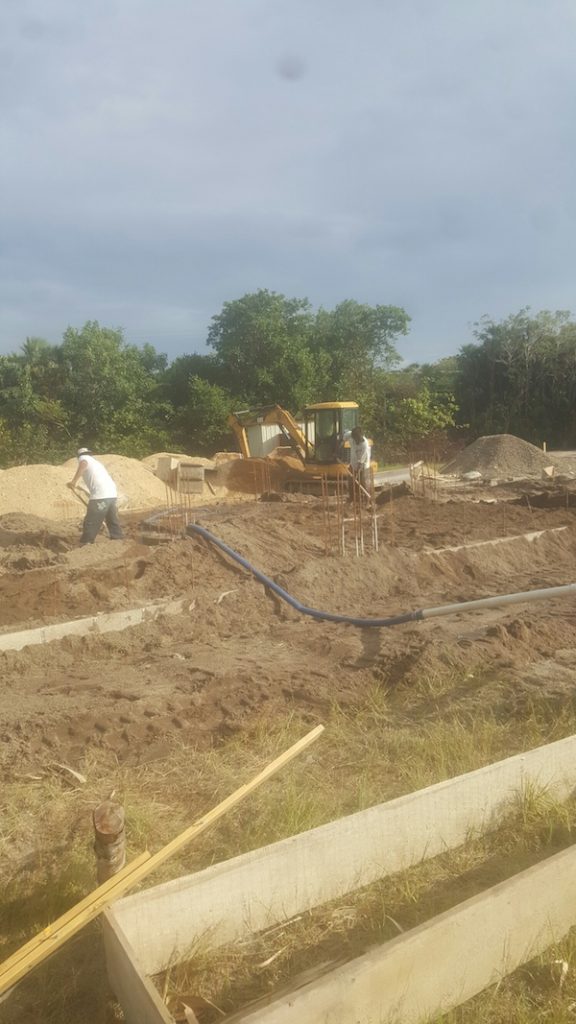

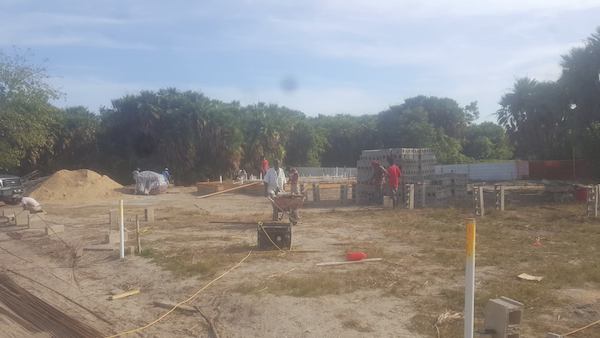

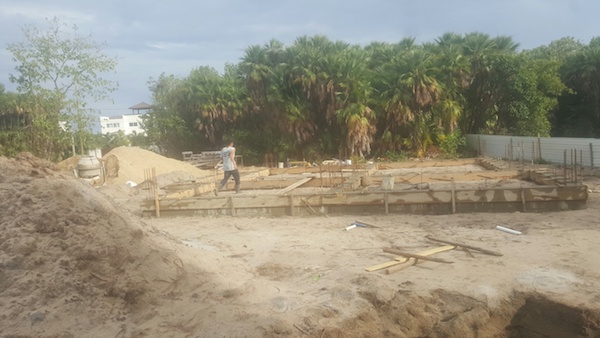

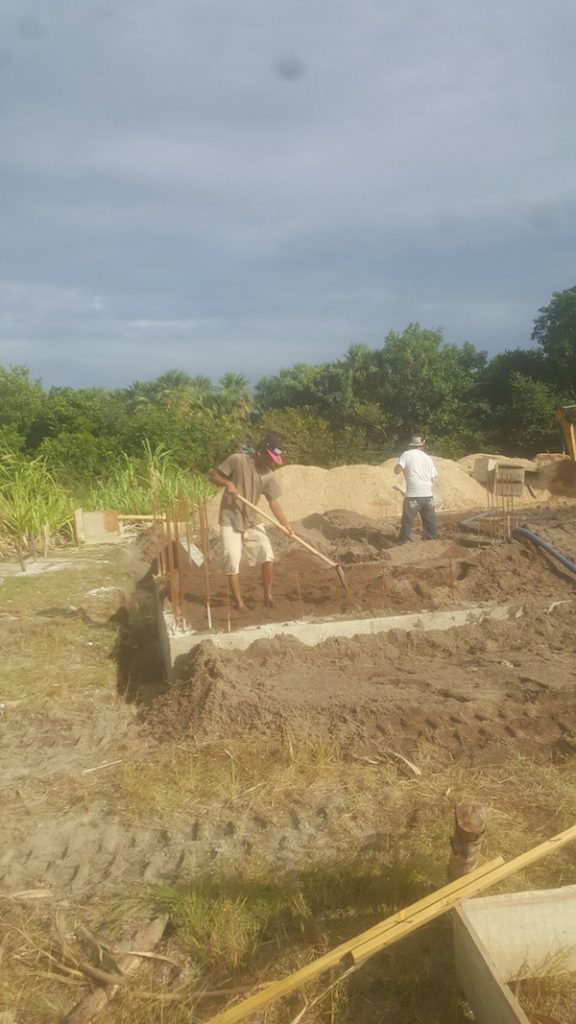

  69. 02/16/2017Plumbing, electrical & preparing for slab pours.

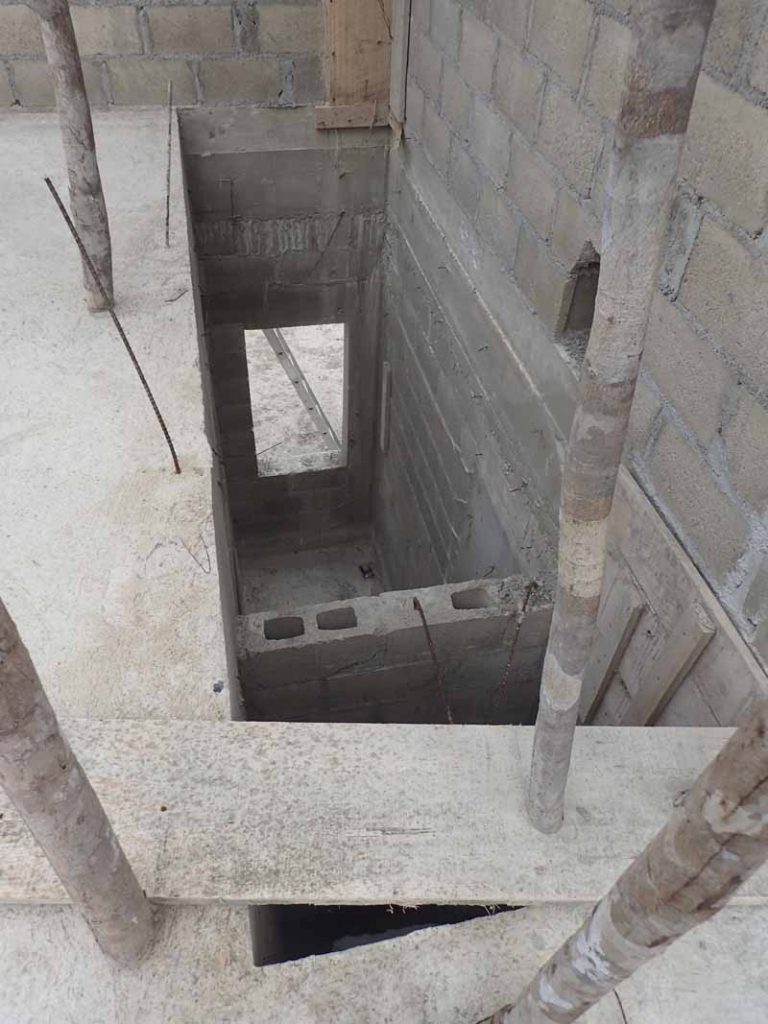

  70. 02/06/2017Backfill & foundation work.

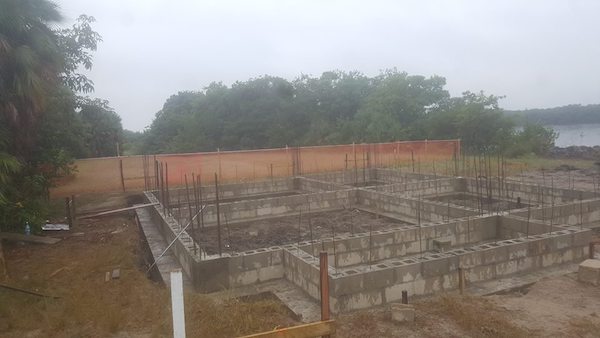

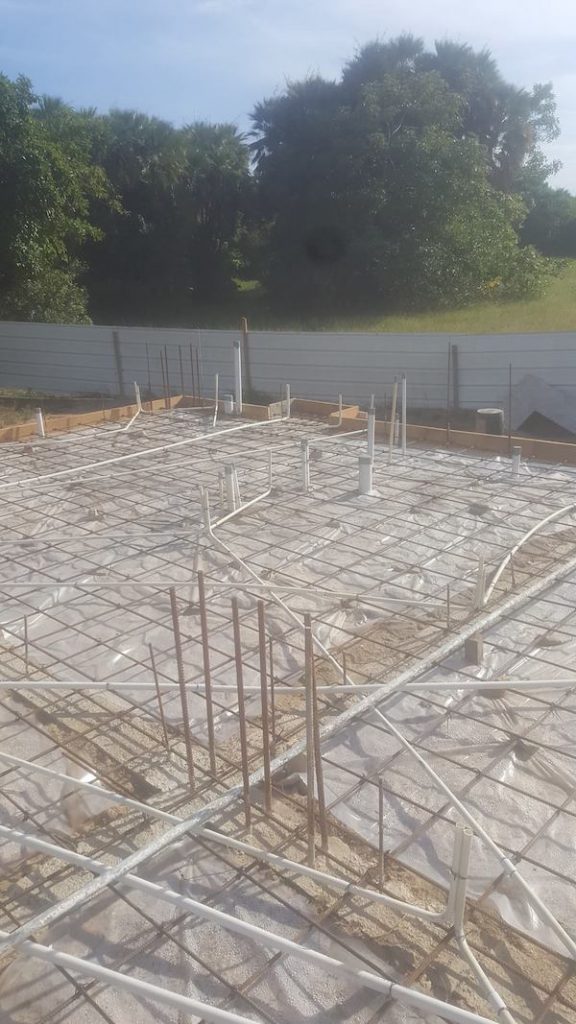

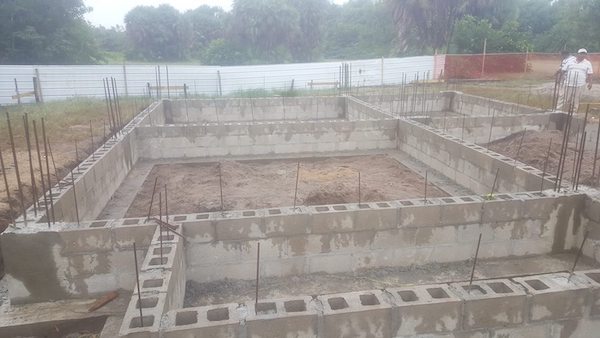

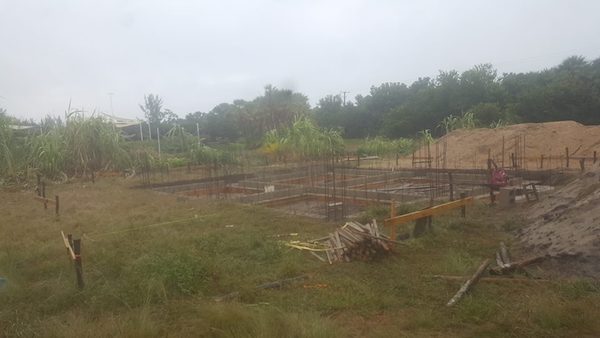

  71. 02/04/2017Continued foundation work.
  72. 02/01/2017Block to ground floor slab.

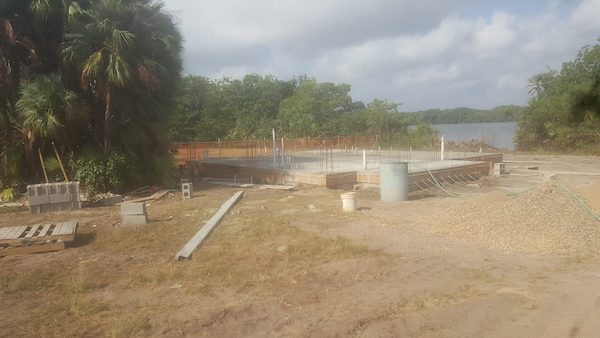

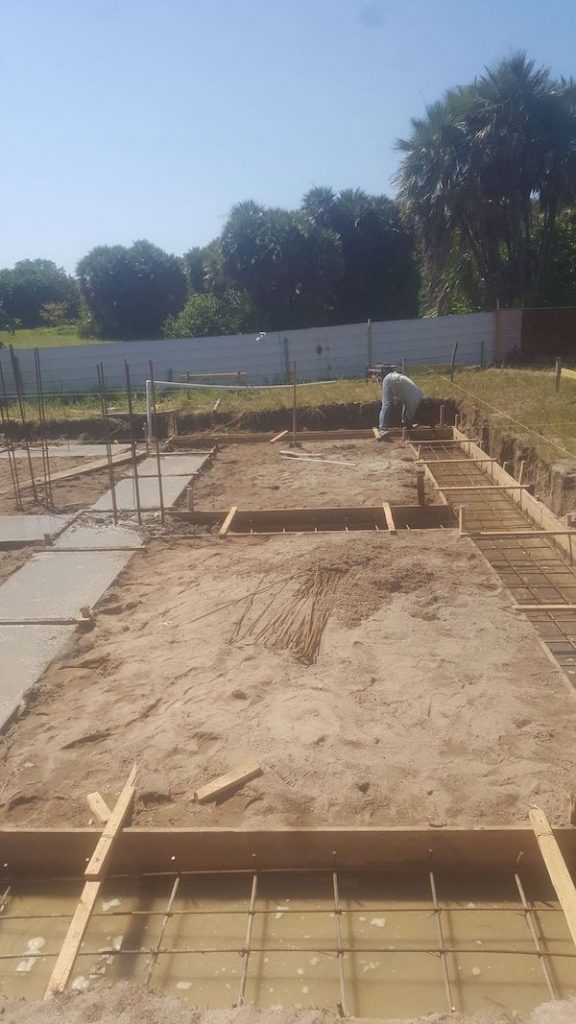

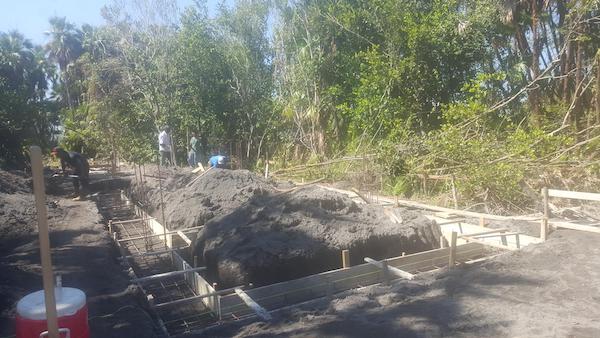

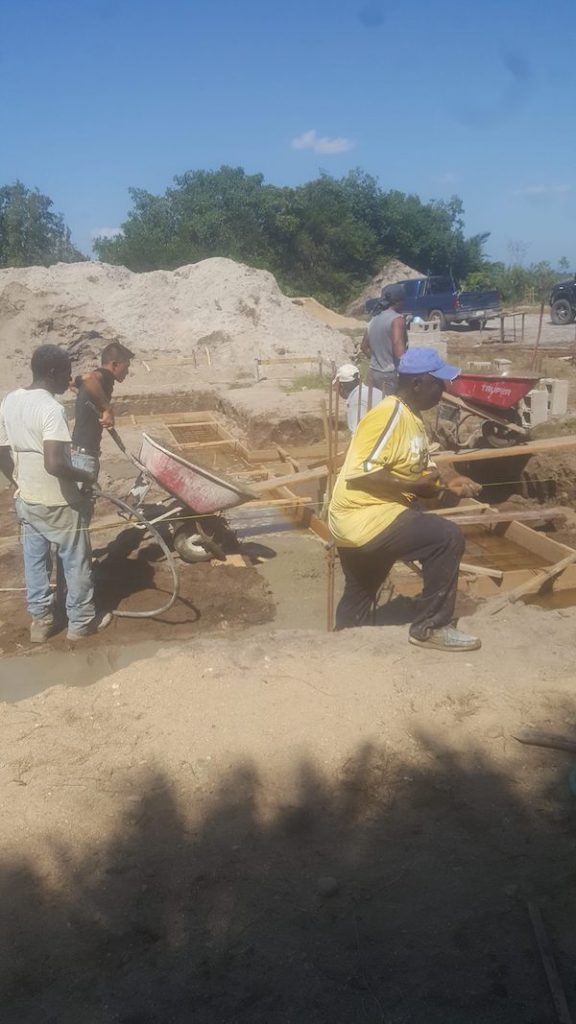

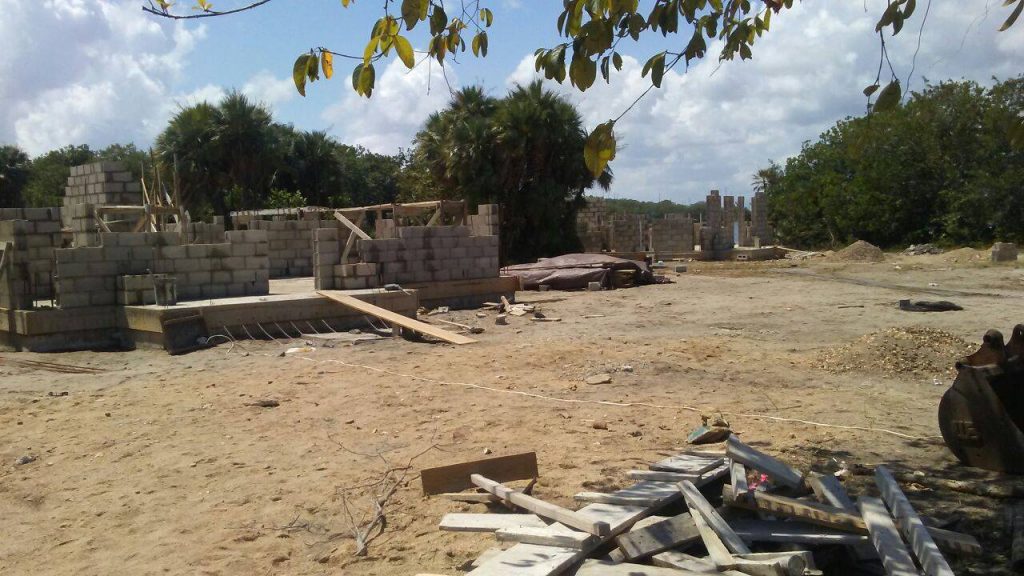

  73. 02/01/2017Plans finalized by architect.

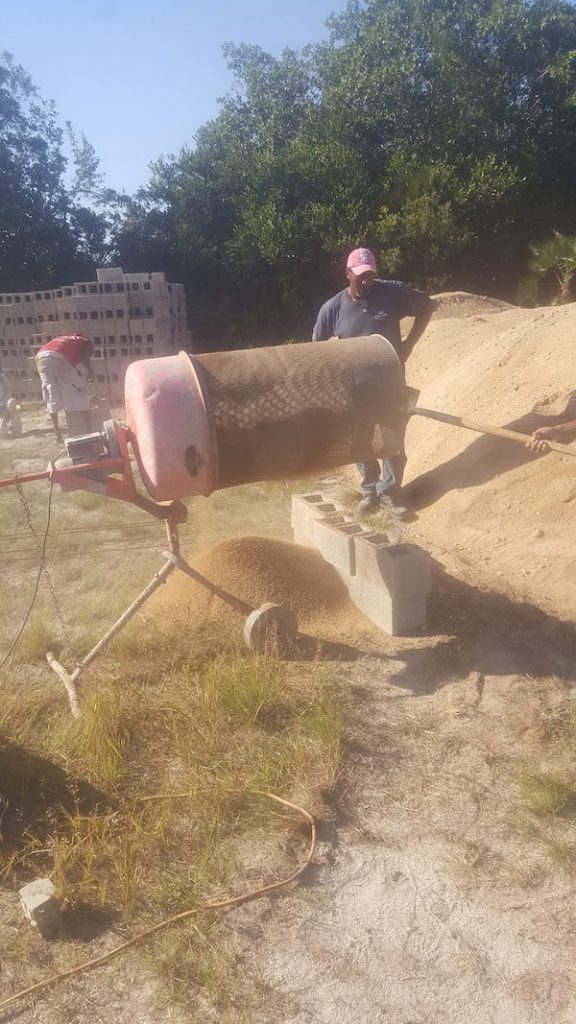

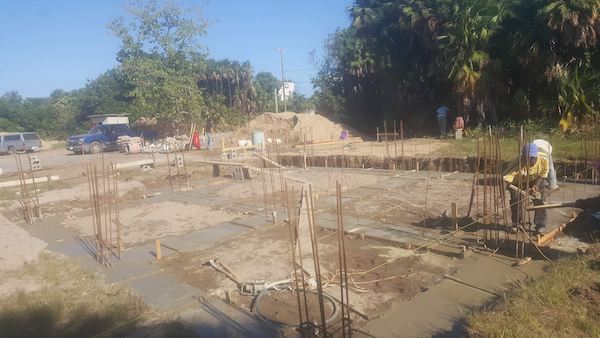

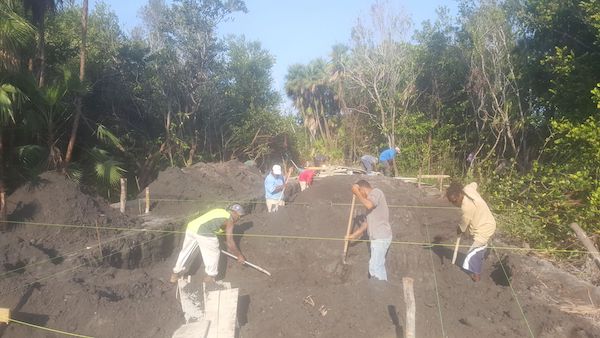

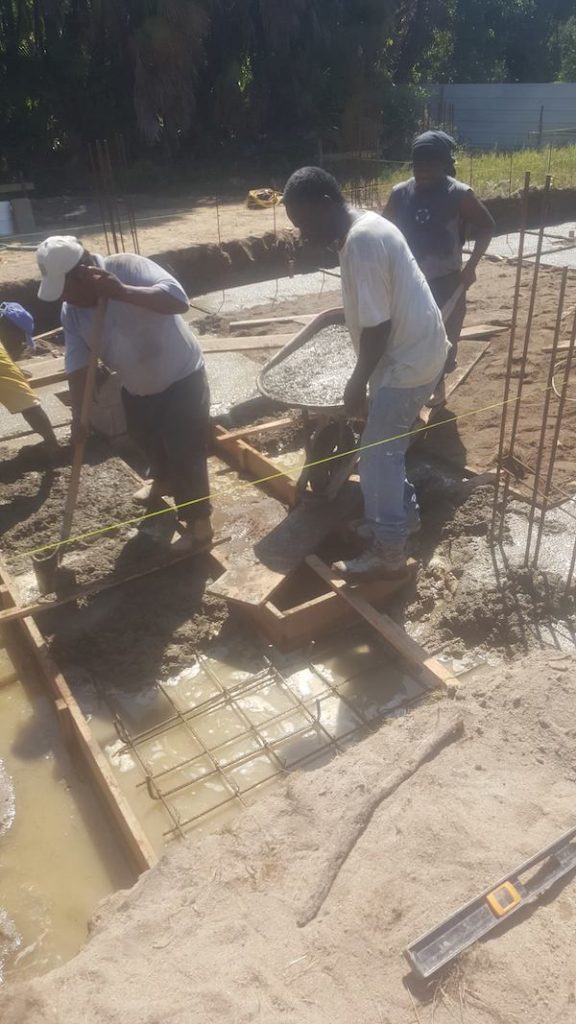

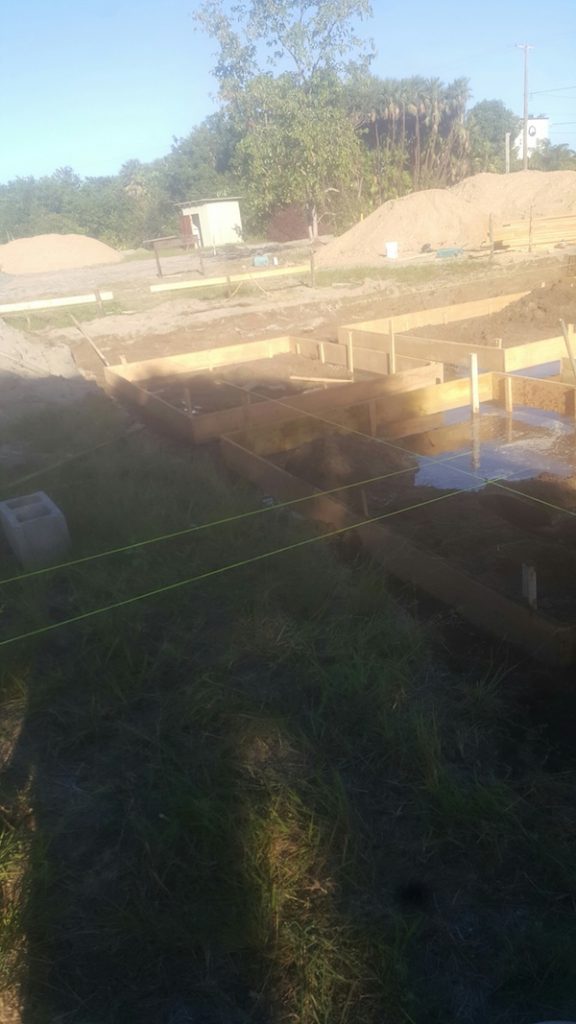

  74. 1/24-25/2017Foundation work.
  75. 01/19/2017Laying out forms for foundations.

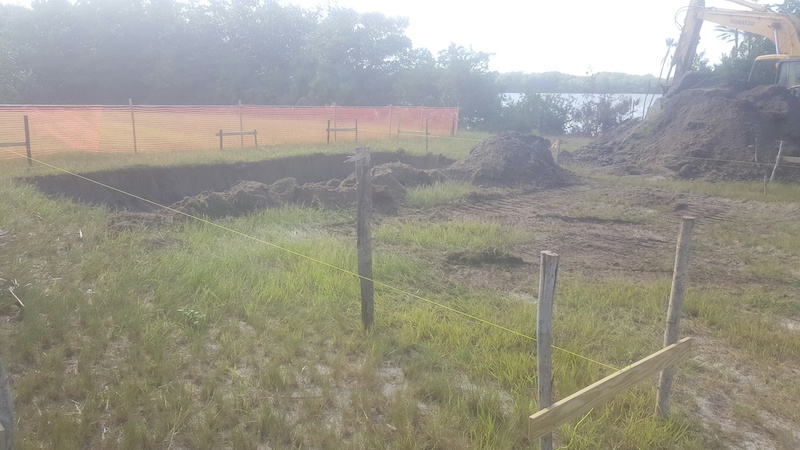

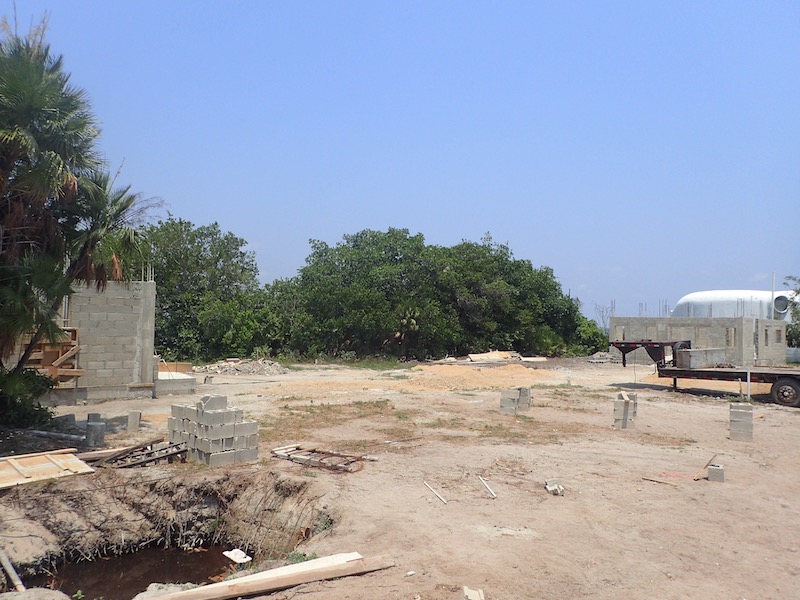

  76. 01/08/2017+Material acquisition & rain.
  77. 01/07/2017Broke ground.
  78. 12/29/2016Sited houses on property.
  79. 12/20/2016Lagoon’s Edge, Ltd. incorporated.
  80. 12/15/2016+Iterative process on house plans.
  81. 12/15/2016Keila Martinez, Architect hired.

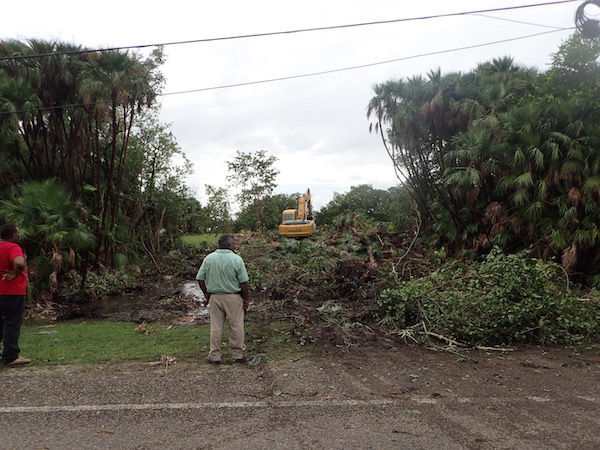

  82. 12/13/2016Signed construction contracts with MSG Construction.
  83. 12/12/2016Cut road into property.
  84. 12/11/2016Draft contract from Martin Galvez received.
  85. 12/09/2016Closed on property.
  86. 12/07/2016House plans updated to include 3rd bedroom.
  87. 12/05/2016Final quote on houses received from Martin Galvez.
  88. 11/28/2016+Title verification & legal work.
  89. 11/26/2016Offer accepted.
  90. 11/25/2016Second offer on property made.
  91. 11/20/2016+Alternatve properties investigated.
  92. 11/20/2016Preliminary house plan identified.
  93. 11/19/2016Initial offer made on property. Offer rejected.
  94. 11/15/2016Martin Galvez informed David Santilli of property for sale..
